Data center profile · Shippingport, Beaver County, Pennsylvania

Aligned Project Phoenix (Shippingport)

Aligned's planned 2 GW gas-powered campus at the former Bruce Mansfield coal plant in Pennsylvania, groundbreaking Sept. 2026; no tenant or air permit on record.

Site work under way. Aligned closed the land purchase, won borough zoning approval and held a groundbreaking on Sept. 10, 2026, and blasting and earthwork were running into Oct. 2026. No tenant, IT capacity, completion date or air permit for the on-site power is on record.
Former Bruce Mansfield plant parcel (main build site), Satellite image, July 30, 2025
2 GW
campus size, Aligned's figure
three buildings; Aligned has not called it IT capacity
2,550 MW
neighboring Shippingport Power Station (separate owner): applied for in PJM, not dedicated to the campus
company figure; an environmental group's report cites 3,641 MW
$10B
stated capital cost
company figure for the campus
$223M
land purchase, July 2026
about 650.9 acres from Frontier (press)
OperatorAligned Data Centers (owner and operator); site and power plant owned by the Frontier Group
CustomerNone announced; a speculative build with no lease or letter of intent on record
Planned IT capacity1.6 GW at full build-out (our estimate from the company's 2 GW campus power figure)
First building in serviceOur estimate: 2028 (range 2028 to 2029).
Next stepGas lateral for the neighboring power plant expected in service late 2026
From orbit

The site from above

Satellite overview1
Satellite image, July 30, 2025. Pin: Former Bruce Mansfield plant parcel, main build site.
From orbit

Former Bruce Mansfield plant parcel

Satellite views of the same ground on Nov. 10, 2022 and July 30, 2025. Drag to compare.

after
before
◀ Satellite image, Nov. 10, 2022Satellite image, July 30, 2025 ▶
Quarter by quarter

Watch the site change

One clear satellite frame per quarter, October 2025 to October 2026. Drag the slider or press play.

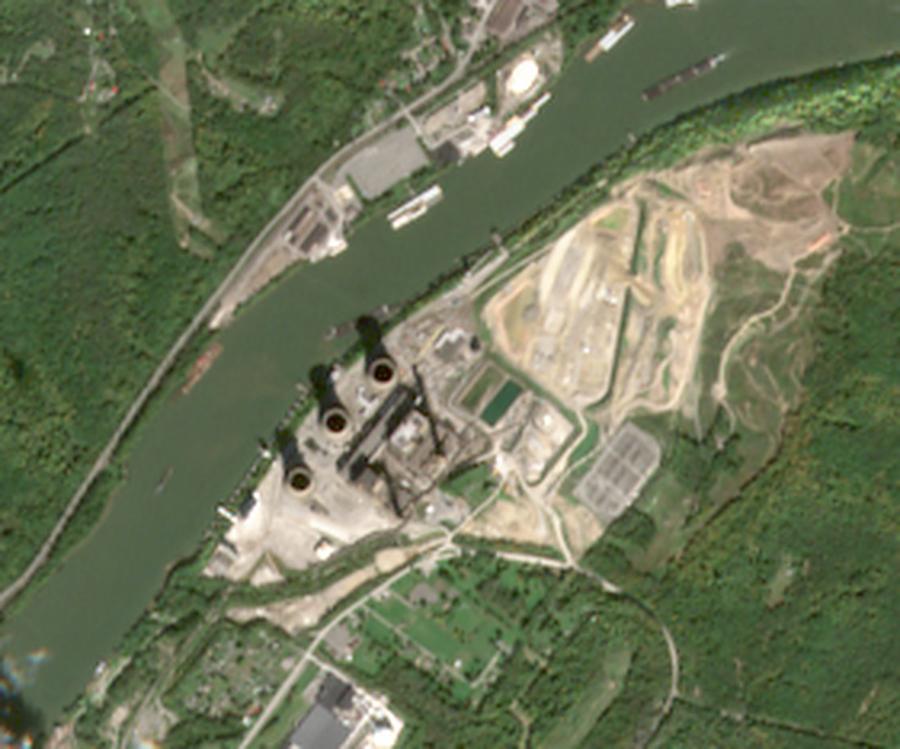

Satellite view of the campus, Oct. 4, 2026

Sentinel-2 satellite, 10 m resolution (coarser than the photos above).
Power

Power and the grid

Sources on record, size not disclosed
Related generation and energy contracts (context, not added to campus supply)
Not used, not on record, or dropped

Getting on the grid

Who supplies what, what it costs, and what is still not public.

  1. July 15, 2025
    Power plant conversion announced
    Frontier announces the Bruce Mansfield coal-to-gas conversion and a then-unnamed data center partner. Company · July 2025
  2. Nov. 7, 2025
    Gas lateral authorized
    FERC authorizes the National Fuel Gas Shippingport Lateral; construction began in March 2026. SEC filing · March 2026
  3. April 27, 2026
    New grid application
    After its first PJM request was withdrawn for a missed milestone, Frontier files a new one for the power station. Company · Oct. 2026
  4. As of Oct. 2026
    No air permit found
    No state application or permit for the campus fuel cells appears in any source checked. see Permits
  5. Not set
    Power supply deal: none disclosed
    No agreement between Aligned and the power station owner has been made public. News report · Oct. 2026
Queue positions on record
  1. Oct. 19, 2026
    PJM queue position
    2,550 MW, application submitted Company · Oct. 2026

Grid upgrades

No grid upgrade for this campus's load is on record. Related grid records in the area:

What is next door

campus0.02 km · 345 kV+ transmission line0.62 km · substation1.92 km · 138 kV transmission line14.23 km · gas pipelinecampus1234
  1. 10.02 km · 345 kV+ transmission line
  2. 20.62 km · substation
  3. 31.92 km · 138 kV transmission line
  4. 414.23 km · gas pipeline

Distances from mapped lines and plants. OpenStreetMap · Oct. 2026

Is it running?

Evidence from space

NO2 over the site, net of the rural background, was about the same in July–September 2026 (3 µmol/m²) as a year earlier (3), and the rural background fell 28% (34 to 25). The satellite sees no new combustion large enough to stand out here. On record here: Campus natural-gas fuel cells, proposed. No rise fits a plant that is not running yet, or runs little; it does not prove either.

See all campuses checked →

NO2 over the campus and over open country (µmol/m²)
020406080Jan 2025AprJulOctJan 2026AprJulOctOver the campusOpen country
020406080Jan 2025JulJan 2026JulOver the campusOpen country
Lines: 7-day (daily) / 3-week (weekly) averages; gaps from cloud filled by straight-line interpolation; dots are raw readings. Shaded: July–September 2025 and 2026, averaging 3 and 3 µmol/m² above open country (0.8×).

What else could explain it

How this works: the Sentinel-5P satellite measures NO2 in the air over every point on Earth once a day, around 1:30 p.m. local time, in pixels about 5.5 by 3.5 km. NO2 comes from burning fuel (turbines, engines, traffic, power plants), so a rise over a site that open country does not share points to new combustion there. It shows combustion activity, not megawatts. The site box is about 15 km across; the background box is open country about 55 km away. We use only high-quality readings and drop days or weeks when cloud hides more than half of either box. Data: Copernicus Sentinel-5P (ESA), processed with the Copernicus Data Space Ecosystem Sentinel Hub statistics service.

Permits

Permits checklist

1 withdrawn · 3 granted · 2 checked, nothing on file

Approvals a campus like this normally needs (including an air permit for backup or on-site generators), and what we found.

Risks

What could slow it down

Money

Money on record

$10B
stated capital cost of the campus
company figure Company · Sept. 2026
$223M
land purchase
closed July 2026 (press) News report · July 2026
Land assembly

3 recorded land documents for the campus company in county records (June 2022 to Nov. 2025); 3 list a price. 2 sales or conveyances by the campus company or to public bodies are not listed. Parcel counts come from the deed; acreage is not recorded.

Timeline

What happened, and what is due

SitePaper trailConstructionPowerPermitsMoneyLegalUpcoming
  1. June 1, 2022
    Site Frontier's Shippingport Industrial Park LLC records a deed for 15 parcels at the former plant site from Energy Harbor Generation LLC, $175,000 (county deed records) County deed records · June 2022
  2. July 15, 2025
    Power Frontier announces the coal-to-gas conversion of the Bruce Mansfield plant and a data center partner Company · July 2025
  3. Aug. 29, 2025
    Permits National Fuel Gas files for FERC approval of the gas lateral SEC filing · March 2026
  4. Nov. 7, 2025
    Permits FERC authorizes the gas lateral SEC filing · March 2026
  5. Feb. 2026
    Permits Borough council holds a hearing and approves Aligned's conditional use News report · Feb. 2026
  6. March 2026
    Construction Construction of the 7.5-mile gas lateral begins SEC filing · March 2026
  7. March 2026
    Permits Council adopts its written decision approving the campus with conditions News report · March 2026
  8. July 2026
    Money Aligned closes the land purchase, about 650.9 acres for roughly $223M (press) News report · July 2026
  9. July 21, 2026
    Money AIP, MGX and BlackRock GIP complete the roughly $40B purchase of Aligned Company · July 2026
  10. Sept. 10, 2026
    Construction Aligned breaks ground on the 2 GW campus with Holder Construction and Kokosing Company · Sept. 2026
  11. Sept. 28, 2026
    Construction Blasting and earthwork under way at Gate 17, with a schedule running to Oct. 16 Company · Oct. 2026
  12. Dec. 2026
    Power Gas lateral due in service (next obligation on record) SEC filing · March 2026
Construction activity

Building activity by quarter

Since Feb. 2022: 2 FAA filings (July 2026): tallest crane 395 ft (July 2026); 74 satellite captures.

FAA filings
Satellite
’22
’23
’24
’25
’26
Dot size: records in the quarter, largest = 6. Two-digit years mark each first quarter.
The buildings

Specs

650.9 acres
campus land bought in July 2026 (press); the Frontier site is larger
3 buildings
about 2 million sq ft in total (press)
55 to 65 dBA
operating sound at the nearest home, per Aligned's public commitment
3,000 + 640
construction jobs and full-time jobs claimed by Aligned
Who is involved

Owners, partners and builders

Owners and developers
  • Aligned Data Centers: developer, owner and operator
  • AI Infrastructure Partnership, MGX and BlackRock GIP: Aligned's owners since July 2026
  • The Frontier Group of Companies: seller of the land and owner of the power station
  • Macquarie Asset Management: Aligned's former majority owner
Power and gas
  • Shippingport Power Station, LLC: owner of the coal-to-gas conversion
  • National Fuel Gas Supply: builder of the gas lateral
  • EQT: intended gas supplier
Builders
  • Holder Construction and Kokosing Industrial: general contractors
  • Wood Group: owner's engineer for the power station
Decision-makers
  • Shippingport Borough Council: granted conditional use
  • Pennsylvania DEP: air permits (none found)
  • PJM: grid interconnection for the power station
Still unknown

Open questions

Where this comes from

366 records from 35 documents

Drawn from news reports, company statements, public and commercial datasets, securities filings, state agency records and satellite captures, each kept with its date and source. The bar shows documents by type.

News report 11Company 10Dataset 6SEC filing 4State agency 4Satellite 1
Evidence

Every quote behind this page

Grade key: A = the primary record itself (permit, filing, exhibit) · B = a dated official statement · C = news reporting. Map distances are our own measurements on OpenStreetMap and carry no grade. Allegations in lawsuits are marked as such in the quotes.

Power (49)
  • Gas lateral: National Fuel Gas Supply Corp - Shippingport Lateral Project, FERC Docket CP25-541-000 (prior-notice authorization Nov 7, 2025)
    “filed an application with FERC under the Commission's prior notice regulations on August 29, 2025. The project obtained FERC authorization on November 7, 2025”
  • On-site generation: 2,550 MW
    “Shippingport Power Station submitted application for PJM Cycle 01 for power delivery by Q4 2028 / Q1 2029 timeline”
  • generator interconnection request: application submitted (2026)
    “Re-establishment of interconnection with PJM, the Regional Transmission Operator ("RTO"), for testing each 850 MW (net) steam turbine generator at full load”
  • Owner companies: Aligned site-owning LLC not publicly identified; campus land acquired Jul 2026. Power block owner: Shippingport Industrial Park LLC (Frontier)
    “Shippingport Industrial Park LLC (SIP) - Property Owner”
  • On-site generation: 2,550 MW
    “Project to deliver 2,550 Firm MWs to PJM network with three (3) 850 MW existing base load steam turbines, interconnection point, and associated infrastructure”
  • On-site generation: not stated
    “The campus is designed to feature natural gas-fed fuel cell technology”
  • On-site power technology: Fuel cells (natural gas) - campus behind-the-meter generation
    “The campus is designed to feature natural gas-fed fuel cell technology, a highly efficient, low-carbon, and virtually non-polluting alternative for large-scale power generation”
  • Generating units on the permit: SPS (adjacent): 3 existing GE steam turbine-generator sets (~850 MW each) to be refurbished; 3 supercritical Foster Wheeler boilers (915 MW gross each) converted from coal to gas
    “Conversion of coal plant decommissioned in c. 2019 (consisting of three super-critical Foster Wheeler coal-fired boilers with 915MW gross output each) to burn natural gas”
  • Role of the on-site plant: prime - dedicated onsite source; two of three facilities designed for full grid independence
    “Two data centers on the campus will achieve full grid independence”
  • Backup generators: Backup generation equipment planned (critical-grade silencing, acoustic enclosures, use restricted to testing/emergencies); count and capacity not disclosed
    “Chillers & backup power generation equipment will feature critical-grade silencing technology; backup power generation equipment will also be housed within acoustically treated enclosures”
  • Stage: Under construction (site work) with a funded top-tier sponsor and closed land purchase, but pre-vertical: no named tenant, no disclosed IT MW or campus COD, campus fuel-cell capacity undisclosed, and the adjacent
    “we are adjusting our site operations and rescheduling the start of our blasting activities to Monday, September 28”
  • Paper or real: REAL: land closed (~$223M), conditional use granted, FERC-authorized gas lateral under construction since Mar 2026 ($12.8M CWIP at Mar 2026; $27.3M at Jun 2026), groundbreaking held, blasting under way. PA
    “construction commenced in March 2026. As of March 31, 2026, approximately $12.8 million has been capitalized as Construction Work in Progress for this project”
  • Nearest substation: 0.62 km - Mansfield Substation (FirstEnergy Generation) at 40.63406,-80.40834
    Measured on OpenStreetMap map data.
  • Nearest power line of 345 kV or more: 0.02 km - 345 kV switchyard lines at the plant (named: Mansfield - Hoytdale 345kV, American Transmission Systems, 0.08 km
    Measured on OpenStreetMap map data.
  • Nearest power line of 138 kV: 1.92 km - 138 kV line (Duquesne Light)
    Measured on OpenStreetMap map data.
  • Nearest gas pipeline: 14.23 km - gas pipeline (nearest named: Tennessee Gas Pipeline - Pittsburgh Spur Line at 19.22 km)
    Measured on OpenStreetMap map data.
  • generation interconnection request: withdrawn - customer milestone not met (Reliability Resource Initiative request for the SPS conversion)
    “Status: Withdrawn - Customer Milestone Not Met - Project ID: AH1-674”
  • generation interconnection request: submitted by Frontier before Apr 27, 2026 (owner timeline); interconnection agreement being re-established; owner expects PJM interconnect complete 2029
    “PJM Cycle 1 Submission prior to April 27th, 2026”
  • Frontier makes its PJM Cycle 1 submission for SPS after the AH1-674 Reliability Resource Initiative request was withdrawn
    “PJM Cycle 1 Submission prior to April 27th, 2026”
  • NFG Line N System Upgrade: a 200,000 Dth/day path to a new Shippingport Industrial Park interconnection within a 294,000 Dth/day project, targeted in service Nov 2028 - park/portfolio gas context, NOT campus capacity
    “Path #2: 200,000 Dth/d - Provides firm south-to-north transportation service from both new and existing receipt points on Line N south of National's Buffalo Compressor Station, with delivery to a new interconnection at the Shippingport Industrial Park”
  • Stated campus size: 2,000 MW
    “a new 2 GW data center campus located in Shippingport, Pennsylvania. Spanning three facilities”
  • Utility service: not stated
    “Project Phoenix will use its own dedicated onsite power source rather than the local electrical grid”
  • Phases: 3 facilities at full build; per-phase buildings, MW and COD not disclosed
    “Spanning three facilities, the development will meet robust regional demand for digital infrastructure”
  • Cooling: Closed-loop, air-cooled heat rejection; zero water for operational cooling
    “Engineered to require zero water for operational cooling, each Project Phoenix data center utilizes an advanced closed-loop system that continuously recycles pure, deionized water”
  • Utility: none - behind-the-meter supply; no retail utility service
    “Project Phoenix will use its own dedicated onsite power source rather than the local electrical grid”
  • Power plan: onsite - behind-the-meter dedicated generation; no grid load; surplus export only via adjacent SPS
    “Project Phoenix will use its own dedicated onsite power source rather than the local electrical grid”
  • Stated campus size: 2,000 MW
    “today announced the groundbreaking of "Project Phoenix," a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • Interconnection status: Behind-the-meter by design (PJM, Beaver County PA): campus uses a dedicated on-site power source rather than the local grid, groundbreaking Sep 10, 2026; the supplying Shippingport Power Station r
    “Project Phoenix will use its own dedicated onsite power source rather than the local electrical grid”
  • generator interconnection request: Withdrawn - Customer Milestone Not Met
    “This queue application likely represents an early interconnection request for the coal-to-gas conversion of the Bruce Mansfield coal plant, which retired in 2019”
  • ATSI supplemental project S3715.1 (TEAC 7/6/2025) rebuilds the 345 kV lines on this site's export path: replace 33 steel structures on the Beaver Valley-Hanna and Hanna-Mansfield lines and install new conductor on ~6.9 m
    “At Beaver Valley-Hanna 345 kV line and Hanna-Mansfield 345 kV line, replace 33 steel structures from Structure 6270 to Structure 6632.”
  • Grid operator: PJM
    “contribute over one gigawatt of excess capacity back to PJM Interconnection, the largest power grid operator in the United States”
  • Gas supplier: EQT Corporation - intended supplier to Shippingport Power Station (~800 MMcf/day)
    “EQT Corporation (NYSE: EQT) (EQT), the largest integrated natural gas producer in the U.S., intends to serve as the new plant's natural gas supplier”
  • Frontier announces the Bruce Mansfield coal-to-gas conversion as Shippingport Power Station and a secured (then unnamed) co-located data center partner
    “FGC has secured a partner to build a collocated data center facility to support America's demand for AI infrastructure”
  • The coal plant formerly on this site was deactivated through PJM: PJM's Independent Market Monitor records Mansfield Units 1 and 2 (830.0 MW each, steam-coal, ATSI zone) retired February 5, 2019, and FirstEnergy Solution
    “the two 830.0 MW Mansfield coal fired steam units owned by FirstEnergy Corporation and located in the American Transmission Systems Incorporated (ATSI) Zone”
  • IT capacity: not stated
    “Aligned has not characterized the 2-GW campus figure specifically as critical IT load, so the numbers should not be treated as interchangeable”
  • Interconnection status: Campus load: none (behind-the-meter). SPS generation: PJM queue AH1-674 (1,700 MW, Reliability Resource Initiative) WITHDRAWN - customer milestone not met; Frontier then made a PJM Cycle 1 submiss
    “Status: Withdrawn - Customer Milestone Not Met - Project ID: AH1-674”
  • Substation kV: 345 kV
    “Existing 345-kV transmission infrastructure would be reused to reconnect the plant to PJM”
  • Generator maker and model: Not disclosed - fuel-cell supplier and technology not publicly identified
    “Aligned has also not publicly identified several important technical details: the fuel-cell supplier, specific fuel-cell technology, total installed generating capacity”
  • On-site power delivery target: late 2028 / early 2029 (Shippingport Power Station conversion output)
    “Frontier puts the direct investment in the generating project at approximately $1.6 billion and currently targets power delivery around late 2028 or early 2029”
  • Time to service (months): 24-30 months
    “2029 PJM Interconnect is expected to be completed and long term operation of Shippingport Power Station to support the PJM RTO and on site data center campus demands”
  • Site acres: 660 acres
    “First reported by BizJournals, Aligned is planning to develop two natural gas-powered data center buildings within the 660-acre Shippingport Industrial Park”
  • Groundbreaking: Aligned formally broke ground on Project Phoenix on Sep 10, 2026 at the former Bruce Mansfield Power Plant site in the Shippingport Industrial Park; construction partners are Holder Construction and Kokos
    “Project Phoenix will support an estimated 3,000 construction jobs and create an estimated 640 full-time careers for ongoing campus operations”
  • On-site power: The campus will use a dedicated on-site power source - a natural-gas energy campus being redeveloped at the adjacent former Shippingport Power Station (Frontier Group of Companies) - rather than the local
    “Project Phoenix will use its own dedicated onsite power source rather than the local electrical grid”
  • Stated campus size: 2,000 MW
    “today announced the groundbreaking of "Project Phoenix," a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • On-site generation: 3,641 MW
    “Shippingport Power Station (Formerly Bruce Mansfield Power Plant) - New - 2028 - 3,641”
  • Opposition: Environmental Health Project and some local residents oppose on air-quality, noise and lasting-jobs grounds; concerns also noted at the Sep 2026 groundbreaking
    “these facilities will represent increased health risks and limited economic opportunities for people nearby”
  • Environmental Health Project op-ed in the Beaver County Times opposes the campus (air quality, noise, jobs) and notes a construction noise-limit exceedance permission is still needed
    “Although the Shippingport Data Centers have received zoning approval, they still need permission to exceed noise limits during construction”
  • On-site generation: 3,600 MW
    “In total, Frontier said the site will be able to offer up to 3.6GW of behind-the-meter capacity”
  • Announced: Jan. 2026
    “Pittsburgh Business Times: $10 Billion A.I. Data Center Campus, Natural Gas Power Plant Proposed For Former Bruce Mansfield Power Plant Site In Beaver County [Shippingport Boro Approved Jan. 28, Another Hearing To Be Set]”
Money and contracts (34)
  • precedent agreement (gas transportation): scope 205,000 Dth/day - 100% of Shippingport Lateral Project capacity Dth/day
    “Supply Corporation has executed a Precedent Agreement with Shippingport Power Station, LLC, the facility developer, for 100% of the capacity for the Shippingport Lateral Project”
  • precedent agreement (gas transportation): conditions precedent By definition a precedent agreement converts to a service agreement only after specified conditions precedent occur; the operative transportation service agr
    “an agreement between a pipeline company and a potential customer to sign a service agreement after specified events (called conditions precedent) happen, usually within a specified time”
  • precedent agreement (gas transportation): termination NOT DISCLOSED - no termination, cancellation, term-length or rate provisions for the precedent agreement appear in NFG's 10-Q discussion (finding)
    “Supply Corporation has executed a Precedent Agreement with Shippingport Power Station, LLC, the facility developer, for 100% of the capacity for the Shippingport Lateral Project”
  • precedent agreement (gas transportation): project cost / in-service 57000000 USD
    “an approximately 7.5 mile pipeline lateral from its existing Line N pipeline system to a direct interconnection with the facility with the incremental capacity expected to come online in late calendar 2026 and an estimated capital cost of $57 million”
  • SEC filings: No SEC filing describes Project Phoenix or Shippingport for Aligned (the sponsor is private). The only Aligned-affiliated Form Ds are two $125,000 retail feeder vehicles filed Jan 21, 2026 (Aligned IAD Holdi
    “Aligned IAD Holdings, LLC”
  • Financing: Shippingport Power Station conversion: ~$1.6B direct investment planned by Frontier (SPS LLC) - adjacent power station, not campus financing USD
    “$1.6 Billion coal-to-gas conversion that will generate 2,550 MW of power for the PJM grid”
  • Incentives: None found - no abatement, LERTA, KOZ or PILOT disclosed for the campus; Aligned states the project will generate long-term property tax revenue
    “This project will also generate long-term property tax revenue to support local services”
  • Stated capital cost: 10000000000 USD
    “anchoring an estimated $10B in regional economic investment”
  • General contractor: Holder Construction and Kokosing (Kokosing Industrial)
    “We are honored that Aligned has trusted Kokosing as a partner to bring Project Phoenix to life”
  • state framework pledge: scope Signatory to the PA Ratepayer Protection Pledge; public support for the Governor's Responsible Infrastructure Development (GRID) standards
    “We proudly support Governor Shapiro's GRID standards and are a signatory of the Ratepayer Protection Pledge”
  • state framework pledge: termination / enforceability Voluntary pledge; no published termination, penalty or enforcement clauses (finding)
    “We proudly support Governor Shapiro's GRID standards and are a signatory of the Ratepayer Protection Pledge”
  • Financing: AIP / MGX / BlackRock GIP consortium completed acquisition of 100% of Aligned on Jul 21, 2026 (enterprise value ~$40B), with $5B of additional growth capital commitments - platform-level, not site-specific USD
    “today successfully completed their previously announced acquisition of 100% of the equity in Aligned Data Centers”
  • AIP/MGX/GIP complete the ~$40B acquisition of Aligned from Macquarie, with $5B of growth capital commitments
    “today successfully completed their previously announced acquisition of 100% of the equity in Aligned Data Centers”
  • Land purchase (recorded deed): contract value 223150865 USD
    “Recorded: July 15, 2026 · Price: $223,150,865 · Grantee: ALIGNEDAI PA OWNER LLC · Parcel number: 50-005-0300.000 · Address: 165 ROUTE 3016 · City: SHIPPINGPORT”
  • Financing: $2.58B revolving Devco credit facility closed Mar 26, 2026, secured by an initial collateral pool of six US assets (assets unnamed); 3-year term plus two 1-year extensions. Shippingport is NOT identified as a
    “today announced the closing of a new $2.58 billion credit facility to support the continued rapid expansion of its U.S. data center portfolio”
  • Aligned closes a $2.58B revolving Devco credit facility (platform-level; six-asset collateral pool, assets unnamed)
    “today announced the closing of a new $2.58 billion credit facility to support the continued rapid expansion of its U.S. data center portfolio”
  • Land purchase (recorded deed): contract value 412500 USD
    “Recorded: Nov. 14, 2025 · Price: $412,500 · Grantor: MORELL · Grantee: SHIPPINGPORT INDUSTRIAL PARK LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value 11500 USD
    “Recorded: Nov. 5, 2025 · Price: $11,500 · Grantor: MUIR · Grantee: SHIPPINGPORT INDUSTRIAL PARK LLC · Parcel number: 50-172-0184.000 · Address: RT 168 · City: SHIPPINGPORT”
  • gas supply (stated intent): scope ~800 MMcf/day of Marcellus/Utica gas intended for the power station MMcf/day
    “EQT Corporation (NYSE: EQT) (EQT), the largest integrated natural gas producer in the U.S., intends to serve as the new plant's natural gas supplier”
  • gas supply (stated intent): status / termination No executed supply agreement, term, price or termination provisions disclosed as of Oct 2026; EQT's role is stated as intent only (finding)
    “intends to serve as the new plant's natural gas supplier”
  • Land purchase (recorded deed): contract value 175000 USD
    “Recorded: June 1, 2022 · Price: $175,000 · Mortgage1amount: 27000000 · Grantor: ENERGY HARBOR GENERATION LLC · Grantee: SHIPPINGPORT INDUSTRIAL PARK LLC · Parcel number: 50-005-0300.003 · Address: RT 3016 · City: SHIPPINGPORT”
  • Land purchase (recorded deed): contract value 5377836 USD
    “Recorded: June 1, 2022 · Price: $5,377,836 · Grantor: THE TOLEDO EDISON COMPANY · Grantee: ENERGY HARBOR GENERATION LLC · Parcel number: 50-005-0300.003 · Address: 128 FERRY HILL RD · City: SHIPPINGPORT”
  • Square feet: 2000000 sq ft
    “encompassing as many as three data center buildings totaling nearly 2 million square feet”
  • Tenants: none announced
    “Aligned has not publicly named Project Phoenix's anchor tenant”
  • Tenant status: none announced - speculative build; no LOI, lease or anchor customer disclosed
    “Aligned has not publicly named Project Phoenix's anchor tenant”
  • power supply agreement (Aligned - Frontier/SPS): status - none disclosed No PPA or behind-the-meter supply agreement between Aligned and Frontier/SPS has been disclosed; how campus fuel cells versus SPS steam output divi
    “Aligned intends to use natural-gas-fed fuel-cell generation at the campus”
  • Project Phoenix broke ground Sep 10, 2026 - the campus moved from announcement to active construction with two named general contractors
    “Project Phoenix will support an estimated 3,000 construction jobs and create an estimated 640 full-time careers for ongoing campus operations”
  • Acres: 650.9 acres
    “completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
  • Land control date: July 2026
    “completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
  • Land price: 223000000 USD
    “completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
  • land purchase agreement: purchase price and acreage 223000000 USD
    “completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
  • Aligned closes the purchase of ~650.9 acres from Frontier for ~$223M
    “completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
  • Aligned completes a $1.18B securitization financing (platform-level)
    “July 28, 2026 - Aligned Data Centers Completes $1.18 Billion Securitization Financing”
  • Land acquisition: Aligned completed acquisition of approximately 650.9 acres in July 2026 for about $223 million (per trade-press reporting of the transaction)
    “Aligned reportedly completed its acquisition in July 2026 of approximately 650.9 acres for about $223 million”
Permits and government (19)
  • Crane, 395 ft AGL, for the Aligned Data Center Campus at 40.63283889,-80.4132722: crane case submitted - determined no hazard
    “Aligned Data Center Campus; Crane; 395 ft AGL; Beaver County, PA; Determined - No Hazard”
    FAA · July 2026 · grade A
  • Mobile Crane, 395 ft AGL, for the Aligned Data Center Campus at 40.64211479,-80.: mobile crane case submitted - determined no hazard
    “Aligned Data Center Campus; Mobile Crane; 395 ft AGL; Beaver County, PA; Determined - No Hazard”
    FAA · July 2026 · grade A
  • gas pipeline authorization (prior notice): application filed under prior-notice regulations (Shippingport Lateral Project)
    “filed an application with FERC under the Commission's prior notice regulations on August 29, 2025”
  • gas pipeline authorization (prior notice): authorized; construction commenced Mar 2026; in-service expected late 2026
    “The project obtained FERC authorization on November 7, 2025 and construction commenced in March 2026”
  • FERC authorizes the NFG Shippingport Lateral under prior-notice regulations (application filed Aug 29, 2025)
    “The project obtained FERC authorization on November 7, 2025 and construction commenced in March 2026”
  • asbestos abatement / demolition (former plant): asbestos abatement outside the power block started Mar 2024 per owner timeline; demolition sequencing under way 2025; plant conversion started 2026
    “Asbestos abatement outside of Power Block started on 3/24. Wood Group hired as the owner's engineer”
  • Aligned Data Centers / Shippingport community: Project Phoenix groundbreaking ceremony
    “today announced the groundbreaking of Project Phoenix, a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • gas pipeline construction status: under construction; ~$27.3M capitalized CWIP at Jun 30, 2026 (NFG Q3 FY2026 10-Q, read via filing copy)
    “The project obtained FERC authorization on November 7, 2025 and construction commenced in March 2026. As of June 30, 2026, approximately $27.3 million has been capitalized as Construction Work in Progress”
  • air quality plan approval (SPS coal-to-gas conversion): application reported by EIP at 3,641 MW (Jul 2026 report); NO record found in PA DEP eFACTS (Synapse check, 2026); permit number NOT verified; not issued
    “Shippingport Power Station (Formerly Bruce Mansfield Power Plant) - New - 2028 - 3,641”
  • air quality permit (campus fuel-cell generation): none found - no application or permit for Aligned's fuel-cell generation located in any searched source as of Oct 2026
    “The campus is designed to feature natural gas-fed fuel cell technology”
  • Gov. Shapiro signs Executive Order May 2026: data centers removed from the PA Permit Fast Track program; DEP to apply GRID standards in data center permit reviews
    “removing data center projects from the state's Permit Fast Track program and directing DEP to incorporate the state's Responsible Infrastructure Development, or GRID, requirements into its review”
  • Proposed statewide data center moratorium (Sen. Muth, three-year hyperscale moratorium) advances the opposition case in Harrisburg
    “State Sen. Katie Muth has introduced a three-year moratorium on hyperscale builds”
  • Permitting jurisdiction: Land use: Shippingport Borough Council (conditional use under the PA Municipalities Planning Code) - no state preemption of local zoning. State layer: PA DEP permits; Executive Order May 2026 (Aug
    “removing data center projects from the state's Permit Fast Track program and directing DEP to incorporate the state's Responsible Infrastructure Development, or GRID, requirements into its review”
  • Rezoning date: March 31, 2026
    “Shippingport Borough approved Aligned's conditional-use application on March 31, 2026, subject to conditions incorporated in the borough's written decision”
  • conditional use (land use approval): approved with conditions (borough written decision)
    “Shippingport Borough approved Aligned's conditional-use application on March 31, 2026, subject to conditions incorporated in the borough's written decision”
  • Shippingport Borough Council: Hearing/meeting adopting the written decision on Aligned's conditional-use application
    “Shippingport Borough approved Aligned's conditional-use application on March 31, 2026, subject to conditions incorporated in the borough's written decision”
  • Shippingport Borough council hears and approves Aligned's conditional use; written decision follows Mar 31, 2026
    “The council of the Borough of Shippingport held a public hearing last week to discuss conditional use requests from Aligned. The council approved the use permit.”
  • Shippingport Borough Council: Public hearing on Aligned conditional use requests for the Project Phoenix campus (council documents used the Project Phoenix name)
    “The council of the Borough of Shippingport held a public hearing last week to discuss conditional use requests from Aligned. Council documents suggest the proposed campus is known as Project Phoenix. The council approved the use permit.”
  • Counter-legislation: SB 991 would eliminate most state permits and public review before construction of AI data centers and related power plants (referred to Senate Environmental Resources and Energy Committee)
    “PA Senate Republicans Introduce Bill To Eliminate Need For Any State Permits, Any Public Review Of Permits Before Construction Of A.I. Data Centers, Related Power Plants”
Site and other (23)
  • NFG Shippingport Lateral construction commences (7.5-mile lateral to the site)
    “The project obtained FERC authorization on November 7, 2025 and construction commenced in March 2026”
  • Aliases: PIT-01 (first facility designation used by Aligned)
    “PIT-01 Data Center - 100 Church Lane, Shippingport, PA 15001”
  • Address: 100 Church Lane, Shippingport, PA 15001 (PIT-01)
    “PIT-01 Data Center - 100 Church Lane, Shippingport, PA 15001”
  • Acres: 850+ acres
    “850+ Acres”
  • Water use stated: Zero water for operational cooling; water only for initial system fill and minimal maintenance
    “This design requires water only for the initial system fill and subsequent minimal maintenance”
  • Construction stage: clearing / earthwork - groundbreaking held Sep 10, 2026; blasting program at Gate 17 ran Sep 28-Oct 16, 2026; no vertical construction evidenced as of Oct 2026
    “we are adjusting our site operations and rescheduling the start of our blasting activities to Monday, September 28”
  • Blasting/earthwork program under way at Gate 17 with rolling roadblocks on Shippingport Road (Sep 28-Oct 16, 2026 look-ahead)
    “we are adjusting our site operations and rescheduling the start of our blasting activities to Monday, September 28”
  • Name: Aligned Project Phoenix (Shippingport)
    “announced the groundbreaking of Project Phoenix, a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • Code names: Project Phoenix
    “announced the groundbreaking of Project Phoenix, a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • Developer: Aligned Data Centers
    “Aligned Data Centers (Aligned or the Company), a leading developer and operator of ultra-efficient data centers”
  • Operator: Aligned Data Centers (owner-operator model)
    “we operate these facilities and stay in the communities we build”
  • Buildings: 3 buildings
    “Spanning three facilities, the development will meet robust regional demand for digital infrastructure”
  • Groundbreaking date: Sept. 10, 2026
    “today announced the groundbreaking of Project Phoenix, a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • Workforce estimate: 3000 construction jobs
    “Project Phoenix will support an estimated 3,000 construction jobs and create an estimated 640 full-time careers for ongoing campus operations”
  • Workforce estimate: 640 full-time jobs
    “Project Phoenix will support an estimated 3,000 construction jobs and create an estimated 640 full-time careers for ongoing campus operations”
  • Groundbreaking held for Project Phoenix (2 GW, three facilities)
    “today announced the groundbreaking of Project Phoenix, a new 2 GW data center campus located in Shippingport, Pennsylvania”
  • Acres: 660 acres
    “owner and developer of the 660-acre Shippingport Industrial Park in Pennsylvania”
  • Announced: July 15, 2025
    “FGC has secured a partner to build a collocated data center facility to support America's demand for AI infrastructure”
  • Original target date: not stated
    “Nor has it publicly disclosed the campus's ultimate IT load or a detailed phase-by-phase construction schedule”
  • Current target date: not stated
    “Nor has it publicly disclosed the campus's ultimate IT load or a detailed phase-by-phase construction schedule”
  • Development stage: Groundbreaking held Sept. 10, 2026; three-building campus under construction
    “a groundbreaking was held Sept. 10 for a new data center complex in Beaver County”
  • Beaver County Times reports the groundbreaking was held despite concerns expressed by some area residents
    “Despite concerns expressed by some area residents, a groundbreaking was held Sept. 10 for a new data center complex in Beaver County”
  • Conditions of approval: Conditional use approved subject to conditions in the borough's written decision (Mar 31, 2026) - condition text not retrieved. A construction noise-limit exceedance permission was still outstandi
    “Shippingport Borough approved Aligned's conditional-use application on March 31, 2026, subject to conditions incorporated in the borough's written decision”

Imagery and records: Satellite imagery: Maxar via Esri World Imagery Wayback; Sentinel-2 (ESA Copernicus). County deeds: ATTOM.
