Data center profile · Homer City, Indiana County, Pa.

Homer City Energy Campus

A retired Pennsylvania coal plant being rebuilt as a 4.7 GW gas plant (4,678 MW in its air permit) to power AI data centers

Power plant under construction. Foundation work was reported in 2026 and the first heat-recovery boiler parts arrived in Sept. 2026 (press); the newest sharp satellite image, Nov. 2025, predates both. The data-center half is still a plan: Amazon has filed one with the county but signed nothing.
The old coal plant's power block mid-demolition, Satellite image, Nov. 4, 2025
4,678 MW
gas generation in the state air permit's project description
7 GE Vernova + up to 10 Mitsubishi turbines; under appeal
665 MMcf/d
gas the plant would burn, supplied by EQT
EQT figure, July 2025; supply deal still in principle
36
data-center buildings in Amazon's plan
in county review; no lease signed
$10B+
initial investment in power and site
company figure, Apr. 2025; power and site only
OperatorHomer City Redevelopment (backed by Knighthead Capital); Kiewit builds
CustomerNone signed; Amazon has filed a 36-building plan (prospective)
Planned IT capacity3.6 GW at full build-out (our estimate from the company's 4.5 GW campus power figure)
First building in serviceOur estimate: 2027 (range 2027 to 2028).
Next deadlineEnd of 2026: current creek discharge permit expires; state decision on the cooling-water amendment expected before then
The site

A coal plant coming down, with nothing new built yet

The former Homer City coal plant on Nov. 4, 2025, the latest sharp satellite picture of the site. The cooling towers are gone, the power block is being taken apart, and the switchyard at the top still stands. The gas plant and data centers planned here had not broken ground; foundation work reported in 2026 is not visible yet. The white patch at right is cloud.

Satellite overview123
Satellite image, Nov. 4, 2025. Pins placed from site coordinates.
  1. 1Gas plant site
    the old coal plant's power block, where the new gas turbines are permitted
  2. 2Planned data-center campus
    the plateau south of the power block, where the cooling towers stood
  3. 3345/230 kV switchyard
    north of the power block, kept from the coal plant
From orbit

The coal plant is coming down; the gas plant has not started

On April 5, 2021 the coal plant was still running, one cooling tower steaming. By Nov. 4, 2025 the towers had been imploded and crews were stripping the boiler house to its steel frame. The state approved the gas plant two weeks after this picture, and nothing for it is built yet. Drag to compare.

after
before
◀ Satellite image, April 5, 2021Satellite image, Nov. 4, 2025 ▶
From orbit

Parking and staging where the data centers will go, but no buildings

In April 2021 this plateau held the cooling towers, a work yard and a large low building south of the road. By Nov. 4, 2025 the towers were rubble rings, the building had been cleared for a gravel pad lined with excavators and loaders, and the parking rows were full. No data-center building has started. Drag to compare.

after
before
◀ Satellite image, April 5, 2021Satellite image, Nov. 4, 2025 ▶
From orbit

The switchyard survives the demolition

The 345/230 kV switchyard that sent the coal plant's power to the grid is unchanged between April 2021 and Nov. 4, 2025, while the coal pile and buildings beside it were cleared away. It is being kept for the redevelopment. Drag to compare.

after
before
◀ Satellite image, April 5, 2021Satellite image, Nov. 4, 2025 ▶
Quarter by quarter

A coal plant torn down to a graded platform

Demolition began when the cooling towers were imploded on March 22, 2025, four days after the March 18 frame. By Oct. 1, 2026 the old plant is gone and the site is a graded platform with the switchyard still in service; the new gas plant and data-center buildings are not yet visible in these frames.

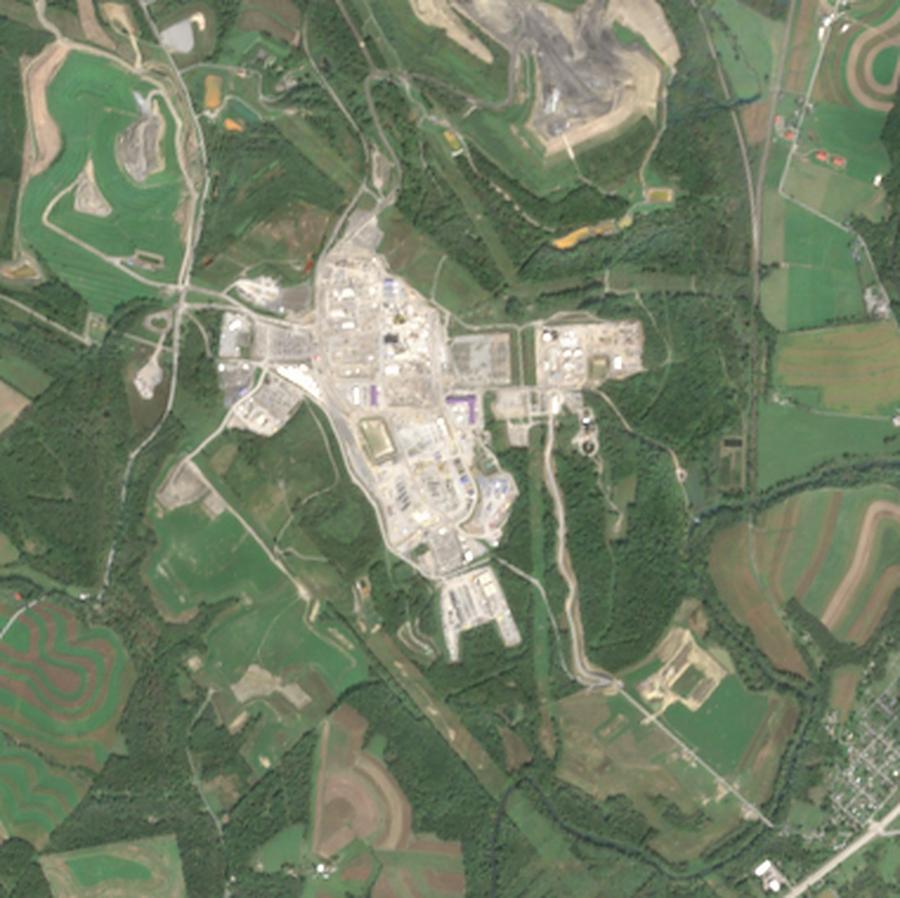

Satellite view of the campus, Oct. 1, 2026

Sentinel-2 satellite, 10 m resolution (coarser than the photos above).
Construction from orbit

What radar sees on the ground

From orbit, radar already sees large structures on the site in early 2023. The optical (Sentinel-2) series for this campus is not in yet, so there is no roof or clearing reading. The site reuses an old industrial or power-plant property, so radar cannot tell new building from the old structures here.

Construction from orbit: very bright radar echoes, as a share of the site
0204060%2023Jul2024Jul2025Jul2026Jul▲ Permits▲ Site work▲ VerticalRadar: bright echoes
0204060%2023202420252026▲ Permits▲ Site work▲ VerticalRadar: bright echoes
Radar: 2-month running median. Contains modified Copernicus Sentinel data 2023–2026.

How this works: Sentinel-1 radar sees through cloud every 6–12 days. Over the campus outline (about 80 acres) we count the share of very bright radar echoes: walls and steel bounce the signal straight back, so that share rises as buildings go up. Wet ground can lift it for a few weeks, so we read the trend, not single readings. Black ticks mark our stage dates. Data: Copernicus Sentinel-1 and Sentinel-2, via the Copernicus Data Space Ecosystem.

Power

Power and the grid

None energized or contracted yet · 4,678 MW permitted

On-site gas plantPermitted, under construction
4,678 MW
7 GE 7HA.02 combined-cycle units + up to 10 Mitsubishi FT8 peakers (air permit basis) State agency · Nov. 2025
Permitted
Other sources, size not disclosed
Backup generators (emergency use, not a power supply)

Stated capacity over time

April 2, 2025
4.5 GW
"up to 4.5 GW" from seven GE Vernova turbines (company)
July 15, 2025
4.4 GW
plant size in the EQT gas announcement (company)
Nov. 18, 2025
4,678 MW
dispatchable power in the state air permit (permit)
Oct. 6, 2026
>1 GW
surplus to go to the grid; Amazon campus takes the rest (press)

Getting on the grid

Who supplies what, what it costs, and what is still not public.

  1. April 2, 2025
    Old lines to two grids
    The coal station still has transmission ties to PJM and New York's grid. Company · April 2025
  2. April 3, 2025
    Reusing the coal plant's hookup
    Site ties into FirstEnergy's Penelec system in PJM; no new grid queue request found. News report · Oct. 2026
  3. As of July 2025
    No utility supplier
    The campus plans to run on its own plant; no retail power contract on record. Company · July 2025
  4. Oct. 6, 2026
    Over 1 GW to be exported
    Amazon's plan: most output feeds the campus, more than 1 GW goes back to the grid. News report · Oct. 2026
  5. Oct. 9, 2026
    FERC rejects PJM's large-load plan
    On-site plants like this one stay under state rules. News report · Oct. 2026
  6. Oct. 13, 2026
    Request to move the coal plant's grid rights (reported)
    Homer City Generation has asked PJM to transfer over 1,800 MW of capacity interconnection rights from the retired coal plant; reporting questions whether it asked too late, more than two years after the 2023 shutdown. It is a transfer of existing rights, not a new queue request for the gas plant (press). News report · Oct. 2026
  7. Not set
    Grid export deal: not disclosed
    No export MW, contract or in-service date is public.

Grid upgrades

No grid upgrade for this campus's load is on record. Related grid records in the area:

On-site generation on file

Backup generators (emergency use, not a power supply)

What is next door

campus0.15 km · 345 kV lines on the station site0.47 km · 500 kV line (Conemaugh to Keystone)0.54 km · Homer City substation (345/230 kV)6.98 km · Texas Eastern gas pipelinecampus1234
  1. 10.15 km · 345 kV lines on the station site
  2. 20.47 km · 500 kV line (Conemaugh to Keystone)
  3. 30.54 km · Homer City substation (345/230 kV)
  4. 46.98 km · Texas Eastern gas pipeline

A 230 kV line segment is 0.26 km away. Distances from mapped lines and plants. OpenStreetMap · Oct. 2026

Is it running?

Evidence from space

NO2 over the site, net of the rural background, was about the same in July–September 2026 (5 µmol/m²) as a year earlier (5), and the rural background fell 28% (27 to 19). The satellite sees no new combustion large enough to stand out here. On record here: On-site gas plant, 4,678 MW, permitted; EQT gas supply, proposed. No rise fits a plant that is not running yet, or runs little; it does not prove either. This campus has no plant running yet; it is here as a check that the method does not invent rises.

See all campuses checked →

NO2 over the campus and over open country (µmol/m²)
0255075100Jan 2025AprJulOctJan 2026AprJulOctOver the campusOpen country
0255075100Jan 2025JulJan 2026JulOver the campusOpen country
Lines: 7-day (daily) / 3-week (weekly) averages; gaps from cloud filled by straight-line interpolation; dots are raw readings. Shaded: July–September 2025 and 2026, averaging 5 and 5 µmol/m² above open country (1.0×).

What else could explain it

How this works: the Sentinel-5P satellite measures NO2 in the air over every point on Earth once a day, around 1:30 p.m. local time, in pixels about 5.5 by 3.5 km. NO2 comes from burning fuel (turbines, engines, traffic, power plants), so a rise over a site that open country does not share points to new combustion there. It shows combustion activity, not megawatts. The site box is about 15 km across; the background box is open country about 55 km away. We use only high-quality readings and drop days or weeks when cloud hides more than half of either box. Data: Copernicus Sentinel-5P (ESA), processed with the Copernicus Data Space Ecosystem Sentinel Hub statistics service.

Permits

Permits checklist

1 contested · 4 pending · 3 granted

Risks

What could slow it down

Also on record
Lawsuits

2 cases on record

Money

Money on record

$10B+
initial investment, power and site
company, April 2025; data centers would add billions more Company · April 2025
$5M
state grant for the gas pipeline hookup
$20B
Amazon Pennsylvania pledge
covers several campuses; not a Homer City commitment News report · June 2025

Not on record: project financing: not closed, Knighthead leads, talks with banks and private credit News report · Nov. 2025; signed lease or power deal with a tenant: Amazon is "in discussions" only News report · Oct. 2026; local tax breaks Amazon says it will seek: it says it will pay for its own electrical gear News report · Sept. 2026

Timeline

What happened, and what is due

SitePaper trailConstructionPowerPermitsMoneyLegalUpcoming
  1. Jan. 26, 2024
    Paper trail Homer City Redevelopment LLC registers in Pennsylvania State agency · Oct. 2026
  2. April 2, 2025
    Site Plan unveiled: 3,200-acre gas-powered campus, Kiewit to build Company · April 2025
  3. April 4, 2025
    Permits Air permit application filed with the state State agency · April 2025
  4. June 26, 2025
    Legal Demolition contractor sues the developer; drops the case July 1, 2025 Court filing · June 2025
  5. July 15, 2025
    Power EQT named exclusive gas supplier (agreement in principle) Company · July 2025
  6. July 15, 2025
    Power GE Vernova turbine reservation becomes a firm order for seven 7HA.02s Company · July 2025
  7. Sept. 2025
    Permits Hearing on the draft air permit; 571 comments, strongly opposed Dataset · Sept. 2025
  8. Nov. 18, 2025
    Permits Air permit issued for the 4,678 MW plant State agency · Nov. 2025
  9. Dec. 10, 2025
    Paper trail EQT Homer City Opco LLC registers in Pennsylvania State agency · Oct. 2026
  10. Dec. 18, 2025
    Legal Environmental groups and youth plaintiffs appeal the air permit News report · Dec. 2025
  11. March 23, 2026
    Legal Board refuses to merge the two appeals Court filing · March 2026
  12. May 11, 2026
    Construction Power plant's switchgear hall is the first building to rise; ~3M cubic yards moved, ~1,300 workers; no data-center building yet Company · May 2026
  13. June 27, 2026
    Permits Draft permit to send cooling water into Blacklick Creek News report · June 2026
  14. Sept. 9, 2026
    Permits County tables Amazon's 36-building plan after a packed meeting News report · Sept. 2026
  15. Sept. 16, 2026
    Construction First of 15 heat-recovery boilers arrive by heavy haul News report · Sept. 2026
  16. Oct. 14, 2026
    Permits Creek hearing: every speaker opposed; county accepts Amazon plan for review News report · Oct. 2026
  17. Dec. 2026
    Construction Amazon's first construction phase set to begin News report · Oct. 2026
  18. End of 2026
    Permits Deadline: current creek discharge permit expires News report · June 2026
  19. 2027
    Power Target: first power during 2027 (company, per press) News report · Sept. 2026
  20. Jan. 2027
    Permits Deadline: county planning commission must approve or reject Amazon's plan News report · Oct. 2026
  21. May 31, 2027
    Permits Deadline: air permit expires State agency · Nov. 2025
  22. July 2028
    Power Earliest planned operation for the first gas units in the plant's federal (EIA) filing State agency · Oct. 2026
Construction activity

Building activity by quarter

Since Feb. 2022: 1 FAA filing (Oct. 2025): a 400 ft crane; 78 satellite captures.

FAA filings
Satellite
’22
’23
’24
’25
’26
Dot size: records in the quarter, largest = 6. Two-digit years mark each first quarter.
The buildings

Specs

3,200 acres
campus as announced
1,100 acres
area of Amazon's data-center plan
8.1M sq ft
36 two-story, 70 ft buildings of 225,000 sq ft
4 phases
Amazon build: start Dec. 2026, finish June 2036
7 towers
wet cooling, 8 cells each, for the gas plant
6.84 MGD
max hot-water discharge to Blacklick Creek (draft)
12 diesels
emergency generators, 27 MW in all
15 boilers
heat-recovery units arriving by heavy haul
1,800+
construction workers on site, Sept. 2026
Who is involved

Owners, partners and builders

Owners and sponsors
  • Homer City Redevelopment LLC: developer and site owner
  • Knighthead Capital Management: majority equity owner; leads financing
  • Homer City Generation LP: holds the air permit; will own and run the plant
Decision-makers
  • Corey Hessen: governor and officer, Homer City Redevelopment LLC
  • Mark Wroten, Joel Heiser, Richard Tame: officers, Homer City Redevelopment LLC
Gas and power
  • EQT: exclusive gas supplier (agreement in principle)
  • EQT Homer City Opco LLC: EQT's project company; governors include Jeremy Knop
  • GE Vernova: seven 7HA.02 turbines
  • Mitsubishi Power Aero: FT8 peaking turbines
  • FirstEnergy (Penelec): grid hookup in PJM
  • Cummins: emergency generators
Builders
  • Kiewit Power Constructors: builds the plant and campus
  • EvapTech: cooling towers
  • Frontier Industrial: demolition contractor
Prospective customer
  • Amazon Web Services (Amazon Data Services Inc.): filed the 36-building plan; nothing signed
Regulators and opponents
  • Pennsylvania DEP: air, water and wetland permits
  • Indiana County Planning Commission: land plan
  • Clean Air Council, PennFuture, Sierra Club, McIntosh youth plaintiffs: appellants
  • Concerned Residents of Western PA: local group
Still unknown

Open questions

Where this comes from

417 records from 49 documents

Drawn from news reports, state agency records, company statements, public and commercial datasets, court filings, securities filings and satellite captures, each kept with its date and source. The bar shows documents by type.

News report 16State agency 11Company 7Dataset 7Court filing 7SEC filing 2Satellite 1
Evidence

Every quote behind this page

Grade key: A = the primary record itself (permit, filing, exhibit) · B = a dated official statement · C = news reporting. Map distances are our own measurements on OpenStreetMap and carry no grade. Allegations in lawsuits are marked as such in the quotes.

Power (69)
  • On-site generation: 4,396 MW
    “CT1-CT7 7 gens x 360.0 MW and CA1-CA7 7 gens x 268.0 MW, Natural Gas Fired Combined Cycle, all status P; nameplate sum 4,396.0 MW”
  • EIA status: P (planned, approvals not initiated)
    “All 14 planned generators (CT1-CT7, CA1-CA7) carry status (P) Planned for installation, but regulatory approvals not initiated”
  • EIA planned operation: July 2028
    “Earliest planned operation in plant 3122 is 2028-07 (CT5, CT6, CA5, CA6); remaining blocks filed for 2028-11, 2029-03, 2029-07 and 2029-11”
  • On-site power technology: Natural Gas Fired Combined Cycle (CT/CA)
    “Technology Natural Gas Fired Combined Cycle: CT1-CT7 at 360.0 MW (CT) and CA1-CA7 at 268.0 MW (CA)”
  • EIA planned operation schedule: Plant 3122 planned-operation tranches (EIA-860M Aug 2026): 2 combined-cycle blocks Jul 2028, 2 blocks Nov 2028, 1 block each Mar 2029, Jul 2029 and Nov 2029; each block is one 360 MW CT ge
    “Plant 3122, Homer City Generating Station: generators CT1-CT7 at 360 MW and CA1-CA7 at 268 MW, status (P)”
  • Aliases: Homer City Generating Station (legacy coal plant); Homer City Generation Project (permittee project name)
    “construction and initial operation of the Homer City Generation Project, a natural gas-fired electric generation station located in Center Township, Indiana County”
  • Facility address: 1750 Power Plant Rd, Homer City, PA 15748 (Center Township, Indiana County)
    “The project is located at the site of the former Homer City Generating Station, a retired coal-fired power plant, at 1750 Power Road, Homer City, PA 15748”
  • DEP primary facility ID: PF 883429 (new gas station); legacy coal station PF 262713
    “Plan Approval No. 32-00457A Homer City Generation LP APS# 1136415, AUTH# 1525661 PF# 883429”
  • On-site generation: 4678
    “providing 4,678 MWe of dispatchable (on-demand) power to maintain grid stability”
  • Emergency generator fleet: 12 diesel emergency generator engines (10 @ 2.5 MW, 2 @ 1.0 MW) plus 1 fire water pump engine (399 bhp)
    “The facility will include twelve emergency generator engines (ten rated at 2.5 MW and two at 1.0 MW) and one fire water pump engine (~400 bhp)”
  • On-site generation: 27
    “Ten (10) 2.5 MW Emergency Generator Engines (Source IDs 118-127). Two (2) 1.0 MW Emergency Generator Engines (Source IDs 128-129). 10 x 2.5 + 2 x 1.0 = 27.0 MW”
  • Generating units on the permit: 7 GE Vernova 7HA.02 combined-cycle combustion turbines (1x1 power blocks: CT + steam turbine + HRSG + natural gas duct burner), 3,515 MMBtu/hr per CT and 1,034.4 MMBtu/hr per duct burner
    “the installation of seven (7) GE Vernova (GE) 7HA.02 combined-cycle combustion turbines and ten (10) Mitsubishi Power FT8 Gas Turbine MOBILEPAC simple-cycle aeroderivative gas turbines”
  • Generating units on the permit: 10 Mitsubishi Power FT8 MOBILEPAC simple-cycle aeroderivative gas turbines, 301 MMBtu/hr each, water injection, SCR and oxidation catalyst
    “The project will also include ten (10) Mitsubishi FT8 Mobilepac Simple-Cycle Aeroderivative Gas Turbines, each with a rated heat input of 301 MMBtu/hr.”
  • Backup generators: 12 units
    “ten (10) 3,633 brake horsepower (bhp) ultralow sulfur dieselfired emergency generator engines, guaranteed to meet Tier 4 emission standards; two (2) 1,483 bhp ultralow sulfur dieselfired emergency generator engines”
  • Owner companies: Homer City Generation LP (plant permittee/owner); Homer City Redevelopment LLC (site owner)
    “Name: HOMER CITY GENERATION LP; Mailing Address: 1750 POWER PLANT RD, HOMER CITY, PA 15748-8009”
  • Operator: Homer City Generation LP
    “the Owner, [and Operator if noted] identified below is authorized by the Department of Environmental Protection to construct, install, modify or reactivate the air emission source(s)”
  • Address: 1750 Power Plant Road, Homer City, PA 15748 (Center Township, Indiana County)
    “Plant: HOMER CITY GENERATION LP; Location: 32 Indiana County 32912 Center Township”
  • On-site power technology: Natural gas combined cycle (7 blocks) + simple-cycle aeroderivative peakers (up to 10)
    “authorizes the construction and initial operation of seven (7) combined-cycle combustion turbines (CCs) and up to ten (10) simple cycle aeroderivative gas turbines (ADGTs)”
  • Generator maker and model: GE Vernova 7HA.02 (combined cycle); Mitsubishi Power FT8 MOBILEPAC (simple cycle)
    “GE 7HA.02 COMBINED CYCLE COMBUSTION TURBINE, 3,515.000 MMBTU/HR; MITSUBISHI FT8 SIMPLE CYCLE COMBUSTION TURBINE, 301.000 MMBTU/HR”
  • Generating units on the permit: 7 combined-cycle + up to 10 simple-cycle units
    “seven (7) combined-cycle combustion turbines (CCs) and up to ten (10) simple cycle aeroderivative gas turbines (ADGTs)”
  • Backup generators: 12 engines
    “3,633 BHP 2.5 MW EMERGENCY GENERATOR ENGINE (Source IDs 118-127, ten units); 1,483 BHP 1.0 MW EMERGENCY GENERATOR ENGINE (Source IDs 128-129, two units)”
  • Backup generator size (kW each): 2500 (x10); 1000 (x2) kW
    “Ten (10) 2.5 MW Emergency Generator Engines; Two (2) 1.0 MW Emergency Generator Engines”
  • Gas supply counterparty: EQT Corporation (agreement still being finalized at July 22, 2025; no definitive agreement disclosed in any later EQT filing found)
    “working to finalize agreement to supply natural gas and provide midstream infrastructure for the 665 MMcf/d Homer City Redevelopment project”
  • Gas supply volume: 665
    “working to finalize agreement to supply natural gas and provide midstream infrastructure for the 665 MMcf/d Homer City Redevelopment project”
  • EQT's Q2 2025 earnings 8-K is the only counterparty SEC filing that names the project, and it frames Homer City purely as a 665 MMcf/d gas-supply/midstream opportunity; no EQT, GE Vernova or sponsor filing states any IT-
    “working to finalize agreement to supply natural gas and provide midstream infrastructure for the 665 MMcf/d Homer City Redevelopment project”
  • Net generation reported to EIA: -379 MWh
    “Plant Id 3122; Netgen May 2024: BIT -376.357 + DFO -2.643 (Megawatthours)”
  • Net generation reported to EIA: -23041.998 MWh
    “Plant Id 3122; sum of monthly Netgen, June 2023 through May 2024: -23041.998 Megawatthours”
  • Fuel burned, reported to EIA: 0 short tons
    “Plant Id 3122; Reported Fuel Type Code BIT; Physical Unit Label short tons; Quantity summed June 2023 to May 2024: 0”
  • Fuel burned, reported to EIA: 0 short tons
    “Plant Id 3122; Reported Fuel Type Code BIT; Physical Unit Label short tons; Quantity May 2024: 0”
  • Fuel burned, reported to EIA: 0 barrels
    “Plant Id 3122; Reported Fuel Type Code DFO; Physical Unit Label barrels; Quantity summed June 2023 to May 2024: 0”
  • Fuel burned, reported to EIA: 0 barrels
    “Plant Id 3122; Reported Fuel Type Code DFO; Physical Unit Label barrels; Quantity May 2024: 0”
  • First month reported to EIA: Jan. 2022
    “Plant Id 3122; Plant Name Homer City Generating Station; Netgen January 2022 reported across Page 1 rows: BIT 214977.76 + DFO 2951.242”
  • Construction status: Under construction but no unit installed or operating: vertical construction began April 2026; demolition and excavation completed June 2026; first two HRSGs installed and first gas turbine set on it
    “Kiewit began vertical construction on the site in April 2026 with the first structure to rise on the campus”
  • Nearest substation: 0.54 km
    Measured on OpenStreetMap map data.
  • Nearest transmission line: 0.15 km
    Measured on OpenStreetMap map data.
  • Transmission line 500 kV distance: 0.47 km
    Measured on OpenStreetMap map data.
  • Nearest gas pipeline: 6.98 km
    Measured on OpenStreetMap map data.
  • Construction stage: vertical started (power plant): GIS building; approx. 3M cubic yards of earth moved; demolition completion anticipated Q2 2026
    “Vertical construction started with the Gas Insulated Switchgear (GIS) building; Approximately 3 million cubic yards of earth moved as part of site readiness”
  • U.S. Senator Dave McCormick met Homer City Generation leadership (Pittsburgh, May 7, 2026); company used the briefing to press federal permitting reform
    “leadership team met with U.S. Senator Dave McCormick in Pittsburgh on May 7, 2026, to provide an update on the current site redevelopment progress”
  • The only project in PJM's Dec. 31, 2025 RTEP lists naming this campus's station is Network project N9304.0 (Penelec): upgrade line relaying equipment at the Homer City terminal, $0.95M, required in-service 5/31/2027 (TEA
    “Upgrade line relaying equipment at Homer City terminal.”
  • On-site generation: 4,400 MW
    “the approved facility is expected to deliver up to 4.4 gigawatts of power that should serve multiple large data center customers”
  • Utility: None (self-supply from on-site plant; no retail electric service agreement)
    “to serve as HCR exclusive partner to source and supply the natural gas needed to power the 4.4 gigawatt natural gas facility”
  • Role of the on-site plant: prime (primary supply for campus; surplus exported to grid)
    “a fully integrated, on-site natural gas generating station”
  • Gas supplier: EQT Corporation (exclusive sourcing/supply partner, agreement in principle)
    “EQT Corporation (NYSE: EQT) to serve as HCR exclusive partner to source and supply the natural gas needed to power the 4.4 gigawatt natural gas facility”
  • General contractor: Kiewit Power Constructors Co. (EPC)
    “Kiewit Power Constructors Co. is leading construction (engineering, procurement and construction contractor)”
  • Site acres: 3200 acres
    “Homer City will be transformed into a more than 3,200-acre natural gas-powered data center campus”
  • On-site generation: 4,500 MW
    “Facility Will Generate Up to 4.5 GW of Energy Production Powered by Seven GE Vernova Turbines”
  • Name: Homer City Energy Campus
    “will be transformed into a more than 3,200-acre natural gas-powered data center campus”
  • Developer: Homer City Redevelopment (HCR)
    “Homer City Redevelopment (HCR) and Kiewit Power Constructors Co. announced the future of the former Homer City Generating Station”
  • Stated campus size: 4,500 MW
    “Facility Will Generate Up to 4.5 GW of Energy Production Powered by Seven GE Vernova Turbines”
  • Grid operator: PJM (legacy ties to NYISO retained from retired station)
    “transmission lines connected to the PJM and NYISO power grids, substations and water access”
  • Power plan: onsite (behind-the-meter gas plant) with grid export of surplus via legacy interconnection
    “Much of the critical infrastructure for the project is already in place from the legacy Homer City plant, including transmission lines connected to the PJM and NYISO power grids”
  • Original target date: 2027
    “Construction of the site is expected to commence this year and is expected to begin producing power by 2027”
  • PJM's Generator Deactivation list (TEAC, June 6, 2023) records Homer City Units 1, 2 and 3 (1,884 MW, Penelec zone) with a requested deactivation date of 7/1/2023; PJM's reliability analysis was completed with no impact
    “Homer City 1,2 and 3 1,884 Penelec 7/1/2023 Reliability analysis completed, no impact identified”
  • State vs local authority: Air and water permitting sit with PA DEP (state); land development approval sits with the Indiana County Planning Commission under the PA Municipalities Planning Code (Center/Black Lick Township
    “this is not a formal acceptance of the plan (county planning official, on the PLDP review)”
  • Stage: building - power plant under vertical construction on an issued air permit; data center campus still pre-approval (PLDP in county review)
    “The power plant is under active construction. The AWS data center campus is not yet fully approved”
  • Paper or real: Plant is real: issued permit, 14 of 18 material DEP permits, >1,800 workers, HRSGs arriving. Data-center half is paper: no tenant commitment, no approved land plan, no disclosed IT capacity
    “Homer City now has a publicly identified prospective hyperscale anchor with a campus proposal capable of absorbing enormous amounts of power”
  • NPDES amendment hearing: every speaker opposed; thermal discharge to Blacklick Creek (a trout-stocking fishery) is the live local fight, separate from the air permit appeal
    “All of about a dozen speakers at the hearing spoke out against the plans to permit the plant wastewater to be dumped into the stream”
  • Interconnection status: onsite applied / self-supply redevelopment - the new gas plant primarily serves the co-located campus behind the meter (sponsor testimony: ~75% behind the meter, remainder to the grid, exact split
    “Homer City Generation, L.P. requested that over 1.8 gigawatts of capacity interconnection rights be transferred to it from the Homer City coal-fired power plant, which closed in 2023.”
  • generator interconnection request: Capacity Interconnection Rights transfer requested - over 1,800 MW of CIRs from the retired Homer City coal plant to Homer City Generation, L.P.; timeliness questioned in reporting (req
    “Homer City Generation, L.P. requested that over 1.8 gigawatts of capacity interconnection rights be transferred to it from the Homer City coal-fired power plant, which closed in 2023.”
  • Buildings: 36 buildings
    “AWS plans to build 36 data centers on the site, as well as ancillary office and storage space, electrical substation infrastructure”
  • Power plan: onsite with >1 GW surplus injected to grid (AWS campus takes most output)
    “Most of the energy generated from the gas plant will be used to power the data center campus, but more than 1GW will be injected back into the grid”
  • On-site generation: 4,678 MW
    “DEP describes the overall project purpose as providing approximately 4,678 MWe of dispatchable generation”
  • Generator maker and model: GE Vernova 7HA.02; Mitsubishi Power FT8 MOBILEPAC
    “Homer City is permitted for seven GE Vernova 7HA.02 combined-cycle gas turbine trains, supplemented by ten Mitsubishi Power FT8 MOBILEPAC aeroderivative simple-cycle turbines.”
  • Construction stage: vertical (power plant): GIS building vertical, foundations underway, first HRSG components arrived from Sep 16, 2026; data center buildings not started
    “Heavy-haul transport of the first heat-recovery steam generator components began September 16, part of a program to move 15 HRSGs to Homer City”
  • Gas lateral: 5.8-mile, 30-inch natural gas pipeline from Texas Eastern Transmission system through Black Lick, Burrell and Center Townships
    “DEP Invites Comments On Permit For Homer City Generation 5.8 Mile, 30-Inch Natural Gas Pipeline To Serve Proposed Data Center 4.5 GW Power Plant”
  • Opposition: Concerned Residents of Western PA (CROW); Clean Air Council, PennFuture, Sierra Club, Earthjustice comment campaign (Sep 29, 2025); 571 public comments on the draft air permit; McIntosh youth appellants
    “As members of Concerned Residents of Western PA (CROW), an area group opposed to the planned power plant in Homer City, we fully support the legal appeal”
  • Homer City's grid share is real but unquantified in any filing: PA Senate hearing testimony (May 2025 reporting) put ~75% of output behind the meter for the data center with the remainder to the grid, the exact figure wi
    “We're still in confidential negotiations at this time, so I can't give you an exact answer, but I would say 75% is a fair number”
  • Interconnection status: Legacy station interconnection reused; no new PJM queue request identified; site interconnects with FirstEnergy Pennsylvania Electric Co. system in PJM
    “The site interconnects with FirstEnergy Pennsylvania Electric system in PJM”
Money and contracts (22)
  • Financing: Financing led by Knighthead Capital Management, LLC; no closed financing package disclosed as of Oct 2026
    “The project financing is led by Knighthead Capital Management, LLC. Knighthead has had significant equity positions in Homer City for nearly eight years”
  • gas supply agreement (in principle): scope exclusivity EQT is exclusive partner to source and supply all natural gas for the campus plant
    “an agreement in principle for EQT Corporation (NYSE: EQT) to serve as HCR exclusive partner to source and supply the natural gas needed to power the 4.4 gigawatt natural gas facility”
  • gas supply agreement (in principle): volume 665000 MMBtu/day (up to)
    “HCR and EQT will unlock natural gas supply of up to 665,000 MMBTUs per day”
  • gas supply agreement (in principle): supply redundancy Dual interconnects: Texas Eastern Transmission and Eastern Gas Transmission and Storage systems
    “an unparalleled level of gas supply redundancy for the site with the ability to source gas from both the Texas Eastern Transmission and Eastern Gas Transmission and Storage pipeline systems”
  • gas supply agreement (in principle): termination conditions not disclosed FINDING: no term, termination, cancellation or conditions-precedent clauses are disclosed in the public announcement; the arrangement is an agreem
    “today announced an agreement in principle (the Agreement) for EQT Corporation to serve as HCR exclusive partner”
  • turbine supply agreement: scope Seven 7HA.02 gas turbines plus combined-cycle equipment; announced as slot reservation agreements Apr 2, 2025; converted to a full/secured order in 3Q25
    “GE Vernova also announced that it has secured a full order to provide seven of its high efficiency 7HA.02 natural gas turbines to the Homer City Energy Campus”
  • turbine supply agreement: delivery First turbine deliveries expected to begin in 2026
    “with the first deliveries expected to begin in 2026”
  • turbine supply agreement: termination conditions not disclosed FINDING: no cancellation, termination or liquidated-damages clauses are disclosed in the public order announcements
    “These units have since moved to a secured order in 3Q25”
  • Stated capital cost: 10000000000 USD (exceeds)
    “An initial capital investment projected to exceed $10 billion for power infrastructure and site readiness, with data center development to inject billions more”
  • EPC contract: scope EPC for the gas plant and campus construction
    “The Homer City Energy Campus will be built by Kiewit Power Constructors Co., one of the leading engineering, procurement and construction (EPC) contractors in the country”
  • EPC contract: termination conditions not disclosed FINDING: EPC price, schedule guarantees, and termination clauses are not disclosed in any public source checked
    “Construction of the site is expected to commence this year”
  • tenant power/lease agreement: none found FINDING: no PPA, ESA, lease or load commitment with any tenant has been disclosed as of Oct 18, 2026; AWS is a plan applicant in discussions only
    “noting that it was in discussions with Homer City Redevelopment”
  • Tenant status: Plan filed, not committed: AWS in discussions with HCR since Aug 2026; PLDP tabled Sep 9, 2026, accepted for county review Oct 14, 2026; no lease/PPA/load contract disclosed
    “Starting today, the commission has 90 days to review the plan and to either approve it or reject it”
  • Tenants: Amazon Web Services / Amazon Data Services, Inc. (prospective; plan applicant only)
    “Amazon Web Services (AWS) has filed a Preliminary Land Development Plan (PLDP) for a 36-building data center campus in Homer City, Pennsylvania”
  • Square feet: 8100000 sq ft
    “Each data center building will have two stories, reaching heights of 70 feet, and 225,000 sq ft of floor space”
  • community benefits agreement (commitment only): status not executed AWS committed to establish a community benefits agreement to mitigate impacts; NO executed CBA found as of Oct 2026
    “AWS has also committed to establishing a community benefits agreement to mitigate community impacts and ensure the Project delivers tangible local benefits”
  • Incentives: AWS states it does not intend to request county or local tax incentives and will fund electrical infrastructure required for its project
    “AWS has said it does not intend to request county or local tax incentives and would cover costs associated with electrical infrastructure specifically required for its project”
  • Workforce estimate: 1800 workers
    “the active construction workforce had surpassed 1,800 direct-hire tradespeople and skilled contractors, with the total expected to approach 2,000 by year-end”
  • Sponsor reported in discussions with commercial banks and private credit firms; any project finance loan would be among the largest for a single US gas-fired asset; no closed package announced
    “The developers have spoken to a range of debt providers, according to sources, including commercial banks and private credit firms to finance the conversion”
  • Amazon approx. $20B Pennsylvania data center investment pledge covers MULTIPLE campuses statewide; it is not a Homer City commitment and must not be attributed to this campus
    “Amazon has pledged to invest some $20 billion in Pennsylvania across multiple campuses”
  • Incentives: 5000000 USD
    “HCR received a $5 million state grant to support construction of an interconnection between the generating station and the pipeline, which is about five miles away”
  • state grant: grant amount 5000000 USD
    “HCR received a $5 million state grant to support construction of an interconnection between the generating station and the pipeline”
Permits and government (26)
  • air quality plan approval appeal: motion to consolidate denied
    “By Bernard A. Labuskes, Jr., Board Member and Judge. The Board denies a permittee motion to consolidate two appeals of an air quality plan approval”
  • Permitted operating hours: 8760 hr/yr
    “Each of the GE 7HA.02 units are proposed to be operated up to 8,760 hr/yr with 8,760 hr/year to include duct burner firing.”
  • DEP issued final Plan Approval 32-00457A on Nov. 18, 2025 (technical review memo si: plan approval issued (final)
    “It is recommended that a plan approval be issued to Homer City Generation LP to authorize the construction and operation of the natural gas-fired electrical generating station in Center Township, Indiana County”
  • air quality plan approval: issued (final)
    “Issue Date: November 18, 2025; Expiration Date: May 31, 2027. This Plan Approval authorizes the construction and initial operation of seven (7) combined-cycle combustion turbines”
  • FAA OE/AAA: Determined - No Hazard
    “Need an FAA permit that encompasses the entire jobsite as there will be dozens of mobile cranes operating throughout the jobsite”
    FAA · Oct. 2025 · grade A
  • demolition air-quality review (dust mitigation plan): dust mitigation plan submitted by Frontier Industrial Corp. for implosion of coal silos
    “Page 1 is Frontier's June 12, 2025 letter from Nicholas Franjoine, Project Manager, to Scott Dyll, Pennsylvania DEP Air Quality District Supervisor”
  • demolition air-quality review (asbestos / dust plan): DEP request for roofing/asbestos information and a dust mitigation plan before implosion
    “DEP sought roofing/asbestos information and a dust plan; email says a structure must be asbestos-free for implosion (packet p. 9)”
  • Homer City Generation LP application (APS 1136415, Auth 1525661, PF 883429) to c: plan approval application received
    “On April 4, 2025, the Department of Environmental Protection (DEP) received a plan approval application from Homer City Generation LP (Homer City)”
  • air quality plan approval: application received
    “On April 4, 2025, the Department of Environmental Protection (DEP) received a plan approval application from Homer City Generation LP”
  • Title v operating permit number: 32-00055
    “This Title V Operating Permit authorizes the transfer and use of the following VOC ERCs”
  • NPDES wastewater: second draft issued; comment period reopened
    “in the June 27 2026 draft permit, the Department incorrectly used the default stream temperature values for Warm Water Fishes rather than the default values for Trout Stocking. This has been corrected in this second draft permit”
  • building permits: 6 of 8 issued (power plant)
    “6 of 8 building permits issued”
  • DEP permits (plant, aggregate): 14 of 18 material permits issued
    “14 of 18 material DEP permits issued”
  • air quality plan approval: draft published; public meeting and hearing
    “The DEP held a public meeting and hearing in September 2025 to discuss the draft Air Quality Plan Approval No. 32-00457A submitted by Homer City Generation LP”
  • NPDES wastewater: public hearing
    “Wednesday night, the Homer-Center Jr./Sr. High Auditorium hosted a public hearing from the Pennsylvania Department of Environmental Protection on the application for modifications to the power company discharge obligations into Blacklick Creek”
  • preliminary land development plan: accepted for review
    “At a meeting yesterday afternoon, the Indiana County planning commission accepted for review a proposed plan from Amazon for data centers at the Homer City Energy Campus”
  • Indiana County Planning Commission: Amazon data center plan at Homer City Energy Campus
    “the Indiana County planning commission accepted for review a proposed plan from Amazon for data centers at the Homer City Energy Campus”
  • PA DEP: Public hearing on NPDES PA0005037 amendment (Outfall 027 blowdown to Blacklick Creek)
    “The public highlighted several environmental-related issues with the potential discharge of water into outfall 27, which is located on Black Lick Creek”
  • FERC rejected the core of PJM proposed large-load framework (Docket ER26-3515-000: IRAS/BYONC rejected; large-load definition and registry accepted). Portfolio context only: co-located behind-the-meter models like Homer
    “FERC largely rejected PJM framework for bringing data centers and other large loads onto its system, including proposed interim service and bring your own new capacity rules”
  • preliminary land development plan: tabled
    “On September 9, 2026, the Indiana County Planning Commission voted to table AWS preliminary land-development application”
  • Indiana County Planning Commission: AWS preliminary land development plan (36 buildings, Center/Black Lick Townships)
    “On September 9, 2026, the Indiana County Planning Commission voted to table AWS preliminary land-development application. The action followed a heavily attended public meeting”
  • NPDES wastewater: major amendment - draft permit noticed for comment
    “DEP published notice in the June 27 PA Bulletin inviting comments on a major amendment to an existing Homer City Generation LP NPDES Wastewater Permit changing wastestreams going to discharge 027”
  • stormwater / Chapter 105 (gas pipeline): individual stormwater permit noticed for comment
    “published notice in the February 7 PA Bulletin inviting comments on an Individual Stormwater Permit for a 5.8 mile, 30-inch natural gas pipeline”
  • air quality plan approval appeal: appeal filed
    “Clean Air Council, PennFuture, and Sierra Club have filed a Notice of Appeal with the Pennsylvania Environmental Hearing Board challenging errors in the plan approval”
  • Chapter 105 water obstructions/encroachments: application noticed for comment
    “notice in the November 29 PA Bulletin inviting comments on a Chapter 105 permit for construction of the site for the Homer City A.I. Data Center campus 4.5 GW natural gas power plant”
  • PA DEP: Public meeting and hearing on draft Air Quality Plan Approval 32-00457A
    “The DEP held a public meeting and hearing in September 2025 to discuss the draft Air Quality Plan Approval No. 32-00457A”
Legal (4)
  • Lawsuits: PA Environmental Hearing Board Docket Nos. 2025-135-L (Clean Air Council et al.) and 2025-136-L (McIntosh et al.) - appeals of Plan Approval 32-00457A; consolidation denied Mar 23, 2026; both pending
    “The Board denies a permittee motion to consolidate two appeals of an air quality plan approval. The appeals are docketed at EHB Docket Nos. 2025-135-L and 2025-136-L”
  • Frontier Industrial Corp. sued campus developer Homer City Redevelopment LLC in W.D. Pa. (No. 2:25-cv-00891) in June 2025, during the plant demolition/construction period
    “FRONTIER INDUSTRIAL CORP. v. HOMER CITY REDEVELOPMENT LLC | District Court, W.D. Pennsylvania | 2:25-cv-00891”
  • Frontier Industrial v. Homer City Redevelopment (W.D. Pa. 2:25-cv-00891): complaint + TRO application June 26, 2025 (Docs. 1, 7); emergency hearing set June 27, 2025; plaintiff voluntarily dismissed and court dismissed WITHOUT
    “July 1, 2025: Joint report; plaintiff voluntarily dismisses; court dismisses without prejudice and closes case (Docs. 24-26)”
  • Two EHB appeals of the air permit filed (enviro groups; McIntosh youth appellants) - see conflicts/lawsuits fact rows
    “Clean Air Council, PennFuture, and Sierra Club appeal Homer City gas plant air quality plan approval no. 32-00457A”
Site and other (15)
  • Conditions of approval: Plan Approval 32-00457A: issued/effective Nov 18, 2025; expires May 31, 2027; commissioning period must complete within 180 days of first fire; 369.035 tons of VOC emission reduction credits requi
    “Issue Date: November 18, 2025; Effective Date: November 18, 2025; Expiration Date: May 31, 2027”
  • Cooling: Wet mechanical draft cooling towers (7 towers, 8 cells each) serving the combined-cycle plant
    “Seven (7) Cooling Towers (Source IDs 301-307), each with eight cells, to serve the combined-cycle units”
  • Equipment vendors: Cummins (emergency generator engines, Tier 4, MIRATECH aftertreatment); Clarke (fire water pump engine, Tier 3); EvapTech (cooling towers)
    “a letter from Cummins and their aftertreatment vendor, MIRATECH; a letter from Clarke certifies the engine meets Tier 3; a letter from EvapTech confirms the cooling towers drift eliminators”
  • Demolition scope: proposed implosion of 2 NIDS byproduct silos and 4 coal truck silos (Frontier letter to PA DEP, June 12, 2025)
    “Proposed implosion of 2 NIDS byproduct silos and 4 coal truck silos (Frontier letter of June 12, 2025 to PA DEP, p. 1)”
  • Demolition dust cannons: 2
    “Dust Boss DB 60 dust cannons, "2 Each Set"; stated water flow 26 gpm (Frontier letter to PA DEP, p. 1)”
  • Water use stated: Cooling tower blowdown discharge up to 6.84 MGD to Blacklick Creek via Outfall 027 (draft NPDES amendment)
    “The maximum blowdown rate to Outfall 027 is approximately 4,750 gallons per minute (gpm), equivalent to approximately 6.84 million gallons per day (MGD)”
  • Workforce estimate: 1300 workers
    “Nearly 1,300 skilled workers on site today, including electricians, carpenters and boilermakers”
  • County code: 42063
    “Location: 32 Indiana County 32912 Center Township”
  • Acres: 3200 acres
    “a 3,200 acre AI and high-performance computing (HPC) data center campus”
  • Announced: April 2, 2025
    “first announced on April 2, 2025 (evolution of the former Homer City Generating Station)”
  • Acres: 1100 acres
    “The campus will span 1,100 acres of land in Center and Blacklick Townships, Indiana County”
  • Phases: 4 phases (AWS campus): construction from Dec 2026, last phase starts Jan 2032, full completion Jun 2036
    “Construction will proceed over four phases, beginning in December 2026, with the last phase set to commence in January 2032”
  • Current target date: 2027
    “Homer City continues to target first electricity during 2027, with full commissioning and build-out extending beyond the first generating units”
  • Heavy-haul deliveries of HRSG components began Sep 16, 2026: 15 HRSGs, approx. 228,000-438,000 lbs each, moving to site through September-October 2026
    “part of a program to move 15 HRSGs weighing approximately 228,000 to 438,000 pounds apiece to Homer City during September and October”
  • Current target date: 2028 (units 2,3,5,6) / 2029 (units 1,4,7) per EIA-860M planned unit dates
    “units 2, 3, 5 and 6 will begin operating in 2028, and units, 1, 4 and 7 in 2029 (Preliminary Monthly Electric Generator Inventory, EIA)”

Imagery and records: Satellite imagery: Maxar via Esri World Imagery Wayback; Sentinel-2 (ESA Copernicus).
