Data center profile · Memphis, Tenn. and Southaven, Miss.

Colossus 2

xAI's gigawatt AI training campus straddling the Tennessee–Mississippi line

Operating and expanding. First cluster online from Oct. 2025 (xAI called it operational in Jan. 2026), running largely on temporary gas turbines while a permanent 1.2 GW plant waits on its appeal.
The Memphis hall, Satellite image, Dec. 29, 2025
210 MW
first compute cluster, per SpaceX's securities filing (May 2026)
about 110,000 GB200 chips; our live estimate today is about 946 MW (Epoch AI, June 2026)
28
temporary gas turbines visible on satellite
Nov. 28, 2025 capture
1.2 GW
permanent gas plant permitted
41 turbines, Mar. 2026, under appeal
69
temporary gas turbines at peak
xAI's count under the state agreed order, July 2026; all out by July 2027
OperatorxAI (SpaceX)
CustomerAnthropic (compute customer)
Planned IT capacity1.7 GW at full build-out (our estimate)
First building in serviceIn service since Oct. 2025 (about 946 MW of IT capacity live, estimated); xAI declared it operational in Jan. 2026
Next deadlineEnd of 2026: 26 of 69 temporary turbines must be gone
The site

Three xAI sites on both sides of the state line

A data hall in Memphis, a second hall across the line in Southaven, and a yard of trailer-mounted gas turbines a mile south. The power plant in the middle belongs to TVA, not xAI.

Satellite overview1234
Satellite image, Dec. 29, 2025. Pins placed from site coordinates.
  1. 1Macrohard data hall
    5420 Tulane Rd, Memphis, Tenn.
  2. 2Macrohardrr data hall
    2400 Stateline Rd W, Southaven, Miss.
  3. 3Temporary turbine yard
    2875 Stanton Rd S, Southaven (former Duke Energy site)
  4. 4TVA Southaven gas plant
    existing utility plant, not xAI's
Quarter by quarter

New halls and a turbine field in 18 months

The Memphis and Southaven halls were converted warehouses already standing in late 2024, and grading for the Tulane Rd expansion began by the Feb. 3, 2025 frame. By Aug. 2026 the expansion halls were complete and the Stanton Rd turbine field was at full extent; the Oct. 6, 2026 frame shows work continuing at all three sites.

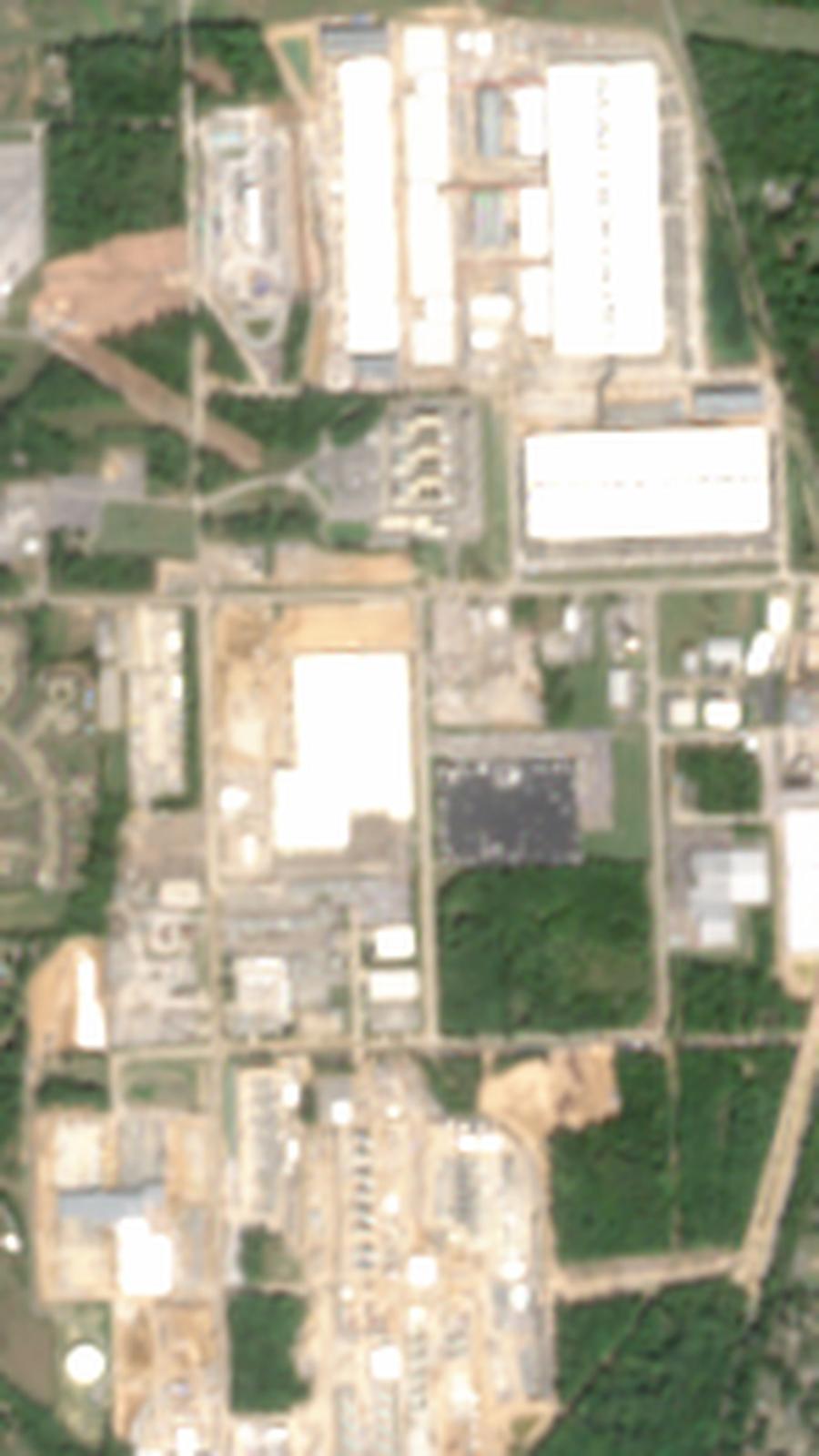

Satellite view of the campus, Oct. 6, 2026

Sentinel-2 satellite, 10 m resolution (coarser than the photos above).
Construction

From one empty hall to a campus in service in nine months

In March 2025 the Memphis hall stood alone on a graded lot. By late December the roof read MACROHARD, and the yard held roughly 374 containerized cooling units, a block of about 20 battery containers and a working crane. Drag to compare.

after
before
◀ Satellite image, March 10, 2025Satellite image, Dec. 29, 2025 ▶
Southaven hall
The Southaven hall (Macrohardrr), Satellite image, Dec. 29, 2025. No equipment yard yet; the rows along the dock are trailers.
Construction from orbit

What radar sees on the ground

From orbit, radar echoes from walls and steel start climbing in Oct. 2024. The optical (Sentinel-2) series for this campus is not in yet, so there is no roof or clearing reading. That fits our stage: partly in service.

Construction from orbit: very bright radar echoes, as a share of the site
010203040%2023Jul2024Jul2025Jul2026Jul▲ Permits▲ Site work▲ Vertical▲ Power onRadar: bright echoes
010203040%2023202420252026▲ Permits▲ Site work▲ Vertical▲ Power onRadar: bright echoes
Radar: 2-month running median. Contains modified Copernicus Sentinel data 2023–2026.

How this works: Sentinel-1 radar sees through cloud every 6–12 days. Over the campus outline (about 170 acres) we count the share of very bright radar echoes: walls and steel bounce the signal straight back, so that share rises as buildings go up. Wet ground can lift it for a few weeks, so we read the trend, not single readings. Black ticks mark our stage dates. Data: Copernicus Sentinel-1 and Sentinel-2, via the Copernicus Data Space Ecosystem.

Power

Running on temporary turbines while the permanent plant waits

The grid could not deliver a gigawatt in time, so xAI trucked in gas turbines. Satellite imagery shows the yard empty in March 2025 and holding 28 units by late November. Drag to compare.

after
before
◀ Satellite image, March 10, 2025Satellite image, Nov. 28, 2025 ▶

How big the temporary fleet got

0204060Jan 26July 26Jan 27July 27Oct. 31, 2025: 18 aerial thermal surveyNov. 28, 2025: 28 satellite countApril 14, 2026: 33 May 6, 2026: 46 disclosed to MDEQMay 15, 2026: 57 July 30, 2026: 69 peak, per agreed orderAug. 31, 2026: 58 11 removedDec. 31, 2026: 43 target: 26 removedJuly 31, 2027: 0 all temporary units outPeak: 69 units28 seen from orbit
Swipe the chart sideways to see all of it →
Court filingsSatelliteState regulatorRequired by agreed order

Every power source on record

495 MW energized plus sources of undisclosed size · 900 MW contracted · 1,200 MW permitted

Temporary gas turbinesRunning, being removed
495 MW
≥495 MW at 27 units; fleet later peaked at 69 Court filing · Feb. 2026
Stateline Power (Solaris–xAI JV)Contracted
900 MW
off-grid generation contract, upsized from 500 MW SEC filing · Sept. 2026
Permanent gas plant (41 turbines)Permitted, under appeal
1,200 MW
permitted; construction must start by Sept. 11, 2027 State agency · March 2026
Energized nowContractedPermitted
Other sources, size not disclosed

Capacity claims vs. power on record

Filings disclose clusters of 210–400 MW; the company says the cluster will reach nearly 2 GW once Southaven is complete. Only the temporary fleet is confirmed running.

0 MW500 MW1,000 MW1,500 MW2,000 MW210 MW: S-1 cluster210 · S-1 cluster400 MW: S-1 next phase400 · S-1 next phase946 MW: outside estimate946 · outside estimate1,000 MW: "gigawatt-scale" (S-1)1,000 · "gigawatt-scale" (S-1)Temporary gas turbines: 495 MWStateline Power (Solaris–xAI JV): 900 MWPermanent gas plant (41 turbines): 1,200 MW
Swipe the chart sideways to see all of it →
Securities filingOutside estimateCompany claimPower on record (▲)

Stated capacity over time

Jan. 8, 2026
~2 GW
"nearly 2 gigawatts" once the Southaven building is complete (company) State agency · Jan. 2026
May 20, 2026
210–400 MW
cluster sizes in SpaceX's S-1 (filing)

Contractor bonus: $9.5M in stock at each of 110,000, 220,000 and 330,000 GPUs commissioned at the Memphis hall. Court filing · April 2025

Getting on the grid

Who supplies what, what it costs, and what is still not public.

  1. July 22, 2025
    Memphis utility supplies only ~0.5 MW
    MLGW: its general service to the Memphis hall is about 0.5 MW and it is not powering the supercomputer. News report · Oct. 2026
  2. Feb. 13, 2026
    MLGW weighs up to 1.1 GW
    Grid options of up to 1.1 GW were discussed for the Memphis site, per a court exhibit. Court filing · Feb. 2026
  3. Aug. 20, 2026
    TVA approves direct service, over 100 MW
    MZX Tech becomes a direct TVA customer. xAI builds its own lines and transformers; MW and collateral not disclosed. see Permits
  4. Oct. 1, 2026
    New data-center rate takes effect
    TVA's Large Data Service rate: about 10% higher on average, plus a Capacity Commitment charge of roughly $1.5M per MW above the first 5 MW. News report · Oct. 2026
  5. Not set
    Grid in-service date: not disclosed
    No energization date or delivered MW has been made public. News report · Aug. 2026

What is next door

campus0.19 km · Texas Gas "Southaven Lateral" pipeline0.27 km · TVA Southaven gas plant0.44 km · 500 kV substation0.55 km · TVA 500 kV line (Freeport–Southaven)campus1234
  1. 10.19 km · Texas Gas "Southaven Lateral" pipeline
  2. 20.27 km · TVA Southaven gas plant
  3. 30.44 km · 500 kV substation
  4. 40.55 km · TVA 500 kV line (Freeport–Southaven)

15 high-voltage line segments (230 kV and up) run within 2 km. Distances from mapped lines and plants. OpenStreetMap · Oct. 2026

Is it running?

Evidence from space and the gas pipeline

NO2 over xAI's Southaven turbine yard, net of the rural background, rose about 4× from summer 2025 to summer 2026 (9 to 41 µmol/m², averages for July–September 2025 and 2026), while the rural background stayed flat (about 25 both summers). The monthly excess first cleared its early-2025 range in Jan. 2026 and peaked in Sept. 2026 at 60 µmol/m². That fits added combustion in the box, but the box overlaps the one drawn for xAI's Colossus 1 campus, so part of the rise can come from there; the satellite cannot split the two.

See all campuses checked →

NO2 over the campus and over open country (µmol/m²)
050100150Jan 2025AprJulOctJan 2026AprJulOctOver the campusOpen country
050100150Jan 2025JulJan 2026JulOver the campusOpen country
Lines: 7-day (daily) / 3-week (weekly) averages; gaps from cloud filled by straight-line interpolation; dots are raw readings. Shaded: July–September 2025 and 2026, averaging 9 and 41 µmol/m² above open country (4.4×).

Gas booked on the pipeline

Texas Gas Transmission's public postings show how much gas is booked each day for delivery to MZX Tech, the xAI company that runs the Southaven turbines. The record opens on July 23, 2026 at 180,000 dekatherms a day. Bookings averaged about 223,400 a day in September: enough gas for roughly 810–980 MW of turbine output, or about 600–820 MW of IT power draw once cooling and losses are taken out. Oct 1–13: xAI's operator booked zero gas on the pipeline for 13 straight days; that is in the pipeline's own daily postings, not missing data. Bookings restarted Oct 14 at a new meter. Satellite NO2 over the site did not drop in those days, so the turbines may have run on fuel from another source, or the NO2 came from other plants in the area (TVA's Southaven plant sits in the same box). The public records can't settle which. From Oct. 15 to Oct. 22 they averaged about 281,600 a day, or 760–1,030 MW of IT power draw, with a high of 307,709 on Oct. 22.

Firm contract, 193,200 Dth/dSep average = 600–820 MW ITOct 15–22 = 760–1,030 MW ITNo gas booked0100k200k300k400kDth/dJul 23: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 24: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 25: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 26: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 27: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 28: 180,000 Dth/d booked, about 480–660 MW of IT power drawJul 29: 190,000 Dth/d booked, about 510–690 MW of IT power drawJul 30: 190,000 Dth/d booked, about 510–690 MW of IT power drawJul 31: 190,000 Dth/d booked, about 510–690 MW of IT power drawAug 1: 190,000 Dth/d booked, about 510–690 MW of IT power drawAug 2: 190,000 Dth/d booked, about 510–690 MW of IT power drawAug 3: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 4: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 5: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 6: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 7: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 8: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 9: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 10: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 11: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 12: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 13: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 14: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 15: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 16: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 17: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 18: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 19: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 20: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 21: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 22: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 23: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 24: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 25: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 26: 195,000 Dth/d booked, about 520–710 MW of IT power drawAug 27: 207,000 Dth/d booked, about 560–760 MW of IT power drawAug 28: 207,000 Dth/d booked, about 560–760 MW of IT power drawAug 29: 207,000 Dth/d booked, about 560–760 MW of IT power drawAug 30: 207,000 Dth/d booked, about 560–760 MW of IT power drawAug 31: 215,000 Dth/d booked, about 580–790 MW of IT power drawSep 1: 215,000 Dth/d booked, about 580–790 MW of IT power drawSep 2: 215,000 Dth/d booked, about 580–790 MW of IT power drawSep 3: 215,000 Dth/d booked, about 580–790 MW of IT power drawSep 4: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 5: 219,998 Dth/d booked, about 590–800 MW of IT power drawSep 6: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 7: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 8: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 9: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 10: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 11: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 12: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 13: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 14: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 15: 216,939 Dth/d booked, about 580–790 MW of IT power drawSep 16: 224,737 Dth/d booked, about 600–820 MW of IT power drawSep 17: 220,000 Dth/d booked, about 590–800 MW of IT power drawSep 18: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 19: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 20: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 21: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 22: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 23: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 24: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 25: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 26: 225,000 Dth/d booked, about 600–820 MW of IT power drawSep 27: 223,893 Dth/d booked, about 600–820 MW of IT power drawSep 28: 239,035 Dth/d booked, about 640–870 MW of IT power drawSep 29: 240,000 Dth/d booked, about 640–880 MW of IT power drawSep 30: 247,830 Dth/d booked, about 670–910 MW of IT power drawOct 14: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 15: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 16: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 17: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 18: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 19: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 20: 278,000 Dth/d booked, about 750–1,020 MW of IT power drawOct 21: 277,303 Dth/d booked, about 740–1,010 MW of IT power drawOct 22: 307,709 Dth/d booked, about 830–1,120 MW of IT power draw≈ 270–370 MW IT≈ 540–730 MW IT≈ 810–1,100 MW IT≈ 1,070–1,460 MW ITNO₂ over the site minus background, µmol/m² (dots: days; line: 7-day average)0100200Jul 26: NO₂ +27 µmol/m² above backgroundJul 27: NO₂ +26 µmol/m² above backgroundJul 28: NO₂ +25 µmol/m² above backgroundJul 30: NO₂ +33 µmol/m² above backgroundAug 4: NO₂ +30 µmol/m² above backgroundAug 5: NO₂ +37 µmol/m² above backgroundAug 10: NO₂ +30 µmol/m² above backgroundAug 11: NO₂ +13 µmol/m² above backgroundAug 14: NO₂ +27 µmol/m² above backgroundAug 15: NO₂ +28 µmol/m² above backgroundAug 16: NO₂ +34 µmol/m² above backgroundAug 18: NO₂ +39 µmol/m² above backgroundAug 19: NO₂ +88 µmol/m² above backgroundAug 21: NO₂ +18 µmol/m² above backgroundAug 23: NO₂ +36 µmol/m² above backgroundAug 24: NO₂ +77 µmol/m² above backgroundAug 26: NO₂ +24 µmol/m² above backgroundAug 27: NO₂ +28 µmol/m² above backgroundAug 28: NO₂ +13 µmol/m² above backgroundAug 29: NO₂ +131 µmol/m² above backgroundAug 31: NO₂ +45 µmol/m² above backgroundSep 7: NO₂ +35 µmol/m² above backgroundSep 8: NO₂ +117 µmol/m² above backgroundSep 13: NO₂ +57 µmol/m² above backgroundSep 16: NO₂ +36 µmol/m² above backgroundSep 17: NO₂ +130 µmol/m² above backgroundSep 18: NO₂ +153 µmol/m² above backgroundSep 21: NO₂ +54 µmol/m² above backgroundSep 22: NO₂ +38 µmol/m² above backgroundSep 23: NO₂ +5 µmol/m² above backgroundSep 25: NO₂ +64 µmol/m² above backgroundSep 26: NO₂ +37 µmol/m² above backgroundSep 27: NO₂ +19 µmol/m² above backgroundSep 28: NO₂ +71 µmol/m² above backgroundSep 29: NO₂ +134 µmol/m² above backgroundOct 5: NO₂ +41 µmol/m² above backgroundOct 6: NO₂ +115 µmol/m² above backgroundOct 7: NO₂ +75 µmol/m² above backgroundOct 8: NO₂ +43 µmol/m² above backgroundOct 9: NO₂ +39 µmol/m² above backgroundOct 11: NO₂ +33 µmol/m² above backgroundOct 12: NO₂ +34 µmol/m² above backgroundOct 15: NO₂ +31 µmol/m² above backgroundOct 17: NO₂ +8 µmol/m² above backgroundOct 18: NO₂ +48 µmol/m² above backgroundOct 19: NO₂ +50 µmol/m² above backgroundOct 20: NO₂ +54 µmol/m² above backgroundAug 1Aug 15Sep 1Sep 15Oct 1Oct 15
Firm contract, 193,200 Dth/dSep average = 600–820 MW ITOct 15–22 = 760–1,030 MW ITNone booked0100k200k300k400kDth/dNO₂ excess over background0100200Aug 1Sep 1Oct 1
Gas booked per dayAverage for the period, with the IT power draw it impliesDays with nothing booked
Daily scheduled deliveries to MZX Tech LLC on Texas Gas Transmission, July 23 to Oct. 22, 2026, in dekatherms a day (k = thousand). Each 100,000 Dth/d is about 270–370 MW of IT power draw. Below: daily NO2 over the site on the same days.

Since Oct. 14, bookings have been above MZX's firm pipeline contracts (193,200 a day as of Oct 1, 2026), so the extra rides on interruptible service or newer contracts; the postings do not say which. These are booked (scheduled) quantities, not metered flow: the pipeline does not publish what was actually burned. The conversion assumes a heat rate of 9,500–11,500 Btu per kWh and a PUE of 1.2–1.35.

What else could explain it

NOx from TVA's Southaven gas plant, tons per month
0102030JanFebMarAprMayJunJulAugSepOctNovDecJan 2025: 20.2 tons NOx, 548 GWhFeb 2025: 18.1 tons NOx, 514 GWhMar 2025: 19.8 tons NOx, 550 GWhApr 2025: 17.2 tons NOx, 467 GWhMay 2025: 4.5 tons NOx, 98 GWhJun 2025: 18.2 tons NOx, 483 GWhJul 2025: 19.7 tons NOx, 533 GWhAug 2025: 19.7 tons NOx, 531 GWhSep 2025: 16.6 tons NOx, 425 GWhOct 2025: 19.5 tons NOx, 527 GWhNov 2025: 10.6 tons NOx, 266 GWhDec 2025: 17.1 tons NOx, 471 GWhJan 2026: 18.5 tons NOx, 508 GWhFeb 2026: 16.0 tons NOx, 426 GWhMar 2026: 18.1 tons NOx, 502 GWhApr 2026: 14.0 tons NOx, 372 GWhMay 2026: 17.2 tons NOx, 480 GWhJun 2026: 18.2 tons NOx, 513 GWhJul 2026: 20.0 tons NOx, 534 GWhAug 2026: 20.1 tons NOx, 526 GWhSep 2026: 19.8 tons NOx, 505 GWh
0102030JanMarMayJulSepNovJan 2025: 20.2 tons NOx, 548 GWhFeb 2025: 18.1 tons NOx, 514 GWhMar 2025: 19.8 tons NOx, 550 GWhApr 2025: 17.2 tons NOx, 467 GWhMay 2025: 4.5 tons NOx, 98 GWhJun 2025: 18.2 tons NOx, 483 GWhJul 2025: 19.7 tons NOx, 533 GWhAug 2025: 19.7 tons NOx, 531 GWhSep 2025: 16.6 tons NOx, 425 GWhOct 2025: 19.5 tons NOx, 527 GWhNov 2025: 10.6 tons NOx, 266 GWhDec 2025: 17.1 tons NOx, 471 GWhJan 2026: 18.5 tons NOx, 508 GWhFeb 2026: 16.0 tons NOx, 426 GWhMar 2026: 18.1 tons NOx, 502 GWhApr 2026: 14.0 tons NOx, 372 GWhMay 2026: 17.2 tons NOx, 480 GWhJun 2026: 18.2 tons NOx, 513 GWhJul 2026: 20.0 tons NOx, 534 GWhAug 2026: 20.1 tons NOx, 526 GWhSep 2026: 19.8 tons NOx, 505 GWh
20252026
EPA Clean Air Markets Program Data, monthly apportioned emissions. The plant ran about the same in both years.

How this works: the Sentinel-5P satellite measures NO2 in the air over every point on Earth once a day, around 1:30 p.m. local time, in pixels about 5.5 by 3.5 km. NO2 comes from burning fuel (turbines, engines, traffic, power plants), so a rise over a site that open country does not share points to new combustion there. It shows combustion activity, not megawatts. The site box is about 15 km across; the background box is open country about 49 km away. We use only high-quality readings and drop days or weeks when cloud hides more than half of either box. Data: Copernicus Sentinel-5P (ESA), processed with the Copernicus Data Space Ecosystem Sentinel Hub statistics service; EPA Clean Air Markets Program Data for the TVA plant; Texas Gas Transmission informational postings (Boardwalk GasQuest) for gas bookings.

Permits

Permits checklist

1 enforcement · 1 withdrawn · 1 contested · 1 pending · 6 granted

Risks

What could slow it down

Also on record
Lawsuits

6 cases on record

Money

A $15B-a-year customer, and a contractor fight

Anthropic pays up to $1.25 billion a month for compute, but either side can walk on 90 days' notice. Meanwhile the prime contractor says it is owed hundreds of millions.

$1.25B/mo
Anthropic compute fee
through May 2029; either side can exit on 90 days' notice after month 3 SEC filing · May 2026
$20B+
announced Southaven investment
Jan. 2026, largest private investment in Mississippi News report · Jan. 2026
$550M
term loan for the power JV
term sheet, Sept. 2026 SEC filing · Sept. 2026
~$1.4B
paid to the prime electrical contractor
xAI's figure; it alleges $500–800M of overbilling
$118M
contractor lien on the Memphis hall
plus a $432M suit in DeSoto County Court filing · July 2026
$40M
cash to Southaven in a land swap
plus $3.46M road work and $1.38M to police News report · Sept. 2026
$72.9M
land purchase, 5420 Tulane Rd (Memphis hall)
DRG MCRE Southaven II Venture LP to CTC Property LLC, recorded March 2025 (county deed records) County deed records · March 2025
Land assembly

4 recorded land documents for the campus company in county records (March 2025); 3 list a price. 2 related-party transfers are shown greyed. 1 sale or conveyance by the campus company or to public bodies is not listed. Parcel counts come from the deed; acreage is not recorded.

Timeline

What happened, and what is due

SitePaper trailConstructionPowerPermitsMoneyLegalUpcoming
  1. March 20, 2024
    Paper trail CTC Property LLC registered in Tennessee
  2. April 15, 2024
    Construction Prime electrical contract signed with Darana Hybrid Court filing · Aug. 2024
  3. March 7, 2025
    Site Land purchase, $72.9M: DRG MCRE Southaven II Venture LP to CTC Property LLC, 5420 Tulane Rd (the Memphis hall), recorded March 2025 (county deed records) County deed records · March 2025
  4. May 16, 2025
    Paper trail MZX Tech LLC registered in Mississippi
  5. June 2025
    Site Land transfer, price not recorded: CTC Property LLC to MZX Tech LLC, three parcels including 5420 Tulane Rd, recorded June 2025 (county deed records) County deed records · June 2025
  6. July 16, 2025
    Site Former Duke Energy plant site bought in Southaven Court filing · July 2025
  7. Aug. 1, 2025
    Permits Mississippi exempts 18 temporary turbines News report · Aug. 2025
  8. Nov. 28, 2025
    Power 28 temporary turbines visible on satellite
  9. Jan. 8, 2026
    Money $20B+ Southaven expansion announced News report · Jan. 2026
  10. Jan. 17, 2026
    Construction Company says Colossus 2 is operational News report · Sept. 2026
  11. March 11, 2026
    Permits Air permit issued for 41-turbine, 1.2 GW plant State agency · March 2026
  12. April 14, 2026
    Legal NAACP files Clean Air Act suit Court filing · April 2026
  13. May 2026
    Money Anthropic signs compute agreements SEC filing · May 2026
  14. June 23, 2026
    Construction xAI terminates its prime contractor Court filing · Aug. 2026
  15. July 30, 2026
    Permits Agreed order: temporary fleet out by July 2027 Company · July 2026
  16. July 31, 2026
    Legal Contractor files $118M lien on the Memphis hall
  17. Aug. 20, 2026
    Power TVA approves direct grid service Utility regulator · Aug. 2026
  18. Aug. 21, 2026
    Legal Court postpones the NAACP injunction hearing, set for Aug. 24, until further notice Court filing · Aug. 2026
  19. Sept. 1, 2026
    Power Power JV upsized to ~900 MW; Southaven approves site plan SEC filing · Sept. 2026
  20. Sept. 18, 2026
    Legal With no ruling on its motion to intervene and dismiss, the United States appeals to the Fifth Circuit, calling the silence a constructive denial Court filing · Sept. 2026
  21. Sept. 21, 2026
    Legal The United States asks to stay the NAACP case, arguing an injunction would harm national security (its argument, citing a Department of War declaration) Court filing · Sept. 2026
  22. Sept. 23, 2026
    Legal Neighbors file a class action over round-the-clock noise from the turbine plant and the data centers Court filing · Sept. 2026
  23. End of 2026
    Power Deadline: 26 temporary turbines removed
  24. July 31, 2027
    Power Deadline: all temporary turbines removed
  25. Sept. 11, 2027
    Permits Deadline: start building the permanent plant
  26. March 20, 2028
    Legal Contractor dispute goes to jury trial
  27. May 2029
    Money Anthropic compute deal for Colossus 1 and 2 runs to here SEC filing · May 2026
Construction activity

Building activity by quarter

Since June 2023: 29 building permits (16 issued or finished, 6 pending or open, 7 withdrawn or expired); the largest lists a $614M job value; 1 FAA filing (Sept. 2026): a 271 ft crane; 3 OSHA inspections; and 123 satellite captures. Job values are not added up: trade permits often repeat the whole project's value.

Building permits
FAA filings
OSHA visits
Satellite
’24
’25
’26
Dot size: records in the quarter, largest = 24. Two-digit years mark each first quarter.
The buildings

Specs

642,660 sq ft
buildings on the Southaven site plan
810,000+ sq ft
MACROHARDRR on Stateline Rd, per a Sept. 2026 residents' complaint (allegation)
55.9 acres
site plan, plus 101 adjacent acres
~47 acres
mapped footprint of the Memphis site
190,154 m²
40 ft
building height
172
open xAI job postings tagged Memphis/Southaven (of 304)
Other data centers within 40 km (15)
This campus (footprint)
47 ac
MEM01 Memphis Data Center
24 ac
Memphis 2 Data Center
8 ac
MEM1 - Memphis Data Center
5 ac
Memphis Data Center
4 ac
Memphis 1 Data Center
3 ac
Who is involved

Owners, partners and builders

Owners
  • SpaceX (parent since Feb. 2026)
  • xAI
  • MZX Tech LLC: Mississippi assets (Wyoming LLC)
  • CTC Property LLC: Tennessee data centers
Decision-makers
  • Brent Mayo: manager, MZX Tech (xAI VP Operations)
  • Jared Birchall: secretary, MZX Tech
Power partners
  • Solaris Energy Infrastructure: 50.1% of Stateline Power
  • TVA: direct grid service
  • MLGW: Memphis utility
Builders and advisers
  • Darana Hybrid: prime electrical contractor (terminated June 2026)
  • Omega: turbine pads
  • Trinity Consultants: air permits
  • Burch Realty: home buyouts
Customer
  • Anthropic: compute across Colossus 1 and 2
Builders on site
  • Road Dog Industrial LLC: staffing/labor subcontractor to Darana (Louisville KY)
  • Ferguson Enterprises LLC: subcontractor/supplier lien claimant (~$4.2M lien, Sep 2026)
  • Omni: lien claimant
  • Mechanical Systems CO LLC: 3 building permits
  • Upchurch Services LLC: 3 building permits
  • Gephart Electrical Construction: 3 building permits
  • and 6 more contractors in the permit and inspection records
Still unknown

Open questions

Where this comes from

1,162 records from 107 documents

Drawn from court filings, news reports, state agency records, business registries, public and commercial datasets, company statements, securities filings, satellite captures, utility regulator dockets and local government records, each kept with its date and source. The bar shows documents by type.

Court filing 40News report 34State agency 13Dataset 10Company 9SEC filing 7Satellite 2Utility regulator 2Local government 2
Evidence

Every quote behind this page

Grade key: A = the primary record itself (permit, filing, exhibit) · B = a dated official statement · C = news reporting. Map distances are our own measurements on OpenStreetMap and carry no grade. Allegations in lawsuits are marked as such in the quotes.

Power (88)
  • EIA campd registration: not stated
    “monitors the current status of existing and proposed generating units at electric power plants with 1 megawatt or greater of combined nameplate capacity”
  • Nearest gas pipeline: Texas Gas Transmission, LLC 'Southhaven Lateral' at 0.19 km
    Measured on OpenStreetMap map data.
  • Index of Customers, Texas Gas Transmission, Oct 2026 edition (the only edition the platform serves): every MZX Tech LLC firm transportation contract books to Loc 24590 'MZX Deduct', Zone 1 - FT contract 59684, 80,000 Dth
    “MZX Tech LLC 139242295 FT 59684 08/01/2025 06/30/2035 80000; STF 60205 01/23/2026 12/31/2026 20000; STF 60741 05/07/2026 03/31/2027 93200; MZX Deduct 24590 Zone 1”
  • Battery storage on-site: battery storage pad at southern end of site
    “The site plan also includes a battery storage pad at the southern end of the property”
    grade A
  • IT capacity: 210 MW
    “At COLOSSUS II, we brought online the first cluster of approximately 110,000 GB200 processors, approximately 210 megawatts of compute power, even faster in 91 days”
  • IT capacity: 210 MW
    “At COLOSSUS II, we brought online the first cluster of approximately 110,000 GB200 processors, approximately 210 megawatts of compute power”
  • IT capacity: 220 MW
    “we brought online the second cluster of 110,000 GB300 processors and 220 megawatts of compute power in 64 days”
  • IT capacity: 400 MW
    “once fully operational, the next phase of expansion at COLOSSUS II will represent an additional 400MW of compute capacity”
  • SpaceX S-1 (filed May 20, 2026, CIK 1181412) defines COLOSSUS II as xAI data centers in Memphis, TN and Southaven, MS, part of a coherent gigawatt-scale AI training cluster, and discloses lawsuits alleging unpermitted gas
    “COLOSSUS II refers to our data centers in Memphis, Tennessee and in Southaven, Mississippi. These data centers are part of our coherent gigawatt-scale AI training cluster.”
  • Code names: Project Tulane (Macrohard); Duke (power plant site) - Darana correspondence
    “"Project Colossus, Project Tulane (Macrohard), Project Stateline (Macrohardrr), Duke" (Darana letter, 02994 Doc. 44-5 p. 2, authenticated by Doc. 44-2 ¶5)”
  • Owner companies: MZX Tech LLC
    “MZX Tech LLC 2875 Stanton Road Southaven, Desoto, Mississippi has been granted permission to construct air emissions equipment”
  • On-site generation: 1,200 MW
    “has been granted permission to construct air emissions equipment to comply with the emission limitations, monitoring requirements and other conditions set forth herein”
  • Utility: none, self-supply via MZX Tech LLC
    “MZX Tech LLC 2875 Stanton Road Southaven, Desoto, Mississippi”
  • Generator maker and model: Solar SMT-130 (Titan 130) 16.5 MW with SCR + oxidation catalyst; GE Vernova TM2500 Gen 6/7/8 25.0 MW, water injection only, no SCR; M35 35.0 MW, no SCR
    “Trinity Consultants (Shannon Lynn) emails to MDEQ list the fleet as SMT-130 16.5 MW (SCR, 2 ppm NOx), TM2500 25.0 MW (water injection, 25 ppm), M35 35.0 MW (no SCR)”
  • Code names: Duke (contractor-schedule codename for the 2875 Stanton Road S gas plant site)
    “In contractor schedules the site is referred to by the internal codename "Duke"”
  • On-site generation: 400.5 MW
    “Sept 6-10, 2025 plan: 18 turbines (7 SMT-130 = 115.5 MW; 10 TM2500 = 250 MW; 1 M35 = 35 MW) = 400.5 MW; later revised (Nov 4 email) to at least 354 MW”
  • Interconnection status: TVA direct service approved Aug 20, 2026 but NOT energized as of Oct 22, 2026: the TVA Board power availability resolution (Exhibit 08/20/2026P) contemplates the customer "begin taking initial pow
    “the new load requirement of the customer is greater than 100 megawatts (MW), and the customer has requested to begin taking initial power as early as November 2026”
  • Texas Gas postings: MZX scheduled quantity is 0 Dth/d at Loc 26096 for 13 consecutive gas days Oct 1-13, 2026; postings resume Oct 14 at the new Loc 24590 'MZX Deduct' at 278,000 Dth/d. Oct 15-22 run rate averages 281,62
    “Loc 26096, Total Scheduled Quantity 0 MMBtu (Effective Gas Days 20261001-20261013); Loc 24590, Loc Name "MZX Deduct", Total Scheduled Quantity 307709 MMBtu (Effective Gas Day 20261022)”
  • TVA direct service to MZX Tech (Board-approved Aug 20, 2026) NOT energized as of Oct 22, 2026: the Board resolution set initial power "as early as November 2026", and no TVA, MLGW, SpaceX or press source reports contract
    “the new load requirement of the customer is greater than 100 megawatts (MW), and the customer has requested to begin taking initial power as early as November 2026”
  • meter hand-off Oct 14 to Loc 24590 'MZX Deduct' at 278,000 MMBtu/d, held flat through Oct 20; Oct 1-20 total 1,946,000 MMBtu; Scheduled quantities only; Metered fuel evidence the plant was burning gas on every day Oct 14
    “Loc 24590, Loc Name "MZX Deduct", Total Scheduled Quantity 278000 MMBtu (Effective Gas Day 20261014)”
  • Nearest substation: unnamed tagged 500 kV at 0.44 km
    Measured on OpenStreetMap map data.
  • Nearest 500 kV line: 500 kV at 0.55 km (name: Freeport Sub TVA to Southaven Sub TVA 500KV)
    Measured on OpenStreetMap map data.
  • Power lines of 230 kV or more within 2 km: 15
    Measured on OpenStreetMap map data.
  • Texas Gas postings: Loc 26096 'MZX Southaven' scheduled an average of 223,414 Dth/d over 30 gas days in Sep 2026 (220,000 on Sep 4 rising to 247,830 on Sep 30) - gas-implied generation 810-980 MW, or 600-817 MW IT. Gas-i
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 220000 MMBtu (Effective Gas Day 20260904); 247830 MMBtu (Effective Gas Day 20260930)”
  • Texas Gas Transmission postings: Loc 26096 'MZX Southaven' scheduled 6,702,432 MMBtu over 30 gas days in Sep 2026 (average 223,414 MMBtu/d; 247,830 on Sep 30). Scheduled quantities only. Metered fuel evidence of continuo
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 247830 MMBtu (Effective Gas Day 20260930)”
  • Turbines at 2875 Stanton Rd S rose from 3 to 18 (Aug.-Sept. 2025), then 27, then 69; plaintiffs say the temporary turbines stay until at least July 2027 (allegation)
    “Defendants continued to increase the number of turbines - first to 27, and eventually to 69. Defendants have relied on these "temporary" turbines for the last year, and will continue to rely on them at least until July of 2027”
  • Complaint describes MACROHARDRR (over 810,000 sq ft, Stateline Road, Southaven) and "Minihard" (Tulane Road, Whitehaven) as additional xAI data centers under construction (allegation)
    “Defendants are building two additional data centers, "MACROHARDRR," spanning over 810,000 square-feet on Stateline Road in Southaven, and "Minihard," a more compact but equally powerful facility on Tulane Road”
  • IT capacity: 946 MW
    “CURRENT IT POWER, 946 MW, PROJECTED IT POWER, 1,531 MW”
  • Texas Gas postings: Loc 26096 'MZX Southaven' scheduled an average of 196,871 Dth/d over 31 gas days in Aug 2026 (195,000 on Aug 3 rising to 215,000 on Aug 31) - gas-implied generation 713-864 MW, or 528-720 MW IT. Gas-i
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 195000 MMBtu (Effective Gas Day 20260803); 215000 MMBtu (Effective Gas Day 20260831)”
  • Texas Gas Transmission postings: Loc 26096 'MZX Southaven' scheduled 6,103,000 MMBtu over 31 gas days in Aug 2026 (average 196,871 MMBtu/d; 215,000 on Aug 31). Scheduled quantities only; no flowed quantities published. M
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 215000 MMBtu (Effective Gas Day 20260831)”
  • Utility: TVA
    “On Aug. 20, the TVA Board of Directors approved a load request greater than 100 megawatts for MZX Tech LLC”
  • Electric service agreement signed: Aug. 20, 2026
    “Tennessee Valley Authority has entered into a service agreement with SpaceXAI... Dan Pratt said MZX Tech LLC will be a direct TVA customer”
  • Power plan: hybrid (behind-the-meter gas plant + BESS + TVA direct grid service)
    “operated via off-grid connection using a combination of microgrids... TVA direct service agreement for load greater than 100 megawatts”
  • EDGAR full-text 'MZX Tech' returns 19 hits; top hits are Solaris Energy Infrastructure 10-Qs filed May 1, 2026 and Aug. 6, 2026 (Solaris is the turbine lessor behind MZX Tech)
    “MZX Tech: 19 EDGAR full-text hits; top hits Solaris Energy Infrastructure, Inc. 10-Q”
  • Texas Gas Transmission informational postings (BWP GasQuest, Operational Capacity): MZX Tech LLC delivery point Loc 26096 'MZX Southaven' scheduled an average of 183,333 Dth/d over the 9 posted gas days Jul 23-31, 2026 (
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 180000 MMBtu (Effective Gas Day 20260723); 190000 MMBtu (Effective Gas Day 20260729)”
  • Texas Gas Transmission postings (BWP GasQuest): MZX Tech delivery meters scheduled 1,650,000 MMBtu over 9 posted gas days Jul 23-31, 2026 (Loc 26096 'MZX Southaven'; 180,000 MMBtu on Jul 23 rising to 190,000 on Jul 29);
    “Loc 26096, Loc Name "MZX Southaven", Total Scheduled Quantity 180000 MMBtu (Effective Gas Day 20260723); 190000 MMBtu (Effective Gas Day 20260729)”
  • Temporary fleet nameplate capacity: 1775.72 MW
    “MZX operates sixty-nine (69) portable, temporary simple cycle natural gas-fired combustion turbines”
  • Temporary fleet expected local power output: 1,702 MW
    “Expected local power output is estimated based on ambient conditions of 59 °F and 60 percent humidity”
  • On-site units temporary peak: 69
    “fixed removal timeline for all 69 of the temporary, mobile turbines... All temporary turbines will be removed by July 2027”
  • On-site power technology: simple-cycle gas turbines (temporary mobile fleet being removed by Jul 2027; 41-unit permanent plant permitted) plus Tesla Megapack BESS
    “removing these mobile turbines as we bring online permanent power from a 1.2 gigawatts power plant”
  • Emissions NOx potential: >1700 (27 turbines); approaching 2500 at 33+ tons/yr NOx
    “first 27 turbines alone have the potential to emit over 1,700 tons/year of NOx; approaching 2,500 tons/year at 33+ turbines (plaintiff allegation)”
  • On-site units permanent: 41
    “Air Ref. No. 0680-00119 (forty-one turbines, 1.2 gigawatts)... listing units TUR-1 through TUR-41”
  • On-site generation: 495 MW
    “Dec 18, 2025 - Feb 2026: total 27 turbines, combined capacity at least 495 MW (14 SMT-130, 1 M35, 4 Gen 6 + 5 Gen 7 + 3 Gen 8 TM2500)”
  • Grid option mlgw: up to 1.1 GW discussed by MLGW for the Tulane Road site
    “MLGW discussed grid options for up to 1.1 GW for the site”
  • Name: MACROHARDRR
    “The data center, which will be known as MACROHARDRR, is in proximity to xAI's newly acquired power plant site in Southaven”
  • Stated campus size: not stated
    “Upon completion, the Southaven data center will increase the company's computing power to nearly 2 gigawatts”
  • On-site units firing observed: 9 of 18 (5 SMT-130, 4 TM2500)
    “Oct 31, 2025 SouthWings aerial + FLIR thermal imaging: 18 turbines on site, at least 9 actively firing”
  • Square feet: 810258 (distribution warehouse) sq ft
    “810,258 sq ft distribution warehouse on ~48 acres (LocalMemphis) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Acres: ~48 acres
    “810,258 sq ft distribution warehouse on ~48 acres (LocalMemphis) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Sq ft 5420 tulane main building: 1007838 (main warehouse, built 2023) plus a 42,900 sq ft one-story Macrohard Office buildout
    “1,007,838 sq ft main warehouse (built 2023) + 42,900 sq ft 1-story "Macrohard Office" buildout on 108.00 acres (Datacentres.com, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Acres: 108.00 (5420 Tulane Rd parcel, press) acres
    “1,007,838 sq ft main warehouse (built 2023) + 42,900 sq ft "Macrohard Office" buildout on 108.00 acres (Datacentres.com, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Bess units: 60-70 Tesla Megapacks at 5420 Tulane Rd
    “60 to 70 Tesla Megapacks installed at 5420 Tulane Road (Colossus 2) to smooth load and provide backup power (LocalMemphis, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Chips: NVIDIA GB200 (first ~110k cluster) and GB300 (later clusters)
    “Phase 1: 110,000 Nvidia GB200 GPUs ... 440,000 Nvidia GB300 GPUs by late September 2026 (Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Cooling: designed for 50% greywater cooling / 50% air cooling (5420 Tulane Rd)
    “Colossus 2 (5420 Tulane Road) was designed for 50% greywater cooling and 50% air cooling (LocalMemphis, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Utility service: not stated
    “The Stanton Road power plant is expected to power the nearby data centers along Tulane Road and Stateline Road”
  • Stage: at risk
    “filed an appeal challenging the Mississippi Department of Environmental Quality's decision to issue an air permit to xAI's affiliate company, MZX Tech”
  • Rate class: TVA Large Data Service data center rate (+10% average; Capacity Commitment Charge ~$1.5M/MW for new load >5 MW; effective Oct. 1, 2026)
    “Beginning with TVA's fiscal year 2027... charges approximately $1.5 million per megawatt Capacity Commitment Rider to new or expanded data center loads above the first five megawatts”
  • Opposition: Safe and Sound Coalition (Southaven residents); NAACP; Young Gifted & Green; Memphis Community Against Pollution; >1400 petition signatures by Oct 2026
    “The Safe and Sound Coalition... has collected more than 1,400 signatures on a petition calling for the power plant to be shut down”
  • Second-tier lien wave: Ferguson ~$4.2M; Omni ~$597k (work through June 9, 2026); ~$53M of additional subcontractor liens by late Sep 2026
    “~$53 million in additional subcontractor liens filed by late September 2026 (Powerboat News) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Wikipedia (via dossier): Colossus 2 at 300-350k GPUs by mid-2026 and 440,000 GB300 by late Sep 2026, with 660,000 more scheduled by YE2026 - unverified, single secondary source
    “Expanded to 300,000-350,000+ GPUs by mid-2026 and 440,000 Nvidia GB300 GPUs by late September 2026, with a further 660,000 GPUs scheduled by year-end 2026 (Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • 11 of 69 temporary turbines shut off/removed by Aug 31 2026; agreed-order amendment targets 26 removed in 2026
    “Eleven turbines have been removed since August, with plans to remove an additional 16 turbines by Dec. 31, 2026”
  • MDEQ issued five air quality action days in DeSoto County in August 2026 (annual average is seven); American Lung Association grades the area F for ozone
    “In August, the MDEQ issued five air quality action days in DeSoto County”
  • On a SpaceX earnings call Musk described meeting 20 GW of demand with 15 GW from a SpaceX AI power plant, identified by the Commercial Appeal as the Stanton Road facility
    “That power plant is currently the Stanton Road facility in Southaven”
  • Noise or water complaints: Haley et al. v. X.AI Corp. (N.D. Miss.): noise/vibration nuisance class action; Carter v. X.AI Corp. (W.D. Tenn. 2:26-cv-03257): sleep disruption, headaches, tinnitus; resident decibel readings
    “noise and vibration from xAI and MZX's massive power plant at 2875 Stanton Road South... is disrupting the lives of nearby residents”
  • x.AI alleges ~$1.4B paid to Darana Apr 2024-Jul 2026 (Cuttell says ~$1.5B of work) and $500M-$800M overbilling: >=75% of labor subcontracted without consent, billed $125-$245/hr vs $21.60-$112.50/hr paid; markups 200-300
    “Between April 2024 and July 2026, SpaceXAI entities paid Darana Hybrid approximately $1.4 billion (Doc. 1 allegation) ... $500 million to $800 million in alleged overcharges (Drag Illustrated, Powerboat News) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Generator maker and model: Solar Turbines Titan 350 / SMT-360 (temporary fleet)
    “it was reported that Colossus 2 had power from seven installed SMT-360/Titan-350 gas turbines”
  • Delta Industries concrete truck struck a transformer at the Colossus 2 site; $533,000 insurance-claim dispute (disclosed in Delta Industries v. Darana, S.D. Miss., filed July 24, 2026, dismissed Aug. 27, 2026)
    “a concrete truck operated by supplier Delta Industries, Inc. struck a SpaceXAI transformer at the Colossus 2 site, resulting in a $533,000 insurance claim dispute (Powerboat News) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Interconnection status: Before that approval the campus ran primarily behind-the-meter / off-grid (Southaven turbines, solar and Megapacks); SpaceXAI builds the transmission lines and transformers to serve the direct loa
    “On Aug. 20, the TVA Board of Directors approved a load request greater than 100 megawatts for MZX Tech LLC, an affiliate of SpaceXAI.”
  • large load interconnection request: approved - direct TVA service, MW not disclosed
    “On Aug. 20, the TVA Board of Directors approved a load request greater than 100 megawatts for MZX Tech LLC, an affiliate of SpaceXAI.”
  • Combined-campuses context only, NOT a Colossus 2 campus fact: before the Aug 20, 2026 TVA direct-service approval, MLGW provided less than 160 MW to SpaceXAI between its two Shelby County campuses (Colossus 1 at Paul R.
    “MLGW is providing less than 160 megawatts to SpaceXAI between its two Shelby County campuses (Tulane Road and Paul R. Lowry Road).”
  • Rate context only: at the same Aug 20, 2026 meeting the TVA Board passed a new data center rate (about a 10% increase for data centers over 5 MW); MZX Tech LLC as a direct TVA customer will abide by that rate. Generally
    “MZX Tech LLC will be a direct TVA customer and will abide by the new rate for data centers”
  • Darana's Tulane lien recorded as Shelby County Instrument #26064953 ($118,246,160.35, against MZX Tech LLC)
    “$118,246,160.35 Darana lien (Shelby Co; Inst. #26064953, recorded July 31, 2026) (Powerboat News) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • On-site units temporary peak: 69
    “establishing a fixed removal timeline for all 69 of the temporary, mobile turbines that currently power our facility in Southaven, Mississippi”
  • Power plan: behind-the-meter self-supply (dedicated gas plant + mobile turbines + battery storage)
    “permanent power from a 1.2 gigawatts power plant we are constructing under our Clean Air Act permit”
  • Actual turbine runtime from the operator's own records (MZX Tech average runtime data on the portable turbines, Jul 10, 2026, produced in NAACP v. xAI, 3:26-cv-00074, as reported Oct 7, 2026): in June 2026, fifteen of th
    “In June, fifteen of those portable turbines ran 20 hours a day or more, on average. That's from the company's own records.”
  • IT capacity: 250 MW
    “It holds approximately 200,000 GPUs and delivers about 250 MW of IT compute”
  • SpaceX's S-1 risk factors, as summarized in coverage of the filing, disclose that environmental groups have sued over the Southaven turbines, putting required permits at risk
    “environmental groups have sued SpaceX over natural-gas turbines powering AI data centers in Southaven, Mississippi, putting required permits at risk”
  • On-site generation: 1,240 MW
    “41 simple-cycle combustion turbines totaling 1,240 MW permitted on March 11, 2026 under MDEQ Permit 0680-00119 at 2875 Stanton Road South (Wikipedia, EIP Oil & Gas Watch) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Emissions NOx potential: 423.4 (permanent 41-turbine PSD permit) tons/yr NOx
    “potential emissions of 423.4 tons/year NOx, 417.4 tons/year VOC, 364.2 tons/year CO ... 6,410,729 tons/year CO2e (EIP Oil & Gas Watch, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Emissions co2e potential: 6410729 (permanent 41-turbine PSD permit) tons/yr CO2e
    “Permit No. 0680-00119 ... 6,410,729 tons/year CO2e (EIP Oil & Gas Watch, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Aliases: Colossus 3
    “They will also supply power to the firm's upcoming Colossus 3 data center in Mississippi”
  • On-site generation: 1,200 MW
    “xAI has received permission to install 41 natural gas turbines at a site in Mississippi that will generate 1.2GW to power its data centers in the area.”
  • Generating units on the permit: 41 natural gas turbines, 16.48 MW to 50 MW each
    “The new permanent plant will use 41 turbines ranging from 16.48 megawatts to 50 megawatts each, according to Mississippi permit documents.”
  • On-site generation: 1,200 MW
    “approved an operations permit for 41 turbines... permanent power from a 1.2 gigawatts power plant”
  • Project first announced by Elon Musk on X (Dec 30, 2025); formal Mississippi announcement Jan 8, 2026
    “MACROHARDRR pushes our Colossus training compute to ~2GW – by far the most powerful AI system on Earth”
  • Land control date: Dec. 2025 (MZX Tech LLC bought from ET Southaven V, LLC; dossier says mid-December / Dec. 30, 2025)
    “MZX Tech, LLC (purchased from ET Southaven V, LLC) ..; Acquired mid-December 2025; the December 30, 2025 purchase of the 810,258 sq ft third building (LocalMemphis) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Utility service: 0.5 MW
    “MLGW (Jul 22, 2025): "The general services agreement with this location is supplying around .5 MW of power ..; MLGW is not supplying power to their supercomputer, Colossus 2." (512 Pixels) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Land control date: Feb. 26, 2025 (5420 Tulane Rd deed: X Holding Corp. from Distribution Realty Group, LLC; $72.9M allocation of an $80M three-parcel sale)
    “X Holding Corp.: Recorded deed buyer of the 5420 Tulane Road property on February 26, 2025 from seller Distribution Realty Group, LLC (Datacentres.com) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
Money and contracts (67)
  • Square feet: 642660 sq ft
    “two structures connected by a climate-controlled breezeway... one building totaling approximately 642,660 square feet”
    grade A
  • Acres lien parcel tulane: 78.555 (3,421,865 sq ft land; proposed Parcel 1) acres
    “Attached legal description: 3,421,865 square feet / 78.555 acres, more or less, proposed Parcel 1; Prior deed reference Instrument 22069099, to DRG MCRE Southaven II Venture, LP (Doc. 1-1 p. 59) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Contractor first work date: Feb. 27, 2025 (Darana first work at Tulane; last work/services June 23, 2026)
    “Sworn lien notices give ..; Tulane first work February 27, 2025, and last furnished work/services June 23, 2026 (Doc. 1-1 p. 68); CTC/MZX admit approximate start dates (Doc. 23 ¶¶8, 12) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Mechanic's lien (Tennessee): sworn claimed unpaid balance - 5420 Tulane Rd 118246160.35 USD
    “Sworn claim amounts: ..; Tulane $118,246,160.35 ..; Signed under oath by Brandy Petrak, Senior Accountant, July 29/30; Claimed unpaid balances, not adjudicated debts [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • phase delivery: delivery 400 MW compute power (additional; 'over 400 MW', at least 220,000 additional GB300 processors)
    “We expect that once fully operational, the next phase of expansion at COLOSSUS II will bring online at least 220,000 additional GB300 processors and over 400 additional megawatts of compute power.”
  • Darana letter to x.AI: overdue invoices $139,031,735.51 as of May 11, 2026 (multi-site: Colossus, Tulane, Stateline, Duke); warns payment delays affect staffing stability, vendor performance, material availability and sche
    “Darana states overdue invoices totaled $139,031,735.51 as of May 11, 2026 ... payment delays affect "staffing stability, vendor performance, material availability, scheduling continuity."”
  • Tenants: Anthropic PBC - compute customer under May 2026 Cloud Services Agreements covering COLOSSUS (Memphis) and COLOSSUS II (Southaven); ~325,000 NVIDIA GPUs; $1.25B/month through May 2029; a compute services contract
    “in May 2026, we entered into Cloud Services Agreements with Anthropic PBC, with respect to access to compute capacity across COLOSSUS and COLOSSUS II”
  • Tenant status: Signed Cloud Services Agreements per SEC filing (Anthropic, May 2026); terminable by either party after the initial three-month period on 90 days notice
    “After the initial three-month period, the agreements may be terminated by either party upon 90 days notice”
  • Cloud Services Agreements (compute services): monthly compute services fee 1250000000 USD per month
    “the customer has agreed to pay us $1.25 billion per month through May 2029”
  • Cloud Services Agreements (compute services): scope - compute capacity across COLOSSUS and COLOSSUS II (both sites) 325000 NVIDIA GPUs (approx.)
    “Compute capacity provided includes approximately 325,000 NVIDIA GPUs, backed by hyperscale-class CPUs, exabyte-scale storage and high-speed networking”
  • Cloud Services Agreements (compute services): reduced-fee ramp - capacity ramping in May and June 2026 at a reduced fee; full $1.25B/month rate applies after the ramp
    “with capacity ramping in May and June 2026 at a reduced fee”
  • Cloud Services Agreements (compute services): termination - after the initial three-month period, either party may terminate upon 90 days notice
    “After the initial three-month period, the agreements may be terminated by either party upon 90 days notice”
  • Cloud Services Agreements (compute services): customer IP - customer retains ownership and intellectual property rights in its content, AI models and related data
    “The customer will retain ownership and intellectual property rights in its content, AI models, and related data”
  • SpaceX S-1/A (verified first-hand) discloses May 2026 Anthropic Cloud Services Agreements covering COLOSSUS and COLOSSUS II (~325,000 GPUs; $1.25B/month through May 2029 after a reduced-fee May-Jun 2026 ramp; terminable
    “the customer has agreed to pay us $1.25 billion per month through May 2029, with capacity ramping in May and June 2026 at a reduced fee”
  • MSA Amendment 2 (RSU allocation): milestone allocation 110,000 and 330,000 GPU milestones to Darryl Cuttell; 220,000 milestone to Rodney Caudill (key employee)
    “Amendment 2, signed February 19, 2026, allocates 110,000/330,000 milestones to Darryl Cuttell, 220,000 milestone to Rodney Caudill, key employee [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement: billing rate - Tulane (Amendment 1) 200 USD/hour
    “Amendment 1: $245/hour Colossus; $200/hour Tulane, unless an accepted PO sets a lower rate; Effective last signature, April 12, 2025 [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • MSA Amendment 1 (equity incentive): RSU award tied to GPUs commissioned at Tulane 28500000 total = three 9,500,000 RSU awards at 110,000 / 220,000 / 330,000 GPUs commissioned at Tulane, each as determined by the Board (s
    “110,000; 220,000; 330,000 GPUs commissioned at Tulane, each "as determined by the Board." $28.5 million total, three $9.5 million RSU awards [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • MSA Amendment 1 (exclusivity): exclusivity and forfeiture 24 months from Amendment 1 effective date (to ~April 12, 2027): no third-party data-center infrastructure projects; continued services required for vesting; noncompli
    “24 months from Amendment 1's effective date; no third-party data-center infrastructure projects; Continued services/compliance required for vesting [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement (prime electrical/mechanical contractor): effective date, signatures and term effective April 15, 2024; signed May 2, 2024 (Darryl Cuttell, Darana CEO) and Aug. 5, 2024 (Dan Rowland, CTC); term runs un
    “MSA effective April 15, 2024; signature dates May 2, 2024, Cuttell, and August 5, 2024, Rowland; Term runs until termination of all SOWs [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement: subcontractor/supplier markup cap 10 %
    “Subcontractor/supplier markup "shall not exceed ten percent (10%)" (MSA §2.4) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement: payment terms (undisputed invoices) 45 days
    “Undisputed invoices payable within 45 days; specified withholding rights (MSA §4.1) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement: schedule / liquidated damages substantial completion date and LD amount left to each SOW; delay extension needs notice within 7 days and a critical-path impact
    “Substantial completion date and liquidated-damage amount are left to each SOW; no project-wide completion date; Delay extension requires notice within 7 days and a critical-path impact [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Master Services Agreement: downstream lien discharge 3 days after filing
    “Contractor must discharge subcontractor/supplier liens within 3 days after filing; company can discharge at contractor expense (§4.2.1) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • tax incentive: termination
    “The Mississippi Development Authority has approved xAI for its Data Center Incentive”
  • fee-in-lieu: termination
    “The City of Southaven and DeSoto County are also supporting xAI's projects through fee-in-lieu agreements”
  • fee-in-lieu: termination
    “The City of Southaven and DeSoto County are also supporting xAI's projects through fee-in-lieu agreements”
  • MSA Amendment 3 (draft): status not formally executed - draft rates are not signed terms
    “The draft third amendment is expressly described as not formally executed (Doc. 39 p. 22 ¶75)”
  • Supplier remittance payment (multi-site): payment for identified supplies incl. "Duke Turbines Wire" 44394472.54 USD
    “CTC says it paid $44,394,472.54 on July 2, 2026 (allegation) for identified supplies. Reproduced descriptions include "Duke Turbines Wire" ... not campus capex”
  • Power supply / JV contract: capacity upsized from 500 MW to approx. 900 MW of off-grid generation; term extended 6 to 7 years 900 MW
    “signed an initial service commercial contract earlier this year for 500MW... increased to 900MW... extended, from six years to seven”
  • JV financing: senior secured term loan facility (term sheet executed) 550000000 USD
    “finalizing definitive documentation for up to $550 million in the form of a senior secured term loan facility”
  • Master Services Agreement: termination for cause terminated by CTC
    “CTC/MZX admit terminating Darana on June 23 (Doc. 23 p. 3); MSA termination for cause on June 23, 2026 (allegation; Doc. 39 ¶114) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Direct service agreement: load greater than 100 MW approved; MW and collateral not disclosed
    “approved a load request greater than 100 megawatts for MZX Tech LLC... The specifics of the deal were not disclosed”
  • Direct service agreement: clause: customer builds own transmission lines and transformers
    “SpaceXAI will build the infrastructure necessary, such as transmission lines and transformers, to service the load”
  • Contribution documents: board 7-0 authorized mayor to sign MZX Tech's own versions of two contribution documents (Stateline Road project; police donation)
    “the board voted 7-0 to let the mayor sign MZX Tech's own versions of two contribution documents”
  • Tenants: xAI (owner-occupied)
    “xAI has purchased and is retrofitting a building to house the new data center operations”
  • Stated capital cost: 20000000000 USD
    “The project will represent a corporate investment exceeding $20 billion and will create hundreds of permanent jobs throughout DeSoto County”
  • Incentives: MDA Data Center Incentive (sales and use tax exemption); City of Southaven and DeSoto County fee-in-lieu agreements
    “The Mississippi Development Authority has approved xAI for its Data Center Incentive, which provides a sales and use tax exemption for all computing and equipment software”
  • tax incentive: scope
    “provides a sales and use tax exemption for all computing and equipment software used by companies certified as data centers by the agency”
  • fee-in-lieu: scope
    “The City of Southaven and DeSoto County are also supporting xAI's projects through fee-in-lieu agreements”
  • MZX Tech LLC buys former Duke Energy Southaven CC plant site (2875 Stanton Road) - Special Warranty Deed from Julie M James dated Jul 16 2025, recorded Jul 18 2025
    “Special Warranty Deed from Julie M James to MZX Tech LLC (dated July 16, 2025) (recorded July 18, 2025)”
  • Land purchase (recorded deed): contract value USD
    “Recorded: June 30, 2025 · Grantor: CTC PROPERTY LLC · Grantee: MZX TECH LLC · Parcel number: 077-085- - -00007 · Address: 5420 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value 1793782 USD
    “Recorded: March 7, 2025 · Price: $1,793,782 · Grantor: DRG INDUSTRIAL FUND I STATELINE PAR · Grantee: CTC PROPERTY LLC · Parcel number: 077-085- - -00005 · Address: 5408 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 7, 2025 · Grantor: DRG MCRE SOUTHAVEN II VENTURE LP · Grantee: CTC PROPERTY LLC · Parcel number: 077-085- - -00006 · Address: 5420 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 7, 2025 · Grantor: CTC PROPERTY LLC · Grantee: MT JOYNER MISSIONARY BAPTIST CHURCH · Parcel number: 077-085- - -00005 · Address: 5408 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value 5176991 USD
    “Recorded: March 7, 2025 · Price: $5,176,991 · Grantor: DRG INDUSTRIAL FUND I STATELINE PAR · Grantee: CTC PROPERTY LLC · Parcel number: 077-085- - -00006 · Address: 5414 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value 72929226 USD
    “Recorded: March 7, 2025 · Price: $72,929,226 · Grantor: DRG MCRE SOUTHAVEN II VENTURE LP · Grantee: CTC PROPERTY LLC · Parcel number: 077-085- - -00007 · Address: 5420 TULANE RD · City: MEMPHIS”
  • Land purchase (recorded deed): contract value 1346400 USD
    “Recorded: June 22, 2022 · Price: $1,346,400 · Mortgage1amount: 46000000 · Grantor: DRG INDUSTRIAL FUND I STATELINE PAR · Grantee: DRG MCRE SOUTHAVEN I VENTURE LP · Parcel number: 077-085- - -00007 · Address: 5420 TULANE RD · City: MEMPHIS”
  • Tenant status: Owner-occupied; no lease. Third-party compute customers are reported for the wider Colossus cluster, not documented for this building
    “it runs off-grid and serves the multi-tenant roster set out in Section I, with xAI training its own Grok-5 there”
  • Police donation: amount earmarked for police department per city records 1380000 USD
    “xAI's subsidiary sent Southaven 1.38 million dollars earmarked for the police department”
  • fee-in-lieu: scope
    “The city of Southaven signed a fee-in-lieu agreement with SpaceXAI for the data center on Jan. 9, the day after the governor's public announcement”
  • infrastructure agreement: scope 3460000 USD
    “the city accepted a $3.46 million deal from MZX Tech LLC to complete construction on widening and resurfacing Stateline Road from Tulane Road to U.S. Highway 51”
  • land swap: scope 40000000 USD
    “The land swap deal grants SpaceXAI 51 acres across from the Stanton Road power plant, which was previously used by the Southaven Police Department and Fire Department”
  • regulatory agreed order: scope
    “According to an amendment to the agreement order, signed Sept. 11, 26 turbines will be removed this year”
  • MZX Tech donated $1,380,900 to the Southaven Police Department (Feb 2026) and the Musk Foundation granted $1.85M to the city (Dec 29, 2025), both alongside the project agreements
    “In February, MZX Tech made a $1,380,900 donation to the Southaven Police Department”
  • MZX Tech (via Burch Realty Group) mails buyout offers to Colonial Hills/Southaven homeowners: purchase in exchange for release of all claims in the Haley class action; offers reported $5,000-$10,000 above Zillow list
    “offering to purchase real estate in Southaven in exchange for, among other things, a release of all claims related to the lawsuit”
  • joint venture: scope 900 MW
    “Stateline Power LLC, 50.1% Solaris Energy Infrastructure and 49.9% xAI, is the vehicle for about 900 megawatts of primary power to the data centre”
  • Land swap agreement: land exchange: city gives Tulane Road property (8425 Tulane Rd, former police/fire training site); MZX gives 69 acres on Swinnea Road acres
    “Southaven gave MZX Tech LLC the Tulane Road property in exchange for 69 acres along Swinnea Road and $40 million”
  • Land swap agreement: cash to city for new city facilities 40000000 USD
    “They made an offer the city couldn't really refuse”
  • regulatory agreed order: scope
    “We have entered into an agreed order with the Mississippi Department of Environmental Quality (MDEQ) establishing a fixed removal timeline for all 69 of the temporary, mobile turbines”
  • regulatory agreed order: condition
    “We will begin removing temporary turbines from the site as early as August 2026. All temporary turbines will be removed by July 2027”
  • Buildings: 1
    “retrofitted to host data center operations on roughly 47 acres in a single building of 810,225 square feet”
  • Site acres: 47 acres
    “retrofitted to host data center operations on roughly 47 acres in a single building of 810,225 square feet”
  • Stated capital cost: 20000000000 USD
    “xAI is investing over $20 billion in the 'MACROHARDRR' data center in Southaven, MS”
  • Safe and Sound Coalition presents 'Shut Down xAI' petition (900+ signatures in January reporting; 1,400+ by Oct 2026); press coverage ties it to the Jan 8 2026 $20B announcement
    “presented a 'Shut Down xAI' petition with over 900 signatures”
  • xAI / Gov. Reeves announce >$20B MACROHARDRR Southaven investment (largest private investment in MS history); operations start targeted Feb 2026
    “The corporate investment exceeds $20 billion... Operations are scheduled to begin in February 2026”
  • MOU - road improvements: xAI fully funds State Line Road widening/resurfacing (facility to Highway 51; resurfacing to I-55) 3460000 USD
    “the board approved an MOU for XAI to fully fund $3,460,000 in State Line Road widening/resurfacing”
  • Announced: March 2025
    “Announced by the Memphis Chamber of Commerce on Friday, the land in the Whitehaven area of the city cost xAI $80 million, according to property records.”
Permits and government (79)
  • AP HOLDINGS SOUTHAVEN LLC, Southaven MS; present in ECHO Air radius but NOT xAI : permit record in radius search
    “AP HOLDINGS SOUTHAVEN LLC; Southaven MS”
  • 3 are 'Project Pyramid' cranes in Crittenden County AR (a different project); no case attributable to xAI/Colossus 2 (
    “61 cases”
    FAA · Oct. 2026 · grade A
  • Southaven 5 NM circle @ 34.9818,-90.0402 returned 229 cases; nearest named cases are Rite Hite Horn Lake MEM125 cranes, n
    “MEM125 - Rite Hite Horn Lake TI; 260 ft Crane”
    FAA · Oct. 2026 · grade A
  • land use, site plan: approved
    “The site plan includes two structures connected by a climate-controlled breezeway. For purposes of bulk regulation calculations, the structures are considered one building totaling approximately 642,660 square feet”
    grade A
  • City of Southaven Mayor and Board of Aldermen: Planning Agenda Items 1-2: MZX Tech one-lot subdivision approval and design review approval for a storage warehouse, Stanton Road
    “Application by MZX Tech for design review approval of a storage warehouse to be located on the south side of Stanton Road, west of Tulane Road”
    grade A
  • Southaven Planning Commission: MZX Tech: one-lot subdivision; design review; site plan (data storage warehouse, 55.89 acres)
    “Choat-Cook said the site plans were approved by the planning commission unanimously”
    grade A
  • City of Southaven Planning Commission: MZX Tech subdivision, design review and site plan, 55.89 acres south of Stanton Road, west of Tulane Road
    “Applicant: MZX Tech, LLC 2875 Stanton Road Southaven, MS 38671”
    grade A
  • MCEQ/MDEQ agreed order with MZX Tech LLC stating MZX operates 69 portable tempor: Agreed Order - operation of 69 mobile turbines acknowledged; emissions testing and bi-weekly deactivation reporting imposed
    “MZX operates sixty-nine (69) portable, temporary simple cycle natural gas-fired combustion turbines”
  • MDEQ PSD air construction permit for MZX Tech LLC, 2875 Stanton Rd S, Southaven : PSD Permit to Construct issued - 41 stationary combustion turbines (permanent plant)
    “Initial performance stack testing shall be conducted within 180 days of startup on twelve (12) turbines”
  • air, PSD permit: issued
    “has been granted permission to construct air emissions equipment to comply with the emission limitations, monitoring requirements and other conditions set forth herein”
  • FAA obstruction evaluation (7460-1): Evaluating
    “ASN 2026-ASO-18584-OE: 330T - Gun Range Datacenter, Crane, 271 ft AGL, 559 ft AMSL, 34.98028,-90.04050, Evaluating, submitted 2026-09-29”
  • FAA OE/AAA filing for a 271-ft crane described as '330T - Gun Range Datacenter' at the Southaven power-campus outline (submitted Sept. 29, 2026, status Evaluating) evidences crane work at the campus in fall 2026.
    “ASN 2026-ASO-18584-OE: 330T - Gun Range Datacenter, Crane, 271 ft AGL, 559 ft AMSL, 34.98028,-90.04050, Evaluating, submitted 2026-09-29”
  • building/electrical permits (contractor of record): Darana requested immediate voidance of all permits issued to Darana at Colossus and Tulane (allegation)
    “Darana requested the "immediate voidance of all permits issued to Darana" at Colossus and Tulane the day after termination ... more than $8 million (allegation) (Doc. 39 p. 43 ¶¶136-137)”
  • building permit: Commercial mechanical permit / Install: triage
    “Permit number: COM-MEC-26-001212 · Type: Commercial mechanical permit · Status: triage · Job value: $2,261,402 · Effective date: Sept. 10, 2026 · Business: Walker J Walker INC (m000) · Address: 5420 TULANE RD · Description: Furnish and install (2) wshp ahu (32) vav boxes (7) dss (1) electric boiler (6) pumps (”
  • TVA Board power availability resolution for a new directly served customer (iden: approved - firm power availability, directly served customer
    “the new load requirement of the customer is greater than 100 megawatts (MW), and the customer has requested to begin taking initial power as early as November 2026”
  • TVA Board of Directors: Load request >100 MW for MZX Tech LLC (direct service); new data center rate class with Capacity Commitment Charge
    “approved a load request greater than 100 megawatts for MZX Tech LLC”
  • Agreed order (temporary fleet removal): agreed order entered
    “All temporary turbines will be removed by July 2027. Today's agreed order codifies our commitment”
  • building permit: Commercial plumbing permit / Alteration: issued
    “Permit number: COM-PLM-26-000791 · Type: Commercial plumbing permit · Status: issued · Job value: $6,000,000 · Effective date: July 14, 2026 · Business: Mechanical Systems CO LLC (p00 · Address: 5420 TULANE RD · Description: Phases I ii and III”
  • building permit: Commercial mechanical permit amendment / Install: triage
    “Permit number: AMD-26-00737 · Type: Commercial mechanical permit amendment · Status: triage · Job value: $600,000 · Effective date: July 13, 2026 · Business: Mechanical Systems CO LLC (m00 · Address: 5420 TULANE RD · Description: Install process piping for closed chiller loop through above ground 18 pipes th”
  • building permit: Commercial electrical permit / Addition: issued
    “Permit number: COM-ELC-26-001808 · Type: Commercial electrical permit · Status: issued · Effective date: June 29, 2026 · Business: Gephart Electrical Constructio · Address: 5420 TULANE RD · Description: Mv feeders to transformers 480v feeders from transformers to tesla megapacks commercial”
  • building permit: Commercial mechanical permit / Install: withdrawn
    “Permit number: COM-MEC-25-001487 · Type: Commercial mechanical permit · Status: withdrawn · Job value: $614,030,295 · Effective date: June 25, 2026 · Business: Darana Hybrid INC (m000) · Address: 5420 TULANE RD · Description: Phase 1 2 and 3 - mechanical equipment for computer system”
  • building permit: Commercial electrical permit / Addition: withdrawn
    “Permit number: COM-ELC-26-001688 · Type: Commercial electrical permit · Status: withdrawn · Effective date: June 17, 2026 · Business: Gephart Electrical Constructio · Address: 5420 TULANE RD · Description: 1. Provide new raceway cable and terminations from existing switchgear to new mv tran”
  • building permit: Commercial electrical permit / Addition: issued
    “Permit number: COM-ELC-26-001711 · Type: Commercial electrical permit · Status: issued · Effective date: June 17, 2026 · Business: Gephart Electrical Constructio · Address: 5420 TULANE RD · Description: Mv feeders to transformers 480v feeders from transformers to tesla megapacks commercial”
  • building permit: Commercial accessory structure permit: triage
    “Permit number: COM-ACC-26-000050 · Type: Commercial accessory structure permit · Status: triage · Job value: $502,200 · Effective date: April 26, 2026 · Business: Omega Foundation Services (b00 · Address: 5420 TULANE RD · Description: Temporary tent at construction site”
  • building permit: Commercial accessory structure permit: triage
    “Permit number: COM-ACC-26-000051 · Type: Commercial accessory structure permit · Status: triage · Job value: $502,200 · Effective date: April 26, 2026 · Business: Omega Foundation Services (b00 · Address: 5420 TULANE RD · Description: Temporary construction office/storage”
  • building permit: Commercial accessory structure permit: triage
    “Permit number: COM-ACC-26-000052 · Type: Commercial accessory structure permit · Status: triage · Job value: $502,200 · Effective date: April 26, 2026 · Business: Omega Foundation Services (b00 · Address: 5420 TULANE RD · Description: Temporary tent for construction office/storage”
  • building permit: Commercial accessory structure permit: triage
    “Permit number: COM-ACC-26-000053 · Type: Commercial accessory structure permit · Status: triage · Job value: $502,200 · Effective date: April 26, 2026 · Business: Omega Foundation Services (b00 · Address: 5420 TULANE RD · Description: Temporary tent for construction office/storage”
  • building permit: Commercial plumbing permit / New: issued
    “Permit number: COM-PLM-26-000431 · Type: Commercial plumbing permit · Status: issued · Job value: $600,000 · Effective date: April 16, 2026 · Business: TRI State Plumbing Heating & A · Address: 5420 TULANE RD · Description: Providing plumbing water and sewer 5ft from building and finishing fixtures”
  • air, PSD determination: exemption determination
    “Four days later, on July 29, MDEQ claimed in a two-paragraph letter that xAI's turbines were exempt from permitting requirements”
  • air, PSD application: application submitted
    “On August 22, 2025, MZX submitted a permit application proposing a different turbine fleet (and pollution controls) for the site”
  • air, PSD application: application revised
    “then revised its application on January 14, 2026”
  • building permit: Commercial accessory structure permit: issued
    “Permit number: COM-ACC-26-000026 · Type: Commercial accessory structure permit · Status: issued · Job value: $1,000,000 · Effective date: April 14, 2026 · Business: Omega Foundation Services (b00 · Address: 5420 TULANE RD · Description: Steel bridge”
  • Air PSD construction permit: permit issued
    “Issued: March 11, 2026 — Permit No.: 0680-00119”
  • Air PSD construction permit: approved
    “approved an operations permit for 41 turbines at xAI's Southaven power plant”
  • Mississippi DEQ Permit Board (Jackson MS): PSD permit 0680-00119 for 41 turbines / 1.2 GW (MZX Tech LLC)
    “The Mississippi Environmental Quality Permit Board granted xAI's request to add 41 permanent gas turbines”
  • air, response to comments: response to comments issued
    “MDEQ Response to Comments MZX Tech LLC Complete Packet”
  • building permit: Commerical plumbing permit amendment / Addition: approved
    “Permit number: AMD-26-00204 · Type: Commerical plumbing permit amendment · Status: approved · Job value: $150,000 · Effective date: Feb. 26, 2026 · Business: Upchurch Services LLC (p000) · Address: 5420 TULANE RD · Description: Install 480 feet of trench drains”
  • building permit: Commercial alteration permit: issued
    “Permit number: COM-ALT-25-000345 · Type: Commercial alteration permit · Status: issued · Effective date: Feb. 9, 2026 · Business: Darana Hybrid INC (b000); Grin · Address: 5420 TULANE RD · Description: Phase one data center alterations”
  • building permit: Commercial plumbing permit / New: issued
    “Permit number: COM-PLM-26-000094 · Type: Commercial plumbing permit · Status: issued · Job value: $113,000 · Effective date: Feb. 2, 2026 · Business: Upchurch Services LLC (p000) · Address: 5420 TULANE RD · Description: Run sewer and water lines to cup 2 2a 3 3b install 480 feet of trench drains(amendment)”
  • Southaven Board of Aldermen: MZX Tech 'contribution' documents (Stateline Road project; police donation) - mayor authorized to sign MZX Tech's own versions
    “The board voted 7-0 to let the mayor sign MZX Tech's own versions of two contribution documents”
    grade B
  • building permit: Commercial plumbing permit / New: issued
    “Permit number: COM-PLM-26-000042 · Type: Commercial plumbing permit · Status: issued · Job value: $100,000 · Effective date: Jan. 13, 2026 · Business: Upchurch Services LLC (p000) · Address: 5420 TULANE RD · Description: Rough in for bathrooms. Run sewer and water lines”
  • building permit: Commercial plumbing permit / Alteration: withdrawn
    “Permit number: COM-PLM-25-001384 · Type: Commercial plumbing permit · Status: withdrawn · Job value: $15,000,000 · Effective date: Oct. 29, 2025 · Business: Darana Hybrid INC (p000) · Address: 5420 TULANE RD · Description: Phase 1 2 and 3 - plumbing”
  • building permit: Commercial accessory structure permit: issued
    “Permit number: COM-ACC-25-000087 · Type: Commercial accessory structure permit · Status: issued · Job value: $958,184 · Effective date: Oct. 20, 2025 · Business: Darana Hybrid INC (b000); Haye · Address: 5420 TULANE RD · Description: Exterior electrical room - building #1”
  • building permit: Commercial accessory structure permit: issued
    “Permit number: COM-ACC-25-000088 · Type: Commercial accessory structure permit · Status: issued · Job value: $958,184 · Effective date: Oct. 20, 2025 · Business: Darana Hybrid INC (b000); Haye · Address: 5420 TULANE RD · Description: Exterior electrical room - building #2”
  • building permit: Commercial accessory structure permit: issued
    “Permit number: COM-ACC-25-000089 · Type: Commercial accessory structure permit · Status: issued · Job value: $958,184 · Effective date: Oct. 20, 2025 · Business: Darana Hybrid INC (b000); Haye · Address: 5420 TULANE RD · Description: Exterior electrical room - building #3”
  • building permit: Commercial plumbing permit / Alteration: withdrawn
    “Permit number: COM-PLM-25-000558 · Type: Commercial plumbing permit · Status: withdrawn · Job value: $15,000,000 · Effective date: Oct. 20, 2025 · Business: Darana Hybrid INC (p000) · Address: 5420 TULANE RD · Description: All cooling related to super computer - phase I ii and III”
  • building permit: Commercial electrical permit / New: withdrawn
    “Permit number: COM-ELC-25-002583 · Type: Commercial electrical permit · Status: withdrawn · Effective date: July 31, 2025 · Business: Darana Hybrid INC (e000) · Address: 5420 TULANE RD · Description: Electrical permit for the entire building: 4 new medium voltage services for data center”
  • building permit: Commercial alteration permit: withdrawn
    “Permit number: COM-ALT-25-000360 · Type: Commercial alteration permit · Status: withdrawn · Job value: $300,000 · Effective date: April 23, 2025 · Business: Darana Hybrid; Darana Hybrid I · Address: 5420 TULANE RD · Description: Adding footing for interior structural support”
  • building permit: Commercial alteration permit: withdrawn
    “Permit number: COM-ALT-25-000335 · Type: Commercial alteration permit · Status: withdrawn · Job value: $5,100,000 · Effective date: April 16, 2025 · Business: Darana Hybrid INC (b000) · Address: 5420 TULANE RD · Description: Renovate office area and install new restrooms”
  • building permit: Commercial new construction permit: complete
    “Permit number: COM-NEW-22-000137 · Type: Commercial new construction permit · Status: complete · Effective date: Nov. 28, 2023 · Business: Arco Design/build INC (b000) · Address: 5420 TULANE RD · Description: Constructing an 1, 007, 838sf industrial warehouse that is constructed of concrete tilt”
  • building permit: Commercial plumbing permit / New: complete
    “Permit number: COM-PLM-22-001109 · Type: Commercial plumbing permit · Status: complete · Job value: $973,596 · Effective date: Nov. 22, 2023 · Business: Acuff Enterprises INC · Address: 5420 TULANE RD · Description: Installation of 8 & 6 private sewer system and private 12 10 8 6 & 4 water & fire exterior main”
  • building permit: Commercial plumbing permit / New: complete
    “Permit number: COM-PLM-22-001504 · Type: Commercial plumbing permit · Status: complete · Job value: $90,000 · Effective date: Nov. 16, 2023 · Business: TRI State Heating & Plumbing C · Address: 5420 TULANE RD · Description: New building fixtures only. Water and waste feeding building by others”
  • building permit: Commercial mechanical permit / Install: complete
    “Permit number: COM-MEC-23-000621 · Type: Commercial mechanical permit · Status: complete · Job value: $568,000 · Effective date: June 28, 2023 · Business: Mechanical Systems CO LLC (m00 · Address: 5420 TULANE RD · Description: Install (1) remote terminal unit (28) upblast prop fans (2) exhaust fans (56) moto”
  • federal rule: rule updated
    “all natural gas and combustion turbines, whether temporary or permanent, require permits”
  • enforcement, agreed order amendment: amended
    “According to an amendment to the agreement order, signed Sept. 11, 26 turbines will be removed this year”
  • MZX Tech's fourth bi-weekly deactivation report to MDEQ states no turbines were : Bi-weekly Turbine Removal Report #4 filed by MZX Tech (per Agreed Order para E)
    “The company says eleven were shut down in August.”
  • Agreed order amendment: amendment signed
    “According to an amendment to the agreement order, signed Sept. 11, 26 turbines will be removed this year”
  • Site plan approval date: Sept. 1, 2026
    “On Sept. 1, the Southaven Mayor and Board of Aldermen approved two development resolutions... design review approval”
  • Southaven Board of Aldermen: Planning Item #1 subdivision approval; Item #2 design review approval (storage warehouse) - MZX Tech LLC
    “Hoots was the lone alderman who voted against the design plans for the new data center proposal”
  • Memphis City Council taking steps toward a moratorium on new data center construction (reported alongside TVA vote); Olive Branch MS adopted data-center restrictions Aug 18 2026
    “the Memphis City Council has begun taking steps towards a moratorium that would temporarily ban new data center construction”
  • enforcement, agreed order: agreed order entered
    “establishing a fixed removal timeline for all 69 of the temporary, mobile turbines that currently power our facility in Southaven, Mississippi”
  • PSD permit appeal: appeal filed
    “files an appeal challenging MDEQ's decision to issue an air permit to xAI”
  • air, permit appeal: appealed
    “filed an appeal challenging the Mississippi Department of Environmental Quality's decision to issue an air permit to xAI's affiliate company, MZX Tech”
  • Air PSD permit (construction-commencement deadline): deadline to commence construction of the permanent plant
    “Final Permit 0680-00119 on March 11, 2026 (with a construction start deadline of September 11, 2027) (EIP Oil & Gas Watch, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Mississippi Environmental Quality Permit Board: Vote to issue PSD Permit No. 0680-00119 (41 permanent turbines, 1.2 GW)
    “MZX Tech plans to operate 41 gas turbines at the power plant located at 275 Stanton Road in Southaven”
  • 41 natural gas turbines, 1.2 GW, at the former Duke Energy power plant site in S: issued - construction permit approved by MDEQ Permit Board
    “the Mississippi Department of Environmental Quality's permit board unanimously approved a construction permit allowing xAI affiliate MZX Tech to install 41 methane gas-fired turbines at the Southaven plant”
  • building permit (Macrohard Office): permit issued for 1-story 42,900 sq ft "Macrohard Office" buildout
    “followed by a $15 million permit in March 2026 for the 1-story, 42,900 sq ft "Macrohard Office" buildout (Memphis Business Journal, Mar. 10, 2026) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Air PSD permit public hearing: public hearing
    “Hundreds of concerned residents pack an MDEQ hearing for xAI's permit application... nobody spoke in favor”
  • Mississippi DEQ (public hearing, Northwest Mississippi Community College): Public hearing on MDEQ PSD permit application for 41 turbines
    “Hundreds of concerned residents pack an MDEQ hearing... nobody spoke in favor of xAI's operations”
  • Mississippi Department of Environmental Quality (public hearing): Public hearing on MZX Tech PSD permit application for 41 gas turbines at 2875 Stanton Road
    “The Mississippi State Conference of the NAACP and the national NAACP sent an open letter to MDEQ to immediately reschedule the public hearing”
  • Air PSD permit technical review: technical review issued
    “MDEQ issued Technical Review on January 16, 2026 and Final Permit 0680-00119 on March 11, 2026 (EIP Oil & Gas Watch, Wikipedia) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • EPA January 2026 Federal Register update: all gas/combustion turbines, temporary or permanent, require Clean Air Act permits - closes the nonroad-engine theory used at both Memphis-area sites
    “the U.S. EPA updated its Federal Register citing that all natural gas and combustion turbines, whether temporary or permanent, require permits”
  • Air PSD permit application: application filed
    “xAI applies for an air permit that would allow the company to operate a staggering 41 turbines at its Southaven site”
  • Southaven Board of Aldermen: MOU for xAI to fully fund State Line Road widening/resurfacing ($3.46M)
    “the board approved an MOU for XAI to fully fund $3,460,000 in State Line Road widening/resurfacing”
  • Air permit appeal (SCHD permit): appeal dismissed
    “On Dec. 15, the Memphis and Shelby County Air Pollution Board voted to dismiss an appeal for the air permit”
  • building permits (5420 Tulane Rd): Darana listed as applicant on office-renovation and electrical-room permits; >$600M total permitted spend by Oct 2025
    “Darana Hybrid Inc. was listed as the applicant on the initial April 2025 office renovation building permit and electrical room permits at 5420 Tulane Road, where total permitted construction spend exceeded $600 million by October 2025 [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Air PSD permit application: application filed by MZX Tech LLC
    “"MZX Tech LLC (MZX) is proposing to construct and operate a new greenfield major source ... that will provide electricity to its data center located in Shelby County, Tennessee." (512 Pixels, EIP) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Temporary turbine exemption: exemption approved
    “In August 2025, MDEQ approved an exemption for the use of 18 unpermitted turbines at the site”
  • Air operations permit: approved (sibling Colossus 1 site
    “On July 2, the Shelby County Health Department approved an operations permit for 15 gas turbines at the Colossus site”
Legal (22)
  • NAACP v. X.AI, U.S. Court of Appeals for the Fifth Circuit, No. 26-60806, filed Sept. 24, 2026 (CourtListener docket 74861066)
    “NAACP v. X.AI, docket 26-60806, Court of Appeals for the Fifth Circuit”
  • Carter v. X.AI Corp., W.D. Tenn. No. 2:26-cv-03257, filed Sept. 23, 2026 (docket 74841662)
    “Carter v. X.AI Corp., 2:26-cv-03257, W.D. Tennessee”
  • Carter v. X.AI Corp. (W.D. Tenn. 2:26-cv-03257): class action alleging round-the-clock noise from the Southaven turbine plant and the Memphis/Southaven data centers
    “Plaintiffs Robert Carter and Sabrina Anderson ("Plaintiffs"), on behalf of themselves and all others similarly situated, bring this class action complaint”
  • United States appeals to the Fifth Circuit after the court did not rule on its motion to intervene and dismiss the NAACP Clean Air Act suit (notice of appeal ECF 123)
    “With still no ruling on the United States amended motion filed months ago, and the passing of September 10, this Court has constructively denied the United States motion to intervene and dismiss”
  • Preliminary-injunction evidentiary hearing set for Aug. 24, 2026 continued until further notice (ECF 112)
    “Evidentiary Motion Hearing set for 8/24/2026 continued until further notice”
  • Darana Hybrid, Inc v. CTC Property LLC, W.D. Tenn. No. 2:26-cv-03037, filed Aug. 11, 2026 (docket 74220325)
    “Darana Hybrid, Inc v. CTC Property LLC, 2:26-cv-03037, W.D. Tennessee”
  • x.AI LLC v. Darana Hybrid, Inc., W.D. Tenn. No. 2:26-cv-02994, filed Aug. 4, 2026 (docket 73720190); commercial dispute, not environmental
    “x.AI LLC v. Darana Hybrid, Inc, 2:26-cv-02994, W.D. Tennessee”
  • Underlying suit: National Association for the Advancement of Colored People v. X.AI Corp., N.D. Miss. No. 3:26-cv-00074, filed April 14, 2026 (docket 73188848)
    “National Association for the Advancement of Colored People v. X.AI Corp., 3:26-cv-00074, N.D. Mississippi”
  • x.AI/CTC/MZX v. Darana (W.D. Tenn. 2:26-cv-02994, lead): complaint Aug. 4, 2026; consolidated with 2:26-cv-03037 on Sept. 4, 2026 (Doc. 36; 03037 administratively closed, not dismissed); amended complaint Sept. 17, 2026 (Doc. 39)
    “August 4, 2026: initial complaint, Doc. 1 ... September 4: consolidation with 2:26-cv-03037, Doc. 36 ... September 17: amended complaint, Doc. 39 ... Latest indexed date: October 16, 2026”
  • Carter and Anderson v. X.AI Corp. and MZX Tech LLC, W.D. Tenn. No. 2:26-cv-03257-BCL-cgc - Tennessee residents' noise/air class action (filed Sep 22 per Commercial Appeal; complaint stamp Sep 23)
    “Case 2:26-cv-03257-BCL-cgc Document 1 Filed 09/23/26”
  • United States moves to stay all proceedings pending appeal, citing a Department of War declaration on national security
    “this citizen suit poses grave national security threats because an injunction would significantly harm the Department of War battlefield capabilities”
  • DOJ moves to intervene and dismiss the NAACP citizen suit (Article II theory; national-security claim); xAI files motion to dismiss the same day
    “Case: 3:26-cv-00074-DMB-JMV Doc #: 54 Filed: 06/15/26”
  • NAACP v. X.AI Corp. and MZX Tech LLC, N.D. Miss. No. 3:26-cv-00074-DMB-JMV - Clean Air Act citizen suit over 27 unpermitted turbines
    “installed and began operating twenty-seven polluting gas turbines... in Southaven, Mississippi... without an air permit”
  • NAACP and Mississippi State Conference of the NAACP sued xAI Corp. and MZX Tech LLC in the Northern District of Mississippi (3:26-cv-00074) alleging Clean Air Act violations at the Stanton Road plant; a preliminary-injun
    “Defendants constructed the Colossus Gas Plant without any permits and operate it without necessary pollution controls”
  • NAACP + NAACP Mississippi State Conference 60-day notice of intent to sue X.AI Corp. and MZX Tech LLC (Clean Air Act, Southaven turbines)
    “intend to file suit against MZX Tech LLC and X.AI Corp. for their past and ongoing violations of the federal Clean Air Act”
  • Setting letter (Doc. 48, Oct. 8, 2026): pretrial conference March 2, 2028; 10-day jury trial March 20, 2028 before Judge Brian C. Lea
    “October 8, 2026 (Doc. 48, Setting Letter setting Pretrial Conference for March 2, 2028 ... 10-day Jury Trial for March 20, 2028) (PacerMonitor docket, per dossier) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Darana DeSoto County (MS) suit for $432,455,431.16 covers 2400 Stateline Rd W among four MS sites (alleged verbal agreement outside the CTC MSA); Darana work through June 23, 2026
    “Included in $432,455,431.16 Mississippi suit (Doc. 42-2) ... work through June 23, 2026 (Powerboat News, LocalMemphis) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Darana sued MZX in DeSoto County (MS) Circuit Court for $432,455,431.16 for work at four MS sites (2875 Stanton Rd, 2400 Stateline Rd W, 3883 US-51, Nail Rd Olive Branch) under an alleged verbal agreement outside the CTC
    “Darana Hybrid files a separate complaint in the Circuit Court of DeSoto County, Mississippi ... seeking $432,455,431.16 ... for unpaid electrical and mechanical work across four Mississippi sites (Powerboat News, LocalMemphis) [from the user-supplied dossier on x.AI v; Darana (press-derived: Powerboat News, LocalMemphis, Datacentres.com, Wikipedia et al.)”
    grade C
  • Resident class action (Haley, Herrington, Logsdon et al.) filed against SpaceXAI over noise and pollution; in fall 2026 MZX Tech's counsel offered to buy residents' property in exchange for releases of class-action claim
    “offering to buy property in exchange for releasing any claims in the ongoing class action lawsuit filed by Haley, Preston Herrington, Taylor Logsdon and other residents”
  • Haley, Herrington, Logsdon et al. v. X.AI Corp. et al., N.D. Miss. - noise/vibration nuisance class action (10,000+ putative class members); filed ~3 months before Sep 25 2026 buyout reporting
    “filed a class action lawsuit against X.AI Corp. and MZX Tech LLC in the United States District Court for the Northern District of Mississippi”
  • DOJ files notice of appeal of constructive denial of its intervention motion; docketed in 5th Cir. as NAACP v; timeline recorded here)
    “DOJ filed a Notice of Appeal on September 18th to the United States Court of Appeals for the Fifth Circuit... Case No. 3:26-cv-00074-DMB-JMV”
  • Opposition: Safe and Sound Coalition; NAACP and Mississippi State Conference of the NAACP; Young Gifted & Green; SELC; Earthjustice
    “on behalf of the NAACP, Young Gifted & Green, and the Safe and Sound Coalition, filed an appeal challenging the Mississippi Department of Environmental Quality's decision”
Site and other (25)
  • County code: DeSoto County, MS (28033)
    “MZX Tech LLC 2875 Stanton Road Southaven, Desoto, Mississippi”
  • Building height ft: 40 ft
    “site plan approval for a 40-foot-high, single-story data storage warehouse”
    grade A
  • Acres site plan: 55.89 acres
    “The property consists of 2 parcels which total to 55.89 acres of property”
    grade A
  • Parking spaces: 45
    “Total spaces: 45... No. of spaces: 1.5 per employee”
    grade A
  • Cooling: dry coolers plus water tanks
    “an area along Tulane Road for dry coolers and water tanks associated with on-site conditioning”
    grade A
  • Code names: Project Stateline (Macrohardrr) - Darana correspondence
    “"Project Colossus, Project Tulane (Macrohard), Project Stateline (Macrohardrr), Duke" (02994 Doc. 44-5 p. 2, authenticated by Doc. 44-2 ¶5)”
  • Address: 5420, 5414 & 5408 Tulane Rd., Memphis, TN 38109 (Amendment 1 site description)
    “Amendment 1: 5420, 5414 & 5408 Tulane Rd., Memphis, TN 38109 (03037 Doc. 1-1, p. 35) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Xai greenhouse memphis southaven postings: 172
    “172 of 304 postings location-tagged Memphis, TN / Southaven, MS”
  • Address: 2400 Stateline Road West, Southaven, MS (complaint-reported)
    “Stateline/"Macrohardrr" at 2400 Stateline Road West, Southaven (Doc. 39 ¶74, p. 22); complaint-reported, not parcel verification”
  • Acres adjacent mzx: 101.44 acres
    “The plat shows the adjacent 'MZX TECH LLC 101.44 ACRES'”
    grade B
  • Owner companies: MZX Tech LLC holds 5420 Tulane Rd (Macrohard site), conveyed by CTC Property LLC on or about June 27, 2025; chain x.AI LLC -> CTC Property LLC (sole member) -> MZX Tech LLC (sole member CTC); both Wyoming L
    “CTC/MZX state CTC's sole member is x.AI LLC; MZX's sole member is CTC; They admit CTC conveyed 5420 Tulane Road to MZX on or about June 27, 2025, and that the property is the Macrohard site (Doc. 23 ¶¶2-3, 9) [from the user's research notes on Darana v; CTC / x.AI v; Darana (combined), W.D; Tenn. 2:26-cv-03037 consolidated into 2:26-cv-02994”
  • Address southaven plant: 2875 Stanton Road S Southaven MS
    “MZX Tech LLC, 2875 Stanton Road, Southaven, Desoto, Mississippi”
  • Developer: xAI Corp
    “xAI has purchased and is retrofitting a building to house the new data center operations”
  • Original target date: Feb. 2026
    “The company expects to begin data center operations in Southaven in February 2026”
  • Land control date: July 16, 2025
    “Special Warranty Deed from Julie M James to MZX Tech LLC (dated July 16, 2025) (recorded July 18, 2025)”
  • Address: 2400 Stateline Road W, Southaven, MS
    “He said the Macrohadrr data center, located at 2400 Stateline Road, will be operational in 2027”
  • Construction stage: shell, retrofit of existing warehouse under way; permanent plant under construction
    “Musselwhite described the development as fluid and dynamic and acknowledged it will continue moving at unprecedented speed”
  • Current target date: 2027
    “will be operational in 2027 and is projected to go onto the Southaven and DeSoto County tax roll in early 2028”
  • Noise complaints from the Colonial Hills neighborhood began Aug 2025; Mayor Musselwhite said in Nov 2025 the noise was temporary and would end within days; complaints continued through 2026
    “In November 2025, Southaven Mayor Darren Musselwhite claimed the noise was temporary and would go away within days”
  • Code names: Macrohard (5420 Tulane Rd, Memphis); Macrohardrr (2400 Stateline Rd, Southaven); Minihard (5414 Tulane Rd, Memphis)
    “Colossus 2 | 5420 Tulane Road; Macrohardrr | 2400 Stateline Road; Minihard | 5414 Tulane Road”
  • Construction stage: operating (first cluster online Jan 2026; expanding; permanent plant pre-construction toward Jul 2027)
    “Colossus 2 | 5420 Tulane Road, Memphis | Operational... Marcrohardrr | Under construction; Minihard | Under construction”
  • Rep. Frank Pallone Jr. (ranking member, House Energy & Commerce) letter to Musk demanding records and site tour by Aug 11 2026
    “sent a formal letter to Elon Musk demanding comprehensive documentation... compliance deadline of Tuesday, 11 August 2026”
  • Building sq ft: 810225 sq ft
    “The site is a former GXO Logistics warehouse built in 2001, retrofitted to host data center operations”
  • SpaceX acquired xAI (Feb 2, 2026); the AI segment in SpaceX's S-1 was created by the acquisition; xAI later rebranded SpaceXAI (Jul 6, 2026)
    “The AI segment was created by the February 2, 2026, acquisition of xAI”
  • Safe and Sound Coalition petition to shut down xAI's area operations passed 900 signatures by announcement day (AP)
    “A petition by the Safe and Sound Coalition, a Southaven group opposing xAI's developments, calls for shutting down xAI's operations in the area”

Imagery and records: Satellite imagery: Maxar via Esri World Imagery Wayback; Sentinel-2 (ESA Copernicus). County deeds and building permits: ATTOM.
