Data center profile · Abilene, Tex. (Taylor County)

Stargate Abilene

Crusoe's campus on Lancium land in West Texas, the first Stargate site: eight buildings for Oracle and OpenAI on a 1.2 GW grid connection

Partly operating. First two buildings live since Sept. 2025; an outside tracker counts four operating, and we estimate about 421 MW of IT live. More halls and the on-site gas plant are still being built; Oracle and OpenAI reportedly dropped the expansion.
The data halls, Satellite image, Nov. 21, 2025
1.2 GW
grid connection the landowner cites
company statement, 2025
360 MW
on-site gas turbines in the state air permit filing
10 units after a Jan. 2025 permit change; on-site use only
$2.5B
loan hedge on the first two buildings
swap on the Phase 1 construction loan, as of Apr. 9, 2026 (SEC filing)
10
data-center phases in the city tax deals
plus a separate gas plant
OperatorCrusoe (builds and runs it) on Lancium land
CustomerOracle Cloud, for OpenAI (buildings 1-8); Meta reported in talks about the expansion buildings
Planned IT capacity960 MW at full build-out (our estimate from the company or utility power figure)
First building in serviceIn service since Sept. 2025 (about 421 MW of IT capacity live, estimated)
Next deadlineJune 2028: Finish both, $350M invested in each
The site

Eight buildings, a gas plant and a new substation on former rangeland

The whole campus on Nov. 21, 2025. Eight data-hall buildings sit in two blocks: a pair at the north end and a row of six to the south. The campus's own gas plant and battery yard line the east edge, and a new 345 kV substation sits in the gap between the two blocks.

Satellite overview123
Satellite image, Nov. 21, 2025. Pins placed from site coordinates.
  1. 1Data halls
    32 halls in eight buildings: two in the north block, six in the south row
  2. 2On-site gas plant
    east of the north block, with a battery yard on its north side
  3. 3New 345 kV substation
    between the two blocks, beside an older 138 kV yard
From orbit

32 data halls where there was scrub in May 2024

On May 17, 2024 this was open rangeland cut by ranch roads, with a small electrical yard and a few oil-field pads. By Nov. 21, 2025 eight buildings of four halls each had their roofs on, ringed by cooling equipment and parking lots. Drag to compare.

after
before
◀ Satellite image, May 17, 2024Satellite image, Nov. 21, 2025 ▶
From orbit

Eight gas turbines being set in the campus's own power plant

In May 2024 this corner was empty rangeland. By Nov. 21, 2025 a fenced plant yard held about eight gas turbines on concrete pads, several with exhaust stacks up and two cranes still lifting, next to a block of white containers. Drag to compare.

after
before
◀ Satellite image, May 17, 2024Satellite image, Nov. 21, 2025 ▶
From orbit

A new 345 kV substation rises beside the old 138 kV yard

In May 2024 only the small 138 kV yard stood here, next to brushland. By Nov. 21, 2025 a much larger 345 kV yard was half built beside it: steel and bus work up, transformers being set, and four cable runs heading south to the halls. Drag to compare.

after
before
◀ Satellite image, May 17, 2024Satellite image, Nov. 21, 2025 ▶
Quarter by quarter

Two years from rangeland to 36 roof planes

Ground first broke in summer 2024: the July 2, 2024 frame shows the northeast pad stripped and haul roads cut. By Oct. 8, 2026 the campus holds eight hall structures with 36 roof planes plus support buildings, and work is still going on at the edges.

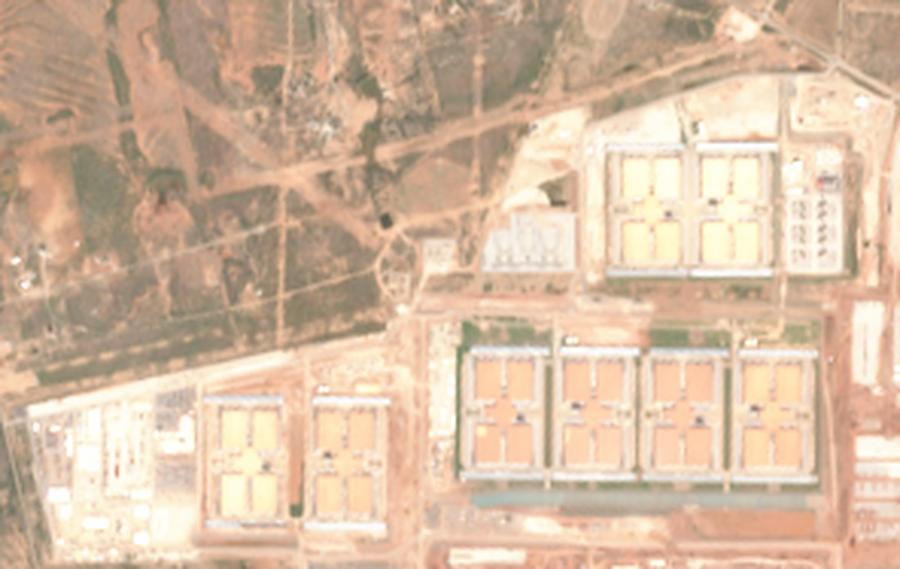

Satellite view of the campus, Oct. 8, 2026

Sentinel-2 satellite, 10 m resolution (coarser than the photos above).
Construction from orbit

What the satellites see on the ground

From orbit, ground clearing shows from July 2024, and radar echoes from walls and steel start climbing in Oct. 2024. About 80 acres read as roof by Oct. 2026, half of that by Feb. 2026. That fits our stage: partly in service.

Construction from orbit, as a share of the site: bare ground (left scale); roof and very bright radar echoes (right scale)
05101520%0255075100%2023Jul2024Jul2025Jul2026Jul▲ Permits▲ Site work▲ Vertical▲ Power onRadar: bright echoesBare groundRoof
05101520%0255075100%2023202420252026▲ Permits▲ Site work▲ Vertical▲ Power onRadar: bright echoesBare groundRoof
Roof: the highest 5-month median so far (roofs do not come down), dots are single months; bare ground: 3-month median; radar: 2-month median. Contains modified Copernicus Sentinel data 2023–2026.

How this works: Sentinel-2 photographs the ground every few days at 10 m. For each month we keep the cloud-free views over the campus outline (about 830 acres) and count the share that reads as bare ground and the share that reads as roof (very bright, not vegetated). Sentinel-1 radar sees through cloud every 6–12 days; walls and steel bounce the signal straight back, so the share of very bright radar echoes rises as buildings go up. Bright gravel pads and fresh concrete can read as roof, and wet or snowy months dip, so we read the trend, not single months. Black ticks mark our stage dates. Data: Copernicus Sentinel-1 and Sentinel-2, via the Copernicus Data Space Ecosystem.

Power

Power and the grid

Energized, size not disclosed · contracted, size not disclosed · 360 MW permitted

On-site gas turbines (5 Titan 350 + 5 LM2500)Permitted, being built (Unit 1 listed operating)
360 MW
5 x 38 MW + 5 x 34.1 MW per the Jan. 2025 permit change; still under development at end of 2025 State agency · Jan. 2025
Permitted
Other sources, size not disclosed

Stated capacity over time

2025
1.2 GW
grid connection for the campus (company)
Jan. 11, 2025
360 MW
on-site gas turbines on state permit (filing)
Oct. 2026
~1.0 GW
IT capacity at full build, our estimate: about 960 MW for buildings 1-8 (the 1.2 GW grid connection)
July 2026
~590 MW
power running now (outside tracker estimate, July 2026)

Getting on the grid

Who supplies what, what it costs, and what is still not public.

  1. Jan. 11, 2025
    Permit change filed to run turbines all year
    A permit change application sets 10 gas turbines at the site and raises their hours from 5,880 to 8,760 a year: full time, not just backup. see Permits
  2. March 18, 2025
    Landowner says ERCOT approved 1.2 GW
    Lancium says ERCOT fully approved a 1,200 MW grid interconnection, with batteries and solar planned behind the meter; the transmission provider is not named (company). see Permits
  3. Sept. 2025
    First two buildings in service
    Phase 1 goes live serving Oracle and OpenAI. News report · Sept. 2025
  4. 2025
    Power station still not finished
    Audited accounts: both buildings were handed to the tenant in 2025, but the on-site power station was still under development. SEC filing · Dec. 2025
  5. Not set
    Utility and rate: not public
    Trackers disagree on the utility (Coleman County Electric Cooperative or AEP). No public service agreement or regulator docket was found. Dataset · Oct. 2026

Grid upgrades

What the grid is building for this load: the asset, its cost, who pays and when it is due to be energized. An upgrade may serve a later phase, not the first building.

On-site generation on file

What is next door

campus0.12 km · 345 kV substation0.15 km · 138 kV line0.26 km · 345 kV linecampus0.12 km · 345 kV substation0.15 km · 138 kV line0.26 km · 345 kV line

Only one line of 230 kV or more runs within 2 km. No gas pipeline is mapped within 15 km, likely an unmapped in-state line. Distances from mapped lines and plants. OpenStreetMap · Oct. 2026

Is it running?

Evidence from space

NO2 over the site, net of the rural background, was about the same in July–September 2026 (6 µmol/m²) as a year earlier (6), and the rural background stayed flat (18 and 17). The satellite sees no new combustion large enough to stand out here. On record here: On-site gas turbines (5 Titan 350 + 5 LM2500), 360 MW, permitted. No rise fits a plant that is not running yet, or runs little; it does not prove either.

See all campuses checked →

NO2 over the campus and over open country (µmol/m²)
0204060Jan 2025AprJulOctJan 2026AprJulOctOver the campusOpen country
0204060Jan 2025JulJan 2026JulOver the campusOpen country
Lines: 7-day (daily) / 3-week (weekly) averages; gaps from cloud filled by straight-line interpolation; dots are raw readings. Shaded: July–September 2025 and 2026, averaging 6 and 6 µmol/m² above open country (1.0×).

What else could explain it

How this works: the Sentinel-5P satellite measures NO2 in the air over every point on Earth once a day, around 1:30 p.m. local time, in pixels about 5.5 by 3.5 km. NO2 comes from burning fuel (turbines, engines, traffic, power plants), so a rise over a site that open country does not share points to new combustion there. It shows combustion activity, not megawatts. The site box is about 15 km across; the background box is open country about 57 km away. We use only high-quality readings and drop days or weeks when cloud hides more than half of either box. Data: Copernicus Sentinel-5P (ESA), processed with the Copernicus Data Space Ecosystem Sentinel Hub statistics service.

Permits

Permits checklist

1 claimed by owner · 3 granted

Risks

What could slow it down

Also on record
Money

Money on record

85%
city property-tax break, first two buildings
10 years; 75% for later phases and the gas plant
$350M
minimum investment per phase
target $500M; full clawback if missed
$2.5B
construction-loan hedge, first two buildings
fixed at 3.98%, runs to Jan. 9, 2028 SEC filing · April 2026
$147M
interest and loan costs capitalized in 2025
audited accounts of the first phase SEC filing · Dec. 2025
$15B
Blue Owl and Primary Digital venture
press; other reports say $11.6B
~$200M
2025 county appraisal Oracle protested
about $3M of county revenue at stake News report · July 2025
Land assembly

36 recorded land documents for the campus company in county records (Aug. 2024 to Nov. 2025); none lists a price. 21 related-party transfers are shown greyed. Parcel counts come from the deed; acreage is not recorded.

Timeline

What happened, and what is due

SitePaper trailConstructionPowerPermitsMoneyLegalUpcoming
  1. Dec. 21, 2021
    Money Abilene signs its first tax break with Lancium
  2. Feb. 18, 2022
    Paper trail Lancium Abilene Real Estate LLC registered in Delaware and Texas
  3. May 28, 2024
    Paper trail Abilene DC 1 LLC registered in Delaware and Texas
  4. June 1, 2024
    Construction Building 1 construction starts ($292M) State agency · June 2024
  5. July 15, 2024
    Paper trail Lancium Abilene LLC registered in Delaware and Texas
  6. Aug. 27, 2024
    Money Land purchase, price not recorded: Rolling Plains EV Stations LLC to Lancium Abilene LLC, recorded Aug. 2024 (county deed records) County deed records · Aug. 2024
  7. Oct. 11, 2024
    Money Hyperscale tenant leases 100% of the first phase SEC filing · Oct. 2024
  8. Jan. 11, 2025
    Power Permit change: 10 on-site turbines, run all year State agency · Jan. 2025
  9. Jan. 21, 2025
    Site Stargate announced at the White House; Abilene is site one News report · Jan. 2025
  10. March 21, 2025
    Money Land transfer, price not recorded: Lancium Abilene LLC to Abilene DC 4 LLC, recorded March 2025 (county deed records) County deed records · March 2025
  11. March 24, 2025
    Construction Building 2 fit-out begins ($384M) State agency · March 2025
  12. July 18, 2025
    Money Oracle protests the ~$200M county appraisal News report · July 2025
  13. Sept. 5, 2025
    Money City splits the tax deal into one per phase
  14. Sept. 2025
    Construction First two buildings go live for Oracle and OpenAI News report · Sept. 2025
  15. March 13, 2026
    Money Audit: buildings delivered, power station unfinished SEC filing · March 2026
  16. Sept. 2, 2026
    Site Residents protest at an Abilene panel on the AI boom News report · Sept. 2026
  17. Oct. 2026
    Money Oracle and OpenAI reported to drop the expansion; Meta in talks
  18. End of 2026
    Money Deadline: 57 full-time jobs for the first tax deal
  19. Jan. 9, 2028
    Money Construction-loan hedge matures SEC filing · March 2026
  20. June 2028
    Power Deadline: finish both, $350M invested in each
Construction activity

Building activity by quarter

Since Feb. 2022: 1 FAA filing (Aug. 2026): a antenna tower 175 ft; 4 OSHA inspections; and 76 satellite captures.

FAA filings
OSHA visits
Satellite
’22
’23
’24
’25
’26
Dot size: records in the quarter, largest = 6. Two-digit years mark each first quarter.
The buildings

Specs

482,000 sq ft
Building 1 data hall, $292M estimated cost
484,960 sq ft
Building 2, four data halls, $384M fit-out
~837 acres
mapped campus outline
~941 acres
city tax zone around the site
8 roofed
buildings on satellite, 1 more under way; 4 cranes
Who is involved

Owners, partners and builders

Owners
  • Lancium: landowner and developer, leases each phase's parcel
  • Abilene DC 1 to 10 LLCs (Delaware): one leasing company per phase
  • Abilene DC TPP LLC: the on-site gas plant
  • Blue Owl Real Estate Capital: financing, with Primary Digital Infrastructure
Decision-makers
  • Matthew DeNezza: president, Abilene DC 1 (Crusoe)
  • Jamey Seely: general counsel, Abilene DC 1 (Crusoe)
  • City of Abilene: grants the tax breaks
  • Gary Earnest: Taylor County chief appraiser
Power partners
  • ERCOT: Texas grid operator
  • Coleman County Electric Cooperative or AEP: utility, disputed
  • Titan 350 and GE LM2500 gas turbines on site
Builders
  • Crusoe: designs, builds and runs the campus
Customer
  • Oracle Cloud Infrastructure: tenant of the live buildings
  • OpenAI: end user, through Stargate
  • Meta: reported in talks for more space (Oct. 2026)
Builders on site
  • Nixon Engineering: contractor on site per OSHA inspection 345971287
  • DPR Construction Inc.: contractor on site per OSHA inspection 348294620
  • Ruiz-boyter Construction & Supplies: contractor on site per OSHA inspection 348423609
  • Osha Complaint inspection of Nixon Engineering: 1 OSHA inspection
  • Osha Referral inspection of DPR Construction Inc.: 1 OSHA inspection
  • Osha Referral inspection of Ruiz-boyter Construction & Supplies: 1 OSHA inspection
  • and 1 more contractors in the permit and inspection records
Still unknown

Open questions

Where this comes from

440 records from 40 documents

Drawn from public and commercial datasets, state agency records, company statements, business registries, news reports, satellite captures and securities filings, each kept with its date and source. The bar shows documents by type.

Dataset 16State agency 13Company 8News report 6Satellite 4SEC filing 1
Evidence

Every quote behind this page

Grade key: A = the primary record itself (permit, filing, exhibit) · B = a dated official statement · C = news reporting. Map distances are our own measurements on OpenStreetMap and carry no grade. Allegations in lawsuits are marked as such in the quotes.

Power (28)
  • EIA campd registration: not stated
    “monitors the current status of existing and proposed generating units at electric power plants with 1 megawatt or greater of combined nameplate capacity”
  • Grid upgrade due to be energized by: Dec. 31, 2028
    “Mulberry Creek: Expand 345 kV Station. Interconnect the Lancium load to the Mulberry Creek 345 kV station.”
  • Blue Owl Real Estate Net Lease Trust 10-K (filed March 13, 2026), Exhibit 99.3 = audited financial statements of Abilene DC 1, LLC: both buildings substantially completed and delivered to the tenant during 2025; power statio
    “During the year ended December 31, 2025, the buildings were substantially completed and delivered to the tenant.”
  • Blue Owl Real Estate Net Lease Trust 10-K filed incl. Exhibit 99.3 audited statements of Abilene DC 1, LLC (buildings delivered 2025; power station still under development at Dec. 31, 2025)
    “Buildings substantially completed and delivered to the tenant during 2025; the power station remained under development at 2025-12-31”
  • Owner companies: Abilene DC 1, 3, 4, 5, 6, 7, 8, 10, LLC (phase lessees; DC 9 in City series; DC 2 not sighted) + Abilene DC TPP, LLC
    “separate agreements with Abilene DC 1, LLC through Abilene DC 10, LLC, plus Abilene DC TPP, LLC (Electricity Generation Plant)”
    grade A
  • Phases: 10 contractual data-center phases + 1 on-site generation plant (TPP)
    “The contracts carry 10 data-center phases and a separately abated gas turbine-powered electricity generation plant”
    grade A
  • On-site power technology: On-site gas-turbine electricity generation plant (TPP) under separate City abatement, Abilene DC TPP, LLC; construction window Feb. 28, 2028 to June 30, 2028
    “Facility means (1) a gas turbine-powered electricity generation plant”
    grade A
  • Power station status: under development
    “As of December 31, 2025, the power station remains under development.”
  • Current target date: Phase 1 live Sep 2025; buildings delivered to tenant during 2025 (audited); Phase 2 buildings completing through 2026
    “Buildings substantially completed and delivered to the tenant during 2025; the power station remained under development at 2025-12-31”
  • Announced: Dec. 21, 2021
    “Taylor County and the City of Abilene have approved a project with Lancium, a Houston-based energy technology and infrastructure company, to build a large scale, renewable energy powered data center campus in Abilene and Taylor County.”
  • Plant role company statement: Backup power for the data halls (company statement); primary supply is the 1,200 MW ERCOT grid interconnect
    “Ultimately, this plant will be used for backup power for the data halls, rather than traditional, higher-emission diesel generators”
  • Utility service: 1,200 MW
    “Our Abilene campus features a 1.2GW interconnect, which has been fully approved by ERCOT and undergone a rigorous, formal review process in collaboration with transmission service providers.”
  • Interconnection status: ERCOT: 1,200 MW interconnect approved; campus energized (first buildings operating in 2025) and expanding to the full interconnect
    “Our Abilene campus features a 1.2GW interconnect, which has been fully approved by ERCOT and undergone a rigorous, formal review process in collaboration with transmission service providers.”
  • Nearest power line: 138 kV at 0.15 km
    Measured on OpenStreetMap map data.
  • Nearest 345 kV line: 0.26 km
    Measured on OpenStreetMap map data.
  • Power lines of 230 kV or more within 2 km: 1
    Measured on OpenStreetMap map data.
  • Nearest substation: unnamed, tagged 345 kV, at 0.12 km
    Measured on OpenStreetMap map data.
  • Gas pipelines within 15 km: 0
    Measured on OpenStreetMap map data.
  • Power plan: hybrid (ERCOT grid + on-site gas plant contracted for 2028; plant described by Lancium as backup/bridge in press)
    “hybrid evidenced by 1.2 GW grid interconnection statement plus separate TPP abatement with 2028 deadlines”
    grade B
  • Generating units on the permit: Unit 1 (operating): gas turbine group, 360.512 MW, Solar Turbines Titan 350 and GE Vernova LM2500; Unit 2 (pre-construction): 139 MW, GE Vernova LM2500
    “Longhorn Data Center power station is an operating power station of at least 360-megawatts (MW) in Abilene, Taylor, Texas, United States with multiple units”
  • On-site generation: 360.512 MW
    “Longhorn Data Center power station is an operating power station of at least 360-megawatts (MW) in Abilene, Taylor, Texas, United States with multiple units, some of which are not currently operating.”
  • Epoch carries a SEPARATE 'Crusoe Abilene Expansion'
    “A separate row, 'Crusoe Abilene Expansion' (Microsoft #confident): land clearing Nov 2, 2025, 2 buildings, 672 MW IT / 941 MW by Nov 2027”
    grade B
  • large load interconnection request: grid interconnection approved by ERCOT (1,200 MW)
    “In addition to the 1.2 GW grid interconnection, Lancium's power plan for the site includes large-scale behind-the-meter battery storage and solar resources”
  • Stated campus size: 1,200 MW
    “In addition to the 1.2 GW grid interconnection, Lancium's power plan for the site includes large-scale behind-the-meter battery storage and solar”
    Company · 2025 · grade B
  • Plant status tracker: Operating (GEM Unit 1, 360.5 MW); Units 2-3 pre-construction
    “Longhorn Data Center power station is an operating power station of at least 360-megawatts (MW) in Abilene, Taylor, Texas”
  • Utility: CONTESTED, Coleman County Electric Cooperative (interconnection.fyi) vs AEP (Epoch)
    “grid operator Coleman County Elec Coop”
  • Interconnection status: Energized/operating for Phase 1 (live Sep 2025); no ESA or PUCT docket found for this campus; ERCOT large-load interconnection is not docketed at the PUCT
    “none found (no public ESA; Oracle 15-year compute agreement reported, terms undisclosed)”
    grade C
  • Generating units on the permit: Diesel emergency generation: 62 diesel generators under the initial TCEQ minor-source approvals (Floodlight / Community Sentinel review of TCEQ records); GEM unit table separately lists a
    “Its initial approvals covered 10 gas turbines and 62 diesel generators.”
Money and contracts (100)
  • Swap final notional: 2498000000 USD
    “the final notional amount being $2,498,000,000 as of April 9, 2026”
  • tax abatement (TX Ch. 312): valuation no protest 200000000 USD
    “the collective Taxable Value proposed by the Appraisal District for such Facility for any tax year in the Eligibility Period be less than Two Hundred Million and No/100 Dollars ($200,000,000.00), Lessee shall not protest such proposed Taxable Value”
    grade A
  • Buildings delivered to tenant: 2025
    “During the year ended December 31, 2025, the buildings were substantially completed and delivered to the tenant.”
  • Swap notional: 2261773483 USD
    “The notional amount of the swap equaled $2,261,773,483 and $459,603,884 as of December 31, 2025 and 2024, respectively.”
  • Swap strike rate: 3.980 percent
    “floating-to-fixed interest rate swap on the SOFR-based floating portion of its construction loan payable with a strike rate of 3.980%”
  • Capitalized interest and loan costs: 146738356 USD
    “the Company capitalized a total of $146,738,356 and $61,427,524, respectively, of interest expense and loan acquisition costs”
  • tax abatement amendment: execution Amendment No. 1 to Second A&R Tax Abatement Agreement (eff. March 17, 2025); signed Sept. 8, 2025, Sept. 23, 2025, Sept. 29, 2025
    “Amendment No. 1 to Second Amended and Restated Tax Abatement Agreement ... signed 9/8/2025 ... 9/23/2025 ... 9/29/2025”
    grade A
  • tax abatement amendment: supersession Separate phase agreements dated Sept. 5, 2025 for Lessees 1/2 and 3 through 8 supersede the Second A&R agreement with respect to each leased parcel
    “The terms of that certain Tax Abatement Agreement (Phase 3) dated September 5, 2025 ... shall supersede the terms and conditions”
    grade A
  • tax abatement amendment: developer definition Developer definition amended to add Lancium Abilene Real Estate, LLC (with Rolling Plains EV Station LLC and Lancium Abilene, LLC)
    “Developer means Lancium LLC ... and its subsidiaries Rolling Plains EV Station LLC, Lancium Abilene, LLC, and Lancium Abilene Real Estate, LLC”
    grade A
  • Separate Phase 1/2 tax abatement agreement dated; Amendment No. 1 signed Sept. 8, 2025/23/29 splitting phases 1/2-8 into standalone agreements
    “Tax Abatement Agreement (Phase 1/2) dated September 5, 2025”
    grade A
  • tax abatement (TX Ch. 312): lineage Original agreement Dec. 21, 2021
    “Developer and City previously entered into that certain Tax Abatement Agreement dated December 21, 2021”
    grade A
  • tax abatement (TX Ch. 312): lineage Amended & Restated June 18, 2024; Second A&R effective March 17, 2025 (lessees DC 1,3,4,5,6,7,8 for up to 8 data center buildings)
    “Second Amended and Restated Tax Abatement Agreement effective March 17, 2025 between Lessee Abilene DC 3, 4, 5, 6, 7, 8 LLC”
    grade A
  • tax abatement (TX Ch. 312): execution Separate phase agreement executed (Docusign signatures Aug. 29, 2025 and Sept. 5, 2025; agreement dated Sept. 5, 2025 per Amendment No. 1)
    “Tax Abatement Agreement (Phase 1/2) dated September 5, 2025, by and between Developer, Lessee 1/2, and City”
    grade A
  • tax abatement (TX Ch. 312): reinvestment zone Second Reinvestment Zone No. RZ21-1; approx 941 acres in Abilene, Taylor County
    “Leased Parcel is located within the Second Reinvestment Zone No. RZ21-1 ... approximately 941-acre tract”
    grade A
  • tax abatement (TX Ch. 312): abatement percent 85 %
    “City hereby grants Lessee an abatement of eighty five percent (85%) of the Taxable Value of the Facility”
    grade A
  • tax abatement (TX Ch. 312): abatement term 10 consecutive years
    “for a period of ten (10) consecutive years, beginning with the First Year of Abatement for such Facility”
    grade A
  • tax abatement (TX Ch. 312): min investment 350000000 USD (minimum; target 500000000)
    “capital investment ... shall exceed Three Hundred Fifty Million ... ($350,000,000.00) (target ... $500,000,000.00) ... by March 31, 2026”
    grade A
  • tax abatement (TX Ch. 312): investment documentation Receipts/documentation of improvements due to City by June 30, 2026
    “submit to the City receipts or other documentation of said improvements or repairs on or before June 30, 2026”
    grade A
  • tax abatement (TX Ch. 312): completion deadline Completion of Construction of Facility (and certificate of occupancy for >=100,000 sq ft) on or before June 30, 2026
    “cause Completion of Construction of such Facility to occur on or before June 30, 2026”
    grade A
  • tax abatement (TX Ch. 312): commencement deadline Developer to cause Commencement of Construction of Improvements by Feb. 28, 2026
    “cause Commencement of Construction for Improvements on the Leased Parcel ... to occur by February 28, 2026”
    grade A
  • tax abatement (TX Ch. 312): min sq ft 100000 sq ft
    “Facility ... collectively containing a minimum of one hundred thousand (100,000) square feet of space”
    grade A
  • tax abatement (TX Ch. 312): min taxable value 200000000 USD (five-year rolling average)
    “minimum Taxable Value of Two Hundred Million ... ($200,000,000.00) over a five year rolling average”
    grade A
  • tax abatement (TX Ch. 312): jobs floor 57 FTE
    “on or before December 31, 2026 ... employ and maintain ... a minimum of Fifty-Seven (57) Full-Time Equivalent Employment Positions”
    grade A
  • tax abatement (TX Ch. 312): wage floor 57600 USD/yr average excl. benefits; 72000 incl. benefits
    “average wage (excluding benefits) ... at least $57,600.00 per year, and ... including benefits ... at least $72,000.00 per year”
    grade A
  • tax abatement (TX Ch. 312): compliance verification Annual Compliance Verification due from Feb. 1, 2027 annually incl. IRS 941 returns or TWC quarterly reports
    “Annual Compliance Verifications shall include quarterly IRS 941 returns, or Texas Workforce Commission Employer Quarterly Reports”
    grade A
  • tax abatement (TX Ch. 312): clawback Default: recapture of all abated taxes + interest at Tax Code §33.01 rate, payable 30 days after demand; constitutes tax lien; 30-day cure; no cross-defaults; $350M floor excused if F
    “the Defaulting Party shall, within thirty (30) days after demand, pay to the City all taxes which would otherwise been paid”
    grade A
  • tax abatement (TX Ch. 312): notice parties Lessee notices c/o Crusoe Energy Systems LLC (Denver); copies to Blue Owl Real Estate Capital (Chicago) and Oracle Corporation (Austin)
    “If to Lessee: Abilene DC 1, LLC c/o Crusoe Energy Systems LLC ... with copy to: Blue Owl Real Estate Capital ... Oracle Corporation”
    grade A
  • compute services (end customer): capacity not named MW (first GB200 rack delivery; MW not stated)
    “Oracle began delivering the first Nvidia GB200 racks last month and we recently began running early training and inference workloads”
  • Swap notional prior year: 459603884 USD
    “The notional amount of the swap equaled $2,261,773,483 and $459,603,884 as of December 31, 2025 and 2024, respectively.”
  • Lease execution date: Oct. 11, 2024
    “On October 11, 2024, the Company executed a lease with a hyperscale tenant to occupy 100% of the Investment.”
  • Tenant status: signed lease (executed Oct. 11, 2024)
    “Lease with a hyperscale tenant executed 2024-10-11 ... Buildings substantially completed and delivered to the tenant during 2025”
  • tenant lease: scope not named tenant identity
    “On October 11, 2024, the Company executed a lease with a hyperscale tenant to occupy 100% of the Investment.”
  • Lease for 100% of Abilene DC 1, LLC investment (two buildings, four data halls each, plus power station) executed with hyperscale tenant
    “Lease with a hyperscale tenant executed 2024-10-11 for 100% of the investment”
  • Groundbreaking date: June 2024 (construction start per TDLR TABS registration: June 1, 2024)
    “Start Date: 6/1/2024, Completion Date: 5/30/2025, Estimated Cost: $292,000,000 (Project Ludicrous Building 1)”
  • Construction start Building 1 (Project Ludicrous) per TDLR TABS registration; completion scheduled May 30, 2025; est. cost $292M
    “Start Date: 6/1/2024, Completion Date: 5/30/2025, Estimated Cost: $292,000,000”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 24, 2026 · Grantor: LANCIUM ABILENE REAL ESTATE LLC · Grantee: LANCIUM ABILENE LLC · Parcel number: 43890000500 · Address: OLD ANSON RD · City: ABILENE”
  • Tenants: Oracle Cloud Infrastructure (operator/tenant of delivered Phase 1 buildings) for OpenAI
    “tenant unnamed in exhibit; Oracle named in abatement notice copies and TX Comptroller occupancy records)”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Nov. 25, 2025 · Grantor: CRISTOFOR · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Nov. 25, 2025 · Grantor: TUCHER · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Nov. 25, 2025 · Grantor: TUCHER · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Nov. 25, 2025 · Grantor: QUINN · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Oct. 29, 2025 · Grantor: DONAGHEY · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Oct. 24, 2025 · Grantor: FOURNIER · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Oct. 14, 2025 · Grantor: LANCIUM ABILENE REAL ESTATE LLC · Grantee: LANCIUM SPONSOR II LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Oct. 2, 2025 · Grantor: CLEM · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 24, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Parcel number: 43890000500 · Address: OLD ANSON RD · City: ABILENE”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 5, 2025 · Grantor: CYCHOSZ · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 4, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Parcel number: 43890000700 · Address: 5614 SPINKS RD · City: ABILENE”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 4, 2025 · Grantor: LANCIUM ABILENE REAL ESTATE LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 4, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 29, 2025 · Grantor: BAUCUM · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 28, 2025 · Grantor: CLIFFORD · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 28, 2025 · Grantor: COWART · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 18, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 15, 2025 · Grantor: CARRANZA MARTINEZ · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: May 28, 2025 · Grantor: GAY · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: May 21, 2025 · Grantor: DAVIS · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: May 21, 2025 · Grantor: CORTEZ · Grantee: LANCIUM ABILENE REAL ESTATE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 3 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 4 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 5 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 6 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 7 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land lease (recorded document): contract value USD
    “Recorded: April 16, 2025 · Grantor: ABILENE DC 8 LLC · Grantee: ORACLE AMERICA INC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: April 14, 2025 · Grantor: BACKPORCH HOLDINGS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: April 3, 2025 · Grantor: SMITH · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 21, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: ABILENE DC 4 LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 21, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: ABILENE DC 5 LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 21, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: ABILENE DC 6 LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 21, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: ABILENE DC 7 LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: March 21, 2025 · Grantor: LANCIUM ABILENE LLC · Grantee: ABILENE DC 8 LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Jan. 29, 2025 · Grantor: TEXAS DIESEL TUNING LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Jan. 29, 2025 · Grantor: VALENZUELA · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Nov. 4, 2024 · Grantor: MCKNIGHT · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Sept. 26, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 30, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 30, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 27, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 27, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 27, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 27, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 27, 2024 · Grantor: ROLLING PLAINS EV STATIONS LLC · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 2, 2024 · Grantor: MOLLART · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Land purchase (recorded deed): contract value USD
    “Recorded: Aug. 2, 2024 · Grantor: LEMMONS · Grantee: LANCIUM ABILENE LLC · Address: 000 ADDRESS EXCEPTION · City: CITY EXCEPTION”
  • Financing: Press-only campus totals (inconsistent): $15B Blue Owl / Primary Digital JV; $11.6B debt+equity (Bisnow); JPMorgan $9.6B debt / $7.1B Phase 2 loan (CoStar/Newmark) USD
    “$15B Blue Owl / Primary Digital Infrastructure JV; $11.6B of debt and equity raised for the 1.2 GW campus”
    grade C
  • Opposition: Oracle appraisal protest vs Taylor CAD ~$200M 2025 valuation (filed 2025, press Jul 2025); resident opposition at Sep 2026 Abilene panel (water, energy bills, housing, transparency)
    “Several of the protestors held signs opposing data centers and calling for more transparency from local government”
  • phase delivery: delivery 200 MW IT (200MW+)
    “Developer Crusoe said that the first two buildings on the planned 1.2GW site are now operational and being used by Oracle Cloud Infrastructure (OCI) for OpenAI. The two buildings span 980,000 sq ft (91,045 sqm) and support 200MW+ of IT.”
  • phase delivery: delivery 1,200 MW total power capacity (campus gross)
    “This expansion plans to add six more buildings, bringing the total to approximately four million square feet, and a total power capacity of 1.2GW. It is expected to be completed in mid-2026.”
  • Buildings: 8 (2 live Phase 1 + 6 Phase 2 per company statements; contracts allow 10 phases) buildings
    “Crusoe's Abilene data center officially live serving Oracle and OpenAI's Stargate”
  • Aug 28, 2025 council amendments split the Feb 2025 abatement into per-building agreements for the eight buildings with executed leases (85 percent); Phases 9/10 are not in that set and were instead abated separately on D
    “the amendments reflect leases that have now been executed for each of the eight buildings”
  • Oracle protested Taylor County Appraisal District's ~$200M 2025 valuation of the Stargate site (Appraisal Review Board review); chief appraiser Gary Earnest; county auditor estimated ~$3M county revenue at stake. Note te
    “Earnest's appraisal valued the Stargate site at about $200 million for the 2025 tax year”
Permits and government (9)
  • transmission upgrade (TPIT): In-Service
    “Mulberry Creek: Construct New 345 kV Terminal. Interconnect the Lancium load to the Mulberry Creek 345 kV station.”
  • transmission upgrade (TPIT): Planned
    “Mulberry Creek: Expand 345 kV Station. Interconnect the Lancium load to the Mulberry Creek 345 kV station.”
  • transmission upgrade (TPIT): Planned
    “Jacaranda: Construct New 345 kV Station. Interconnect the Lancium load to the new Jacaranda 345 kV station and install two autotransformers.”
  • transmission upgrade (TPIT): Planned
    “Vitex: Construct New 345 kV Station. Interconnect the Lancium load to the new Vitex 345 kV station on the Bluff Creek to Mulberry Creek 345 kV line.”
  • Building registration: registration (review complete)
    “Facility Name: Building 02 (Tenant Improvement) ... approximately 484,960 SF ... Estimated Cost: $384,000,000”
  • Air, standard permit for electric generating units (BTM gas): modification application received
    “The electric generating units are currently permitted under Standard Permit Registration 177263 ... generate power for onsite use only”
  • Project Ludicrous, Building 2, 251 Lancium Way, Abilene TX 79601; new 1-story da: project registration (in-campus comparator, Building 2)
    “Project Name: Project Ludicrous Facility Name: Building 2 Location Address: 251 Lancium Way”
  • Building registration (architectural barriers / project registration): registration (review complete)
    “Project Name: Project Ludicrous Building 1 ... Square Footage: 482,000 ft2 ... Owner Name: Abilene DC 1, LLC”
  • CAMPUS EDGE construction stormwater coverage (TX CGP), Abilene TX; NOT confirmed: permit record in radius search
    “CAMPUS EDGE”
Site and other (16)
  • Data-center buildings on the map: 40
    Measured on OpenStreetMap map data.
  • Aliases: Lancium Clean Campus Abilene; Longhorn Data Center (TCEQ site name); Project Ludicrous (TDLR code name)
    “Site Name Longhorn Data Center ... Abilene DC 1, LLC (Abilene DC) dba Crusoe Energy Systems, LLC”
  • Stage: operating
    “Buildings substantially completed and delivered to the tenant during 2025 (audited) + Phase 1 live Sep 2025 (DCD)”
  • Abilene DC 1, LLC TX SoS filing history (File 805587707): Application for Registration 6/12/2024; Change of Registered Agent/Office 10/30/2024; Application for Amended Registration 11/5/2024 (same date as the management
    “TX SoS Business Organization Record, File Number 805587707: Abilene DC 1, LLC - Foreign Limited Liability Company, Jurisdiction DE, Foreign Formation Date 5/28/2024, Original Date of Filing 06/12/2024, Entity Status: In existence.”
  • at 32.50349306,-99.78310528; status Determined - No Hazard
    “175 ft AGL; submitted 08/24/2026”
    FAA · Aug. 2026 · grade A
  • Developer: Crusoe Energy Systems LLC (design/build/operate) on Lancium LLC land
    “Lessee notices c/o Crusoe Energy Systems LLC; Developer is the owner of the Leased Parcel (Lancium LLC)”
    grade A
  • Code names: Project Ludicrous (TDLR TABS registrations for Buildings 1-2)
    “Project Name: Project Ludicrous Building 1 ... Owner Name: Abilene DC 1, LLC”
  • Address: 351 Lancium Way (Building 1) / 251 Lancium Way (Building 2), Abilene, TX 79601; campus also addressed 5501-5502 Spinks Rd
    “Location Address: 351 Lancium Way, Abilene, TX 79601, Location County: Taylor ... Owner Name: Abilene DC 1, LLC”
  • Project company formed: May 28, 2024
    “for the period from May 28, 2024 (Inception) to December 31, 2024”
  • Crusoe (Ashby) hiring in Abilene, TX: Operations and Maintenance Technician II
    “Operations and Maintenance Technician II”
  • Crusoe (Ashby) hiring in Abilene, TX: Senior Commissioning Engineer, Mechanical
    “Senior Commissioning Engineer, Mechanical”
  • Crusoe (Ashby) hiring in Abilene, TX: Senior Staff Quality Control Engineer
    “Senior Staff Quality Control Engineer”
  • Construction stage: operating (Phase 1) with Phase 2 vertical/fit-out through 2026
    “Phase 1 live Sep 2025; Phase 2 remaining buildings ~Nov 2026 [E]”
  • Resident opposition visible at Abilene panel on AI boom: demonstrators with anti-data-center signs ('No More Backroom Data Center Deals'); concerns water, energy bills, housing costs, transparency
    “Abilene Resident Molly Cedillo held a sign saying, 'No More Backroom Data Center Deals.'”
  • Phase 1 (buildings 1-2) officially live serving Oracle/OpenAI (DCD)
    “Crusoe's Abilene data center officially live serving Oracle and OpenAI's Stargate”
  • Stargate program announced (Trump/Oval Office with SoftBank, OpenAI, Oracle); Abilene named as first site already under construction
    “President Donald Trump announced on Jan. 21, 2025, the formation of Stargate ... the first Stargate data centers are under construction in Abilene, Texas”

Imagery and records: Satellite imagery: Maxar via Esri World Imagery Wayback; Sentinel-2 (ESA Copernicus). County deeds: ATTOM.
